A trusted labour camp cabin supplier in Dubai provides MOHRE-compliant, heat-engineered prefabricated portacabins starting from AED 8,000 for a single sleeping unit and rising to AED 600,000+ for a fully operational 100-worker turnkey camp. Monthly costs run AED 500 to AED 1,500 per worker. Every cabin must meet a minimum of 3 sq.m of sleeping space per worker, mandatory air conditioning, fire safety systems, and registered sanitation under MOHRE Ministerial Resolution No. 44 of 2022. Setup takes 1 to 6 weeks depending on camp size. This guide covers every step – rules, costs, setup, and supplier selection.
Why Finding the Right Labour Camp Cabin Supplier in Dubai Matters More Than You Think
Your company wins a major construction tender in Dubai. Contracts are signed on a Thursday. By Sunday morning, the question lands on the project manager’s desk that nobody properly planned for: “Where do we legally house 300 workers before the first load of rebar arrives on site?”
This scenario plays out across Dubai every single week – and it catches even experienced contractors off guard. Unlike other GCC markets where temporary worker accommodation is a relatively simple procurement step, finding the right labour camp cabin supplier in Dubai means navigating a three-layer compliance structure that carries real financial penalties if you get it wrong.
Those three compliance layers are:
- MOHRE – the Ministry of Human Resources and Emiratisation, setting federal worker welfare and accommodation standards across the UAE.
- Dubai Municipality – enforcing structural safety, building permits, fire compliance, electrical standards, and sewage regulations at the emirate level.
- Free zone authorities – JAFZA, Trakhees, or TECOM, each adding project-specific approval requirements on top of both MOHRE and DM.
Layer in Dubai’s extreme summer climate – outdoor temperatures regularly exceeding 48°C between June and September – and the full picture becomes clear. A labour camp cabin in Dubai is not a metal box. It is a thermally managed, legally registered, government-inspected structure that must pass multi-authority scrutiny while keeping your workforce healthy, productive, and legally housed.
What this guide covers:
- What a labour camp cabin actually is – and the three distinct product types available in Dubai.
- Who needs one and how to make the buy-versus-rent decision correctly.
- Complete MOHRE, Dubai Municipality, and free zone compliance rules explained in full.
- Engineering and climate specifications every Dubai cabin must physically meet.
- A step-by-step setup process from site survey to MOHRE inspection sign-off.
- Real 2025–2026 cost tables – purchase prices, rental rates, and the hidden costs most projects miss.
- Zone-by-zone location guide covering Sonapur, DIP, Jebel Ali, Al Quoz, and Ras Al Khor.
- The eight costliest mistakes Dubai contractors make – and how to avoid every one of them.
- The 2025–2030 trend shift already reshaping the Dubai prefab accommodation market.
What Is a Labour Camp Cabin? Three Types Every Dubai Contractor Should Know
A labour camp cabin in Dubai is a prefabricated, modular accommodation unit manufactured off-site and installed on a designated plot to house construction, industrial, or logistics workers. These units are built with galvanized or mild steel frames and insulated sandwich panels, connected to DEWA power, municipal water, and sewage on-site, then configured into camp layouts covering sleeping quarters, bathroom blocks, kitchens, dining halls, and support facilities.
The Dubai market offers three distinct product types. Understanding which one fits your project is a decision that must happen before you contact a single portacabin supplier in Dubai.

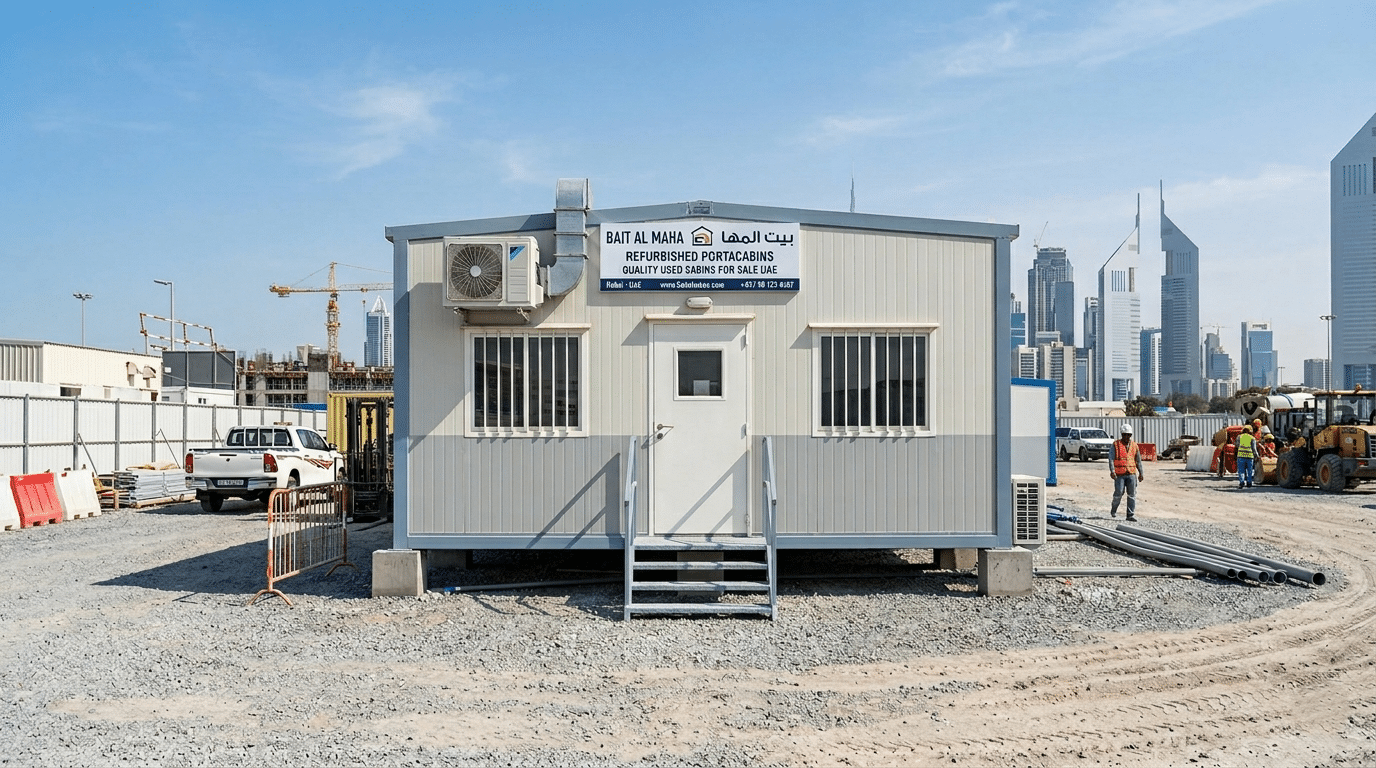

Portacabins (Modular and Fully Relocatable)
Portacabins are the workhorse of the Dubai labour camp market. These are steel-framed, sandwich panel-insulated units designed to be craned onto flatbed trucks and redeployed across multiple project sites over their working life.
Standard available sizes and their primary uses:
- 3m × 6m – most common for small sleeping bays, security rooms, and site supervisor offices.
- 3m × 9m – mid-range units used for bathroom blocks and compact dining areas.
- 3m × 12m – larger sleeping quarters capable of housing 16 to 20 workers per unit.
Key advantages of portacabins for Dubai projects:
- Fully relocatable – crane on, truck off, and redeploy to the next project site.
- Fast installation – most standard units can be placed and connected within days.
- Scalable – additional units are added as headcount grows without major ground work.
- Widely available for both purchase and short-term rental across Dubai.
When relocatability creates real value: When your Al Quoz project finishes, the cabins are craned onto flatbeds and move directly to your Jebel Ali project. For contractors running sequential or simultaneous projects, this is a genuine financial asset. For single-project buyers with no confirmed second deployment, the purchase economics need careful evaluation against the rental alternative.
Prefabricated Permanent Structures
These are bolted or welded semi-permanent buildings constructed on concrete foundations and not intended to be moved once installed. They cost more upfront, require a full Dubai Municipality building permit, and are typically specified for camps running two or more years on a fixed site.
Key characteristics of prefabricated permanent structures:
- Higher construction quality and thicker insulation as standard.
- Better natural alignment with MOHRE space and ventilation standards due to larger room dimensions.
- Requires DM building permit submission before any ground work begins.
- Offers a higher quality of living environment, which supports worker retention on long projects.
- Best suited for mega project operators and main contractors with a confirmed multi-year project pipeline on a single site.
Container Conversions
ISO shipping container repurposing is a growing trend in Dubai’s southern industrial zones – particularly Dubai Investment Park (DIP), Jebel Ali, and Ras Al Khor. Containers are structurally robust, stackable into two- and three-storey configurations, and comparatively cost-effective to source.
Advantages of container conversions:
- Structurally strong – ISO containers are built to carry 25+ tonnes of stacked load.
- Stackable – can be configured into multi-storey camp layouts on compact sites.
- Cost-effective to acquire compared to purpose-built cabin structures.
- Suitable for remote or rugged industrial sites where durability is the priority.
The critical compliance point every buyer must understand: A converted container must meet exactly the same MOHRE insulation, ventilation, and sleeping space standards as any other accommodation structure. Raw, uninsulated containers fail inspection immediately. Dubai Municipality inspectors specifically look for this shortcut. Any container conversion used for worker accommodation must have full sandwich panel wall lining, mechanical ventilation, and certified AC systems before it is legally occupiable.
You can explore the full range of containerized and prefab cabin options – including labour residence cabins, site office cabins, kitchen and mess hall units, and toilet blocks – to compare specifications before approaching any supplier.
The Distinction That Costs Contractors Real Money Every Year
There is one terminology confusion that generates financial surprises on Dubai projects every year – the difference between a cabin supplier and a camp operator.
What this means in practice:
- A supplier who delivers excellent cabins will not automatically manage your DEWA connection.
- A supplier will not submit your MOHRE accommodation registration unless it is explicitly in their service scope.
- Many projects require both a cabin supplier and a camp operator – and they are not interchangeable.
Clarify in writing exactly which scope each party is responsible for before signing any agreement.
Who Needs a Labour Camp Cabin in Dubai? And What Type Fits Your Project?
Labour camp cabins in Dubai are required by any company employing workers who cannot practically be housed in city accommodation.
The industries most commonly affected include:
- Construction and civil infrastructure.
- Oil and gas operations across onshore and offshore sites.
- Manufacturing and light industry in Dubai’s industrial zones.
- Logistics, warehousing, and port operations.
- Facility management and large-scale cleaning services.
- Healthcare and infrastructure project contractors.
The right solution depends on your worker count, project duration, budget structure, and site location.
Matching Your Camp Solution to Worker Count
Large main contractors – 300 to 2,000+ workers
These operations require a full modular labour camp ecosystem, including:
- Sleeping blocks (minimum 3 sq.m per worker sleeping area).
- Dedicated ablution blocks (1 bathroom unit per 8 to 10 workers).
- A commercial kitchen and dining hall (1.5 sq.m per simultaneous diner).
- Laundry facilities (1 machine or trough per 15 workers).
- Recreational areas (required by MOHRE for camps of 500+ workers).
- A small on-site medical room with first-aid supplies.
At this scale and project duration, purchasing is almost always the better financial decision, provided cabins have a confirmed redeployment plan after the project ends.
Mid-size subcontractors – 50 to 300 workers
This is the most common buyer profile in Dubai’s construction market. Modular portacabin clusters work effectively here – scalable as headcount grows, and relocatable when the project completes. Both purchase and rental are financially viable depending on the project length.
Small contractors or short-term projects – 20 to 50 workers
At this scale and duration, renting from an established labour camp cabin supplier in Dubai is almost always the better financial decision. The per-cabin rental market is active and well-supplied, and the capital savings versus purchasing are significant when the project runs under twelve months.
Free zone operators – variable headcount
Companies working within JAFZA, DIP, TECOM, or Trakhees-governed areas face an additional compliance layer on top of standard MOHRE and Dubai Municipality requirements. Each free zone runs its own HSE accommodation approval process, which can add two to four weeks to your mobilisation timeline if not initiated on day one.
Should You Buy, Rent, or Lease? The 3-Factor Decision Guide
Workforce Stability
- Fluctuating headcount → Rent. Flexibility to scale units up or down without owning idle cabins is worth the rental premium.
- Fixed, predictable workforce → Buy. Operational certainty over the full project life justifies the capital commitment.
Budget Structure
- CAPEX-constrained → Rent. Preserve upfront capital and manage accommodation as a monthly operating cost.
- OPEX-constrained → Buy. Deploy available capital now to reduce the monthly cost burden across the full project duration.
Dubai Labour Camp Rules – MOHRE, Dubai Municipality, and Free Zone Authorities Fully Explained
Dubai labour camp rules operate at three distinct levels. MOHRE sets federal worker welfare standards. Dubai Municipality enforces structural and safety permits at the emirate level. Free zone authorities – JAFZA, Trakhees, and TECOM – impose additional project-level requirements on top of both. Non-compliance can result in fines of up to AED 50,000 per violation per worker, and in serious cases, complete project work permit suspension.
MOHRE Standards – The Federal Compliance Foundation
The primary legislation governing worker accommodation in Dubai and across the UAE is Ministerial Resolution No. 44 of 2022 Regarding Occupational Health and Safety and Labour Accommodation, in effect since February 2022.
Supporting legislation that also applies:
- Cabinet Resolution No. 13 of 2009 – General Standards for Collective Labour Housing for camps of 500 or more workers.
- Ministerial Decree No. 212 of 2014 – Standards Manual for camps housing fewer than 500 workers.
- Administrative Decision No. 19 of 2023 – Additional occupational safety and accommodation requirements.
Who must comply: Under Ministerial Resolution No. 44 of 2022, establishments employing 50 or more workers earning AED 1,500 or less per month must provide registered accommodation and register through the MOHRE Labour Accommodation System at mohre.gov.ae.
The complete MOHRE compliance checklist for every labour camp cabin in Dubai:
- Minimum 3 sq.m of sleeping area per worker – sleeping floor space measured around each bed only; bathroom and corridor areas do not count.
- 1 bathroom unit per 8 to 10 workers – each unit comprising a toilet, shower, and washbasin.
- Minimum dining space of 1.5 sq.m per worker eating simultaneously in the dining hall.
- Laundry facilities – minimum one washing machine or laundry trough per 15 workers.
- Company signage in both Arabic and English displayed on the building exterior.
- A designated camp manager (welfare officer) appointed for all camps of 50 or more workers.
- Non-flammable building materials used throughout the cabin structure and roof.
- Sufficient lighting – natural and artificial – in all sleeping, dining, bathroom, and common areas.
Compliance growth since 2022: Since the MOHRE Labour Accommodation System launched in February 2022, registered compliance among private sector companies increased by 1,000% by the end of 2023, according to MOHRE’s published data. That figure signals two things: enforcement has intensified dramatically, and a significant portion of the market was previously operating outside the law.
Dubai Municipality Standards – The Structural and Safety Layer
MOHRE governs welfare standards. Dubai Municipality governs the physical installation, structural integrity, and safety systems. Both layers must be satisfied before a single worker is legally permitted to move in.
Key Dubai Municipality requirements for labour camp cabin installations:
- Building permit – Required for any semi-permanent or permanent cabin structure before any ground work begins. DM permit processing cannot be accelerated. Starting it late is the single most common cause of timeline overrun in Dubai camp setup.
- Fire safety compliance – Tiered by camp size:
- All camps: fire extinguishers in each sleeping cabin, heat and smoke detectors throughout.
- Larger camps: interconnected alarm systems.
- Above specified occupancy levels: full sprinkler or FM-200 suppression systems required.
- Civil Defence certificate – The Dubai Civil Defence authority issues fire safety compliance certificates independently. Both DCD and DM sign-offs are required before workers move in.
- Sewage and wastewater – Camp sewage must connect to the DM municipal sewage network or a DM-certified septic tank with licensed waste removal. Open drainage is entirely illegal and is among the most common primary inspection failure points.
Free Zone Authorities – The Third Compliance Layer
If your project falls within any free zone boundary, a third authority must approve your accommodation setup before it is legally operational.
The practical rule for free zone projects:
- Identify the relevant free zone authority on day one of project planning.
- Start their approval process in parallel with Dubai Municipality – never after.
- Running these approvals sequentially rather than simultaneously costs two to four weeks that most mobilisation schedules cannot absorb.
What Happens When You Do Not Comply?
Financial penalties:
- Fines range from AED 5,000 to AED 50,000 per violation per worker, depending on the severity and nature of the non-compliance.
- Space violations – sleeping area below the 3 sq.m minimum – attract the highest individual fines in the MOHRE penalty framework.
Operational consequences:
- Dubai Municipality can freeze new work permit issuances to any company with outstanding accommodation violations.
- Persistent or severe violations result in project suspension notices – a full stop on all construction activity until accommodation is remediated and re-inspected.
- Suspension of a 200-worker project for two weeks can cost far more in lost productivity than the compliance investment would have.
Complaint-triggered inspections:
- Workers report accommodation issues directly to the MOHRE hotline at 800MOHRE (800 64673).
- Complaints trigger priority inspections within 48 to 72 hours – typically unannounced.
- Since MOHRE’s complaint systems became accessible via mobile platforms, the volume and speed of complaint-triggered inspections has increased significantly.
Reputational and commercial consequences:
- Both DM and MOHRE maintain digital violation records visible to other authorities during future permit and tender processing.
- Companies with documented violation histories are increasingly disqualified from public sector tenders.
- International clients operating ESG reporting frameworks are auditing worker accommodation standards as part of supply chain due diligence. A violation record surfaces in these audits and can cost contracts with major developers.
Engineering Standards for Dubai’s Climate – What Your Labour Camp Cabin Must Physically Withstand
Labour camp cabins in Dubai must withstand:
- Summer temperatures exceeding 48°C from June to September.
- Coastal humidity at sea-facing and creek-adjacent sites.
- Sand-laden shamal winds at high velocity.
- Structural wind loads at UAE design speeds of 45 metres per second.
A standard portacabin specification designed for a European or South Asian climate is not adequate in this environment without significant modification. Dubai Municipality inspectors know the difference.
Sandwich Panel Insulation – The Most Important Specification Decision You Will Make
The wall and roof panels are the single biggest determinant of thermal performance in any prefab labour camp cabin in Dubai. Every cabin uses sandwich panels, but the core material and thickness determine whether your AC system can maintain 24°C on a July afternoon or runs at maximum capacity and still fails.
Sandwich panel comparison table for Dubai conditions:
| Panel Type | Core Material | Thickness | Thermal Rating | Dubai Suitability |
| Basic EPS | Expanded Polystyrene | 50mm | Low | Storage cabins only. Fails MOHRE worker accommodation compliance in peak summer. |
| Mid-grade EPS | Expanded Polystyrene | 75mm | Medium | Acceptable with oversized AC units. Electricity costs will be significantly higher. |
| PU Core | Polyurethane | 75mm | High | Recommended standard for sleeping quarters in Dubai. |
| PIR Core | Polyisocyanurate | 100mm | Highest | Best choice for large camps. Reduces AC energy consumption by 25 to 30%. |
What to ask every labour camp cabin supplier in Dubai before signing:
- What is the exact U-value of your standard insulation panel?
- What core material does it use – EPS, PU, or PIR?
- What is the panel thickness – 50mm, 75mm, or 100mm?
- Are these figures confirmed in the written purchase agreement?
Never accept “insulated panels” as a specification. Insist on the core material, thickness, and U-value confirmed in writing.
Air Conditioning Sizing – What Actually Works in a Dubai Summer
The practical sizing rule for UAE camp designers: 1.5-ton inverter split unit per 20 sq.m of occupied sleeping space.
AC specification choices and their consequences:
- DC inverter units – energy-efficient, variable speed, lower electricity bills over a full summer season. Strongly preferred for all Dubai labour camps.
- Fixed-speed units – higher electricity consumption at equivalent cooling output. Avoid where project duration exceeds six months.
- Unshaded outdoor condensers – lose 20 to 30% of cooling efficiency in direct August sun. A basic steel shade canopy over each outdoor unit costs a fraction of one month’s wasted electricity and is consistently overlooked.
Monthly electricity impact: A 100-worker camp running fixed-speed AC units through a Dubai summer month can consume 30,000 to 50,000 kWh more electricity than an equivalent inverter-equipped camp. Over a 12-week summer season, this difference runs into tens of thousands of dirhams.
Structural Requirements – Frames, Foundations, and Wind Loading
Critical structural specifications for Dubai conditions:
- Wind load certification – UAE design wind speed is 45 metres per second. Every cabin frame must be certified to withstand this load.
- Galvanized steel frames for coastal sites – Mandatory for any site within approximately 3 kilometres of the sea, the Creek, or any harbour. Mild steel corrodes in coastal humidity within 12 to 18 months.
- Raised flooring – In clay-heavy soil areas like Sonapur (Al Muhaisnah), cabins must sit a minimum of 150mm above ground level. Anti-slip surfaces required in bathrooms and all wet areas.
- Foundation type must match soil conditions – Rocky ground, clay soil, and compacted gravel have different load-bearing characteristics.
Foundation options for Dubai sites:
| Foundation Type | Best Suited For | Cost Level |
| Concrete plinths | Semi-permanent camps on level, stable ground. | Higher upfront. |
| Steel base frames | Uneven or rocky terrain, adjustable installation. | Mid-range. |
| Compacted gravel beds | Short-term camps on stable, dry ground only. Not for coastal sites. | Lowest. |
Ventilation – Why Passive Airflow Fails Above 35°C
Passive cross-ventilation – windows on opposing walls, no mechanical assistance – is sufficient in temperate climates and during Dubai’s winter months. Above 35°C ambient temperature, it moves hot air through the cabin without reducing heat stress.
Minimum mechanical ventilation requirements for compliant Dubai labour camp cabins:
- Exhaust fans in every sleeping bay – minimum one per occupied room.
- Exhaust fans in every bathroom block – minimum one per bathroom unit.
- Kitchen ventilation on a separate exhaust circuit – never shared with any sleeping cabin HVAC system.
- Commercial-grade exhaust hoods over all cooking equipment in the kitchen block.
- Regular maintenance – filters cleaned monthly, fan performance checked quarterly.
How to Set Up a Labour Camp Cabin in Dubai – A Complete Step-by-Step Process
Setting up a labour camp cabin in Dubai follows four sequential phases:
- Pre-setup planning and authority approvals (Weeks 1 to 2).
- Site preparation – ground work and utility connections (Weeks 2 to 3).
- Cabin delivery, installation, and MEP commissioning (Weeks 3 to 4).
- Final MOHRE and Dubai Municipality inspection sign-off before worker move-in.
The most important rule of Dubai camp mobilisation: Authority approvals started late become the critical path item sitting between your cabins being physically ready and your workers being legally permitted to occupy them. Always start the approvals in Week 1 – never after the cabins are ordered.
Pre-Setup Planning (Weeks 1–2)
Conduct a Thorough Site Survey
Visit the site with an MEP engineer before ordering any cabin. The survey must document:
- Soil type and condition – determines foundation approach and preparation cost.
- DEWA connection points – whether an LV supply already exists or needs to be drawn from the nearest point.
- Sewage network access – municipal connection feasibility or certified septic system requirement.
- Available plot area – measured against your headcount and MOHRE space calculations.
- Proximity to the sea or humid zones – determines whether galvanized steel frames are mandatory.
Calculate Headcount and Plan the Camp Layout
Calculate total built area required using MOHRE minimum figures:
- Sleeping areas: 3 sq.m per worker (sleeping space definition only, not total room area).
- Bathroom blocks: 1 unit per 8 to 10 workers (toilet + shower + washbasin per unit).
- Dining area: 1.5 sq.m per worker eating simultaneously.
- Kitchen, laundry, and recreational areas: calculated separately based on total camp occupancy.
Submit the site layout drawing to Dubai Municipality as part of the building permit application.
Submit All Authority Applications Simultaneously
Do not wait to complete one application before starting the next. Submit all three in the same week:
- Dubai Municipality building permit application.
- MOHRE Labour Accommodation System registration at la.mohre.gov.ae.
- Free zone authority approval where applicable – JAFZA, Trakhees, or TECOM.
Running these in parallel rather than in sequence saves two to four weeks on your mobilisation timeline.
Issue RFQs to Minimum Three Suppliers
Send a Request for Quotation to at least three suppliers, each with a full technical specification attached covering:
- Panel type, core material, and minimum U-value required.
- Frame material – galvanized or mild steel specified clearly.
- AC capacity – ton rating and inverter or fixed-speed type required.
- Flooring specification – raised height, anti-slip surface material.
- Warranty terms required – structural (minimum 12 months) and MEP (minimum 6 months).
Quotes without a matching specification sheet are not comparable. Like-for-like comparison is only possible when all suppliers quote on identical specifications.
Site Preparation (Weeks 2–3)
Ground Levelling and Compaction
The site must be levelled and compacted to a minimum California Bearing Ratio (CBR) value capable of supporting the cabin base load. On clay-heavy soil common in Sonapur and Muhaisnah, this sometimes requires significant rework. Discovering inadequate ground conditions after cabin delivery is one of the most commonly reported and most avoidable delays in Dubai camp mobilisation.
Choose the Correct Foundation Type
Select the foundation system that matches your ground conditions:
- Concrete plinths – most robust option, highest upfront cost. Best for semi-permanent camps on level, stable ground.
- Steel base frames – faster to install, adjustable for uneven or rocky terrain. Preferred where ground conditions are variable.
- Compacted gravel beds – lowest cost option. Appropriate for short-term camps on stable dry ground only. Not recommended for coastal sites or clay-heavy soil.
Utility Trenching
Excavate and install the following services before any cabin is placed on site:
- Water supply line from the nearest municipal connection point.
- Sewage outlet pipe running to the municipal network or certified septic tank.
- DEWA LV electrical cable from the approved connection point.
Get DEWA’s technical requirements for the electrical supply in writing before trenching begins. The trench depth and cable specifications are prescribed by DEWA and must be followed exactly for the connection inspection to pass.
Install Perimeter Fencing and Security Gate
Dubai Municipality requires all organised labour camps to have:
- A clearly defined perimeter boundary with solid fencing.
- A controlled entry point with a lockable gate.
- Clear access for emergency vehicles.
Install the perimeter fence and security gate before the DM structural inspection. This is a standard DM checklist item.
Cabin Delivery and Installation (Weeks 3–4)
Coordinate Delivery Logistics
Confirm the following before the first delivery truck arrives on site:
- A crane or forklift of sufficient lifting capacity is booked and on-site.
- Site access routes can accommodate delivery vehicle dimensions and turning circles.
- A banksman and certified lifting supervisor are present during all crane operations.
- For two-storey configurations, crane availability is confirmed in advance – not assumed.
Follow the Correct Assembly Sequence
Install in this order without skipping steps:
- Steel base frame installation and levelling.
- Insulated wall panel assembly.
- Roof panel installation and waterproofing.
- Door and window frame fitting.
- Internal partition walls where required.
- MEP fit-out – electrical, plumbing, AC, and ventilation.
Do not commission AC units before the building envelope is fully sealed. Running split units in an open or partially assembled frame wastes electricity and risks compressor damage.
MEP Commissioning
Test every system before calling for inspection:
- AC split units – verify cooling output and temperature hold at 24°C.
- Electrical distribution boards – test all circuits, RCDs, and earthing connections.
- Interior lighting – confirm adequate illumination in all sleeping, bathroom, kitchen, and common areas.
- Bathroom plumbing – check water pressure, drainage flow, and all fixtures.
- Kitchen connections – verify cooking equipment is safely connected and exhaust is functioning correctly.
Fire Safety Installation and Civil Defence Sign-Off
Install all required fire safety equipment before calling for any inspection:
- Fire extinguishers in each sleeping cabin and all common areas.
- Smoke and heat detectors throughout the camp.
- Emergency exit lighting on all evacuation routes.
- Sprinkler or FM-200 suppression systems where required by occupancy threshold.
Request the Dubai Civil Defence inspection and obtain their sign-off certificate. Civil Defence clearance is a prerequisite for DM final approval.
Inspections and Operational Readiness
MOHRE Accommodation Inspection
Submit the inspection request through the MOHRE portal. Inspectors will check:
- Sleeping area per worker – measured against the 3 sq.m sleeping space definition.
- Bathroom ratios per total worker count.
- AC functionality and indoor temperature at or below 24°C.
- Kitchen and laundry provision – equipment and capacity confirmed.
- Building material compliance – non-flammable confirmation.
- Documentation completeness – all permits, registrations, and contracts on file.
Dubai Municipality Final Inspection
DM inspectors verify:
- Structural compliance with the approved building permit drawings.
- Civil Defence fire safety clearance certificate on file.
- Electrical installation quality and DEWA compliance.
- Sewage connection confirmation to municipal network or certified septic system.
Setup Timeline at a Glance:
| Camp Size | Estimated Total Timeline | Critical Path Item |
| Under 50 workers | 1 to 2 weeks | MOHRE registration timing. |
| 50 to 200 workers | 3 to 4 weeks | DM permit and DEWA connection. |
| 200 to 500 workers | 5 to 6 weeks | Authority approvals and site preparation. |
| 500+ workers (full camp) | 6 to 10 weeks | All authorities in parallel from Week 1. |
Labour Camp Cabin Cost in Dubai – Complete Pricing Guide
Labour camp cabin costs in Dubai range from AED 8,000 for a basic single sleeping unit to AED 600,000+ for a fully operational 100-worker turnkey camp. Monthly rental runs AED 800 to AED 2,500 per cabin, or AED 500 to AED 1,500 per person in a fully managed, all-inclusive facility. Hidden costs – site preparation, DEWA connection, compliance fees, furniture, and operations – typically add 30 to 40% on top of the cabin purchase price.
Purchase Price by Cabin Type 2026 UAE Market Rates
| Cabin Type | Dimensions | Capacity | Price Range (AED) | Best For |
| Basic sleeping cabin (EPS 50mm) | 3m × 6m | 8–10 workers | 8,000–14,000 | Short-term, inland, non-coastal sites only. |
| Standard insulated cabin (EPS 75mm) | 3m × 6m | 8–10 workers | 14,000–22,000 | General construction camps across Dubai. |
| Premium PU panel cabin | 3m × 12m | 16–20 workers | 35,000–55,000 | Long-term camps and high-heat exposure zones. |
| 2-storey modular block | Custom | 40–60 workers | 120,000–200,000 | Large contractor camps requiring density. |
| Full turnkey camp (100 workers) | Site-specific | 100 workers | 350,000–600,000 | Main contractor full mobilisation. |
| Full turnkey camp (500 workers) | Site-specific | 500 workers | 1,800,000–3,000,000 | Mega project operators with long pipelines. |
Monthly Rental Cost Structure
| Rental Type | Monthly Cost (AED) | What Is Included |
| Per cabin – unit only | 800–1,500 | Cabin structure only, no management. |
| Per cabin – fitted with AC | 1,200–2,500 | Cabin with AC installed and serviced. |
| Per person – managed camp | 500–900 | Cabin, bed, and utilities. |
| Per person – full-service camp | 1,000–1,500 | Cabin, utilities, meals, and daily cleaning. |
Why the per-person monthly range is wide – the key variables:
- Location: Sonapur pricing typically runs 20 to 30% lower than Dubai Investment Park for equivalent facilities.
- AC specification: Fixed-speed versus inverter units affect electricity costs, which are sometimes included or passed through separately in the rental rate.
- Meal inclusion: A self-catering camp and a full-board managed facility are fundamentally different services.
- Camp size: Larger camps spread fixed overhead costs – management, utilities infrastructure, maintenance – across more workers, reducing the per-person rate.
- Contract duration: Longer rental contracts typically attract lower monthly rates than short-term or month-to-month arrangements.
Hidden and Ongoing Costs – What Most Projects Miss
Add every item in this table to your financial model before signing any purchase order. These are not contingency items. They are predictable, quantifiable costs that experienced camp operators budget for and first-time buyers consistently miss.
| Cost Item | Type | Estimated Range (AED) |
| DEWA connection fee | One-time | 3,000–8,000 |
| DEWA security deposit (refundable at project end) | One-time | 5,000–20,000 |
| Site levelling, compaction, and drainage | One-time | 15,000–80,000 |
| Foundation work – concrete plinths or steel base | One-time | 8,000–40,000 |
| MOHRE accommodation registration | One-time per unit | 300–500 |
| Dubai Municipality building permit | One-time | 2,000–10,000 |
| Fire safety system installation | One-time | 5,000–25,000 |
| Perimeter fencing and security gate | One-time | 8,000–30,000 |
| Cabin furniture and FF&E per worker | One-time | 800–2,500 per worker |
| Monthly DEWA – electricity and water | Monthly | 150–300 per worker |
| Annual maintenance reserve | Ongoing | 5–8% of cabin value per year |
| Camp manager salary | Monthly | 3,000–6,000 |
| Pest control and cleaning contracts | Monthly | 500–2,000 per camp |
The real-cost rule of thumb: Add 30 to 40% on top of the cabin purchase price to calculate the true mobilisation cost. A 100-worker camp with AED 400,000 in cabin costs will require AED 520,000 to AED 560,000 in total before the first worker sleeps there.
Buy vs. Rent – The Financial Decision at a Glance
The break-even point is approximately 18 to 24 months for a standard 100-worker setup.
Renting makes more financial sense when:
- Project duration is under 12 months.
- Worker headcount is expected to fluctuate significantly.
- The site is in a free zone with restrictions on permanent structures.
- Your company is CAPEX-constrained with available monthly budget.
- This is your first Dubai camp setup and compliance risk management is still being built internally.
Buying makes more financial sense when:
- Project duration is 24 months or longer.
- Workforce size is stable and predictable throughout the project.
- Cabins can be relocated to a confirmed next project site at the end of the current one.
- Your company runs multiple simultaneous or sequential projects with ongoing accommodation needs.
- Your company is OPEX-constrained but has capital available for deployment.
For a closer look at specifications and pricing across different cabin sizes and insulation grades, the prefab products range covers labour residence cabins, kitchen and dining units, toilet blocks, and modular multi-storey accommodation blocks – which helps compare options before entering supplier negotiations.
How to Evaluate a Labour Camp Cabin Supplier in Dubai – A Practical Framework
Choosing the wrong labour camp cabin supplier in Dubai is not just a procurement error – it is a compliance risk that can delay your project and expose your company to MOHRE fines. Use this framework before committing.
The 4 Non-Negotiable Supplier Checks
Before requesting a quote from any portacabin supplier in Dubai, verify all four of these independently:
- Valid UAE Trade License – Check on the DED portal. A supplier without a current license cannot provide an enforceable warranty or be pursued legally if the product fails.
- ISO 9001 certification for manufacturing – Covers quality management across design, production, and delivery. Ask for the certificate number and verify it is current.
- Documented MOHRE-registered camp installations – Ask for a UAE project reference list with direct contact details. A supplier genuinely experienced with compliant Dubai camps will provide this without hesitation.
- Written warranty terms – Minimum 12 months structural and 6 months MEP, confirmed in the contract – not in a sales conversation.
5 Red Flags – Walk Away If You See Any of These
- No physical showroom, factory, or completed project site visit is offered before purchase.
- The supplier cannot produce a panel specification sheet with U-value figures.
- Payment is demanded 100% upfront with no milestone-based payment structure.
- MOHRE accommodation registration support is absent from the written service scope.
- The supplier cannot provide direct contact details for UAE reference clients from projects of similar scale to yours.
8 Questions to Ask Any Labour Camp Cabin Supplier Before Signing
These questions reveal more about a supplier’s genuine capability than any brochure or website:
- What is the U-value of your standard insulation panel, and what core material does it use?
- Are your steel frames mild steel or galvanized – and what corrosion warranty covers coastal sites?
- Do you handle MOHRE accommodation registration on our behalf, or is that entirely our responsibility?
- What is your production lead time from purchase order to site delivery?
- Can you provide direct contact details for UAE clients from completed camps of similar size to ours?
- What does your warranty cover specifically – and what conditions void it?
- Do you provide on-site support during MOHRE or Dubai Municipality inspection?
- What is your payment milestone structure, and what percentage is required as the initial deposit?
Reviewing a supplier’s completed projects portfolio before an on-site visit gives you a clearer sense of their delivery consistency across different camp types and project scales – something no quote document can convey on its own.
Where to Set Up a Labour Camp in Dubai – Zone-by-Zone Location Guide
Camp location should match the geographical cluster of your active project sites. Commute time is a MOHRE welfare compliance factor – not merely a logistics preference. A camp located more than 45 minutes from the primary worksite is a welfare flag that inspectors have specifically raised in response to worker complaints.
Zone-by-Zone Overview
| Zone | Cost Level | Best For | Authority |
| Sonapur (Al Muhaisnah) | Lower | Large main contractor camps; North Dubai and Deira projects. | Dubai Municipality. |
| Dubai Investment Park (DIP) | Medium to High | Southern Dubai – Expo City, DWC, Al Maktoum area. | DIP Authority. |
| Jebel Ali / JAFZA | High | Port workers, logistics, JAFZA-based operations. | JAFZA. |
| Ras Al Khor | Medium | Manufacturing, light industry, Creek corridor projects. | Dubai Municipality. |
| Al Quoz Industrial | Limited | Small on-site security and supervisory cabins only. | Dubai Municipality. |
Sonapur (Al Muhaisnah) – Established, High Capacity, Lower Cost
Sonapur is Dubai’s most established and highest-capacity labour accommodation zone, located in the Muhaisnah district near Al Qusais. It provides direct access to Sheikh Mohammed Bin Zayed Road and Emirates Road.
Key characteristics of Sonapur as a camp location:
- Rental costs typically 20 to 30% lower than DIP for equivalent facilities.
- Well-established support infrastructure – markets, clinics, banks, mosques, and money exchange centres within walking distance of major camp clusters.
- Active public transport connections – multiple bus routes with metro access a short transfer away.
- Older camp stock requires careful compliance inspection before selection, particularly on fire safety and sleeping space standards.
- Suitable for large teams serving Deira, North Dubai, and the northern industrial belt.
Dubai Investment Park (DIP) – Modern, Compliant, Higher Cost
DIP is the preferred zone for contractors working on southern Dubai projects – the former Expo City site, Al Maktoum International Airport expansion, Dubai South, and the logistics clusters in the area.
Key characteristics of DIP as a camp location:
- Higher rental rates – 20 to 30% above Sonapur for comparable facilities.
- Newer building stock with better alignment to current MOHRE and DM standards.
- DIP Authority adds a green building compliance layer beyond standard DM requirements.
- Proximity to southern Dubai project clusters reduces worker commute times significantly.
- Preferred by international contractors operating under ESG reporting frameworks.
The Commute-Time Compliance Factor That Nobody Talks About
MOHRE’s worker welfare standards include reasonable commute time as a component of overall accommodation suitability. A camp located more than 45 minutes from the primary project site is a welfare flag – and long daily commutes in high ambient heat are a documented occupational safety risk on UAE construction sites.
The practical location matching rule:
- North Dubai and Deira projects → Sonapur or Muhaisnah.
- Southern Dubai and airport area projects → Dubai Investment Park.
- JAFZA and port projects → Jebel Ali corridor.
- Ras Al Khor and Creek-side projects → Ras Al Khor industrial zone.
Understanding which accommodation cabin configuration fits each zone – in terms of cabin type, insulation grade, foundation system, and utility connection approach – is part of what experienced prefab suppliers in Dubai advise on as part of their service, not just the physical structure.
8 Costly Mistakes When Setting Up a Labour Camp Cabin in Dubai
Every mistake below is avoidable. Every one of them has a financial consequence that exceeded the cost of getting it right first time.
Misapplying the MOHRE 3 sq.m Sleeping Space Calculation
What happens: Many contractors calculate total room floor area and divide by the number of beds. MOHRE calculates the usable sleeping space around each bed – a smaller figure once bed frame dimensions, wall clearances, and the walkway between bunks are subtracted.
The result: A cabin physically containing 20 beds often only complies for 12 workers under MOHRE’s measurement method.
How to avoid it: Specify cabins around the MOHRE sleeping space definition, not the room’s gross floor area. Ask your supplier to confirm MOHRE-calculated worker capacity, not physical bed count.
Skipping the Pre-Installation Site Survey
What happens: Site needing AED 40,000 to AED 80,000 of ground preparation is discovered after cabins are already delivered.
Common causes: Rocky ground requiring breaking, clay soil needing drainage works, or no DEWA infrastructure within practical connection distance.
How to avoid it: Conduct a full site survey with an MEP engineer in Week 1. The survey costs a fraction of one day’s project delay.
Using Mild Steel Frames on Coastal or Humid Sites
What happens: Mild steel frames show visible surface corrosion within 12 to 18 months at coastal or creek-adjacent sites. A corroded structural frame fails both as a safe structure and under DM inspection.
How to avoid it: Specify galvanized steel frames for any site within 3 kilometres of the sea, the Creek, or any harbour. Build the cost premium into the initial budget.
No Shade Structure Over Outdoor AC Condensers
What happens: Outdoor condensers in direct August sun operate beyond their design temperature tolerance, losing 20 to 30% of cooling efficiency and driving up electricity costs for the entire summer.
How to avoid it: Install a basic steel shade canopy over every outdoor AC unit. This is one of the cheapest improvements available to any Dubai camp operator and pays for itself within the first summer month in electricity savings.
Ignoring the Camp Manager Requirement
What happens: MOHRE inspectors ask to speak with the designated welfare officer directly. A manager who cannot be located, is not registered, or whose name appears across an implausibly large number of simultaneously managed camps is an automatic and serious inspection flag.
How to avoid it: Appoint a genuine, MOHRE-registered welfare officer before worker move-in. For camps of 50 or more workers, this is a legal requirement.
Missing the DEWA Security Deposit in the Financial Model
What happens: An unexpected cash-flow requirement of AED 5,000 to AED 20,000 appears in the week before worker move-in.
How to avoid it: Include the DEWA security deposit in your initial project financial model alongside all other one-time setup costs. It is refundable at project end but must be paid before the power connection is made.
Buying Cabins Without a Relocation Exit Plan
What happens: Cabins left idle on a completed project site lose 30 to 40% of their market value through panel deterioration and weather damage within two to three years.
How to avoid it: Build the exit strategy – redeploy to next project, resell, or arrange supplier buyback – into the procurement decision at the point of purchase. Many established suppliers offer refurbishment and relocation services that make redeployment straightforward and protect the resale value of your investment.
Accepting a Single Supplier Quote
What happens: Price variation across Dubai’s portacabin supplier market for identical specifications regularly exceeds 30%. Without comparable quotes, there is no basis for determining whether a price is competitive.
How to avoid it: Obtain at least three quotes based on identical specifications – same panel type, frame material, AC equipment grade, fit-out level, and warranty terms. Compare only like-for-like submissions.
The Future of Labour Camp Cabins in Dubai – 2025 to 2030 Outlook
Four trends are reshaping the Dubai prefab labour camp market between 2025 and 2030. Contractors who understand these shifts now will mobilise future camps at lower operational cost and with less compliance friction in each project cycle.
Solar-Assisted AC Systems
The economics of solar in UAE labour camps:
- A well-sized solar array on a standard 100-worker camp can reduce DEWA electricity dependency by 30 to 40% during daylight hours.
- Return on investment is typically achieved within three to four years.
- Adoption is currently strongest in DIP camps and newer Jebel Ali industrial facilities.
- As DEWA tariff structures evolve and solar installation costs fall, solar-assisted AC will shift from an optional upgrade to a standard specification inclusion.
IoT-Enabled Camp Management
Smart monitoring technology now entering the Dubai prefab camp market:
- Per-cabin electricity meters with remote monitoring – identify energy waste, equipment failures, and unusual consumption without physically inspecting each unit.
- Occupancy sensors – beginning to automate MOHRE headcount reporting, replacing a manual and time-consuming compliance process.
- Worker welfare complaint apps – routing issues directly to camp management before they escalate to the MOHRE hotline. Well-managed camps using these tools are measurably reducing unannounced inspection triggers.
- Preventive maintenance alerts – IoT sensors detecting AC failures or plumbing issues before they become inspection failures.
Modular Pre-Plumbed Bathroom Pods
Why bathroom pods are gaining traction in large Dubai camp setups:
- Reduce on-site ablution block installation time by up to 60% – a meaningful gain on large camp mobilisations.
- Factory-controlled installation eliminates the variability of site-built bathrooms.
- More consistent quality means fewer plumbing-related inspection failures.
- Bathroom blocks are a frequent critical path item in large-scale camp setups; pods directly address this bottleneck.
Dubai 2040 Urban Master Plan and Rising Welfare Standards
Key anticipated changes that camp operators and cabin buyers need to plan for now:
- Minimum space standards are expected to increase from the current 3 sq.m per worker toward 4 to 5 sq.m in the 2027–2028 regulatory cycle.
- ESG reporting requirements from international clients – particularly European and North American construction and real estate investors – are already auditing accommodation standards as part of supply chain due diligence.
- Free zone authorities are beginning to apply green building compliance targets to temporary accommodation structures as well as permanent buildings.
- Digital compliance reporting – MOHRE portal submissions – will become standard across all camp sizes, not just large operators.
Contractors planning camps today for projects running into 2027 and beyond should design layouts with the anticipated space increase in mind. Retrofitting a camp mid-project to meet a higher space standard costs significantly more than designing the headroom in from the start.
For guidance on which prefabricated accommodation designs can be configured to comply with both current and anticipated future standards, reviewing available product specifications before entering supplier conversations saves significant time and rework.
Final Checklist – What to Confirm Before Setting Up a Labour Camp Cabin in Dubai
Getting a Dubai labour camp cabin setup right comes down to three decisions made correctly before anything is signed. Miss any one of them and the consequences show up either in your compliance record, your electricity bill, or your project financial model.
Size Your Camp Correctly
Calculate space requirements using MOHRE’s precise definitions – not general square-footage estimates:
- Sleeping area: 3 sq.m per worker measured around each bed, not total room floor area.
- Bathrooms: 1 unit per 8 to 10 workers – toilet, shower, and washbasin per unit.
- Dining space: 1.5 sq.m per worker eating simultaneously.
- Kitchen, laundry, and recreational areas calculated separately based on total occupancy.
Do not undersize to save money on cabins. The MOHRE fine for undersizing costs more than the additional cabin that would have brought the camp into compliance.
Choose Your Supplier Based on Project Type
Match every selection criterion to your specific project reality – not price alone:
- Insulation grade to climate exposure – coastal and high-temperature sites require PU or PIR panels, not EPS 50mm.
- Frame material to site location – coastal sites require galvanized steel without exception.
- Lead time to mobilisation deadline – a supplier with a five-week production schedule cannot serve a two-week mobilisation regardless of price.
- MOHRE documentation support – confirm in writing which authority submissions the supplier handles and which remain your own responsibility.
- After-sales support – confirm who to call if there is an inspection issue after installation.
Budget the Full Mobilisation Cost
The cabin purchase price is approximately 60 to 70% of your true mobilisation cost. Build the remaining 30 to 40% into your financial model from day one:
- Site survey, preparation, and foundation work.
- DEWA connection fee and refundable security deposit.
- Dubai Municipality building permit.
- MOHRE accommodation registration.
- Fire safety system installation and Civil Defence inspection.
- Perimeter fencing and security gate.
- Cabin furniture and interior fit-out.
- First month of operating costs – electricity, water, camp management, cleaning, and pest control.
Before committing to any supplier, confirm these five things in writing:
- Panel specification sheet with U-value confirmed in the purchase agreement.
- MOHRE registration support clearly included or excluded from the service scope.
- Two verified UAE reference contacts from completed camps of comparable size.
- A payment milestone schedule – not a single upfront payment requirement.
- Warranty terms covering both structure and MEP with clear conditions for validity.
The compliance reality that matters most: MOHRE compliance is not a one-time sign-off. It is tied to the ongoing work permit issuances that keep your entire project workforce legally employed. A compliant camp keeps your project moving. A non-compliant camp becomes the official reason it stops.
Contractors planning their next camp setup can review the full range of prefabricated accommodation solutions available for Dubai and UAE projects – including labour residence cabins, kitchen and mess hall units, toilet cabin blocks, and modular multi-storey accommodation blocks – to understand what specification options are available before entering supplier negotiations. For specific project requirements or a custom quote, getting in touch directly is the fastest way to move from specification to pricing.
Frequently Asked Questions – Labour Camp Cabin Supplier in Dubai
What is the minimum space required per worker in a Dubai labour camp?
The minimum is 3 sq.m of sleeping area per worker under MOHRE Ministerial Resolution No. 44 of 2022. This refers to sleeping floor space measured around each bed – bathroom and corridor areas do not count. Cabins below this standard face fines starting at AED 5,000 per worker in violation.
How much does it cost to set up a labour camp in Dubai?
AED 8,000 for a single basic cabin up to AED 600,000+ for a 100-worker turnkey camp. Add 30 to 40% on top of the cabin price for site preparation, DEWA connection, permits, fire safety, furniture, and first-month operations. Monthly costs run AED 500 to AED 1,500 per worker.
Do I need a permit to install a portacabin in Dubai?
Yes. A Dubai Municipality building permit is required before any installation begins. MOHRE accommodation registration must also be completed before workers move in. Free zone projects need a separate authority approval from JAFZA, Trakhees, or TECOM on top of both requirements.
What facilities are required in a Dubai labour camp by MOHRE?
MOHRE mandates air conditioning (max 24°C indoor), bathroom blocks (1 per 8 to 10 workers), kitchen and dining space (1.5 sq.m per simultaneous diner), laundry facilities, non-flammable building materials, adequate lighting, and a registered camp manager for all camps of 50 or more workers.
How long does it take to set up a labour camp cabin in Dubai?
1 to 2 weeks for camps under 50 workers and 5 to 6 weeks for 200 to 500 workers. The most common cause of delay is authority approvals started late. DM permit processing alone can add 2 to 3 weeks if not initiated in Week 1 of the project.
What areas in Dubai allow labour camp setup?
Approved zones include Sonapur (Al Muhaisnah), Dubai Investment Park, Jebel Ali (JAFZA), Ras Al Khor, and designated Al Quoz industrial plots. Each zone has different cost levels, compliance authority requirements, and infrastructure quality. Zone selection should match your project’s geographical cluster to avoid commute-time welfare issues.
What is the difference between buying and renting a labour camp cabin?
Renting suits projects under 12 to 18 months or those with uncertain headcount. Buying becomes financially advantageous at approximately 18 to 24 months, especially when cabins can be redeployed to the next project. The break-even depends on cabin specification, local rental rates, and redeployment costs at the next site.
What happens if a labour camp fails a Dubai Municipality inspection?
Failed inspections result in a rectification notice with a specified compliance deadline. Repeat failures escalate to fines of AED 5,000 to AED 50,000 per violation, new work permit issuance freezes, and potential project suspension. Worker complaints to 800MOHRE (800 64673) trigger priority inspections within 48 to 72 hours.
Is there a difference between a portacabin supplier and a camp operator?
Yes. A portacabin supplier manufactures or sells the physical cabin structure. A camp operator manages the complete facility – utilities, catering, cleaning, maintenance, and MOHRE documentation. Many projects need both services, and most cabin suppliers do not automatically provide camp management. Clarify this in writing before signing any agreement.
Can I rent a labour camp cabin in Dubai instead of buying?
Yes. A well-established prefab rental and relocation service covers short-term and long-term cabin hire across Dubai and the UAE, often including relocation support at project end – making rental a financially practical option for projects under 18 months in duration.
Where can I see completed labour camp projects in Dubai?
Reviewing a supplier’s delivered project portfolio – covering different camp sizes, cabin types, and site conditions – gives you a reliable sense of what to expect in terms of quality, configuration, and delivery consistency before requesting a formal quote.
How do I get a quote for a labour camp cabin in Dubai?
The most efficient approach is to prepare a specification sheet – worker count, project duration, site location, insulation grade required, and any free zone authority requirements – and submit it to at least three suppliers simultaneously. For projects with specific configuration needs or tight timelines, requesting a direct consultation with an experienced UAE prefab supplier is the fastest route from specification to a compliant, budgeted proposal.
