Big Site Office Cabin in Dubai: Multi-Room Setup & Configurations

Big Site Office Cabin in Dubai

A big site office cabin in Dubai is a modular, multi-room prefabricated structure built from linked steel-framed sandwich panel units. Configured in layouts ranging from 3-room administrative clusters to 5-PLEX complexes and G+1 double-storey setups, these cabins serve as complete on-site operational headquarters for large-scale construction, infrastructure, and industrial projects across Dubai and the wider UAE.

Why Big Site Office Cabins Are Now Standard on Large Dubai Projects

Drive past any active construction site in Dubai – a road expansion near Business Bay, a high-rise tower rising in Jumeirah Village Circle, or an industrial facility taking shape inside JAFZA – and you will notice a cluster of prefabricated structures sitting along the site boundary. These are not an afterthought. They are the operational nerve centre of the entire project.

Dubai’s construction industry reached a market value of USD 45.8 billion in 2025 and is projected to grow at a compound annual rate of 4.66% through 2034 (IMARC Group, 2025). The Roads and Transport Authority awarded a contract worth AED 1.5 billion for the Al Fay Street Development in January 2025 alone, while Dubai’s broader AED 16 billion Main Roads Development Plan is actively running across 22 projects across the emirate (ResearchAndMarkets, 2025).

When a project site needs to simultaneously house a project manager, a quantity surveyor, an HSE officer, a structural engineering team, a MEP coordination group, and a consultant representative – all working on active tasks every day – a single-room portable cabin simply cannot support this scale.

The configuration of a big site office cabin directly affects:

  • Team productivity and daily workflow efficiency across departments.
  • Communication speed between management layers and site operations.
  • Regulatory compliance with Dubai Municipality, Trakhees, and Dubai Civil Defence.
  • Project delivery timelines from mobilisation to final handover.
  • Staff comfort – critical during Dubai’s 45°C summer months for sustained performance.

This guide covers every dimension of big site office cabin configurations in Dubai – from multi-room layout types and standard dimensions to technical specifications for the UAE climate, permit requirements, and the financial logic of renting versus buying. It is written for project managers, procurement teams, and construction companies making real decisions for active projects across Dubai, Abu Dhabi, Sharjah, and UAE free zones.

What Qualifies as a “Big” Site Office Cabin in Dubai?

A big site office cabin in Dubai refers to any modular prefabricated cabin complex with three or more connected functional rooms – or a total floor area exceeding 50 square metres – designed to serve multiple departments simultaneously. These structures are built from linked 6m, 9m, or 12m standard steel-framed sandwich panel units.

Site office cabin size comparison Dubai small medium large G+1

Understanding the size classification is the first step toward selecting the right configuration for your project:

Category Rooms Floor Area Staff Capacity Typical Use Case
Small Site Office 1–2 rooms Under 25 sqm 2–6 staff Single contractor, small plot
Medium Site Office 3–4 rooms 25–60 sqm 8–20 staff Mid-scale residential or fit-out
Large / Big Site Office 5+ rooms 60–200+ sqm 20–100+ staff Infrastructure, high-rise, industrial
G+1 Multi-Storey Complex 6–12+ rooms 80–250 sqm 30–120+ staff Space-constrained urban Dubai sites

Project Types in Dubai That Consistently Require Big Site Office Configurations

The following project categories across Dubai and the UAE free zones consistently require multi-room site office cabin setups:

  • RTA infrastructure and road contracts across Dubai’s expanding road network.
  • DEWA utility, power, and water treatment projects across all Dubai districts.
  • High-rise residential towers in JVC, Dubai Marina, Business Bay, and Downtown Dubai.
  • JAFZA and DWC industrial facility builds requiring Trakhees-compliant structures.
  • Oil and gas construction and maintenance projects across the UAE.
  • Long-duration EPC contracts awarded by government master developers.
  • Mega-developer community builds under Emaar, Nakheel, and Meraas projects.
  • Airport and port infrastructure projects including Dubai South and Jebel Ali expansion zones.

Based on direct experience supplying and installing prefab site office cabins across Dubai and UAE project sites, projects with 15 or more site-based staff or a project duration exceeding 12 months consistently require a multi-room configuration to remain operationally efficient.

Multi-Room Site Office Cabin Configurations in Dubai: All 5 Types Explained

Multi-room site office cabin configuration types Dubai

Large site office cabins in Dubai are configured in five primary layout types, each solving a different operational problem:

  1. Administrative Cluster Configuration – For multi-layer management teams.
  2. Open-Plan Collaboration Configuration – For engineering and coordination teams.
  3. Self-Sufficient All-in-One Configuration – For remote or early-phase sites.
  4. G+1 Double-Storey Configuration – For urban plots with space constraints.
  5. PLEX Modular Cluster Configuration – For large project headquarters.

Choosing the wrong layout for your team’s actual working style creates friction that compounds daily – managers crossing engineering areas to reach meetings, welfare facilities too far from workstations, or a structure that cannot expand when the scope grows at month six.

Administrative Cluster Configuration

An administrative cluster configuration links multiple individual private offices – each allocated to a specific department or manager – separated by sound-insulated partitions within a single connected cabin structure.

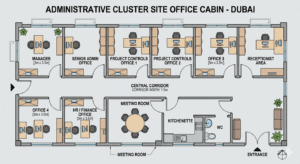

Administrative cluster site office cabin Dubai floor plan

Who it serves best:

  • Project Managers requiring private, secure offices for daily decision-making.
  • Quantity Surveyor teams handling confidential contract documentation and commercial reports.
  • HSE Managers who need quick access to the site entrance for immediate incident response.
  • Commercial Managers and HR staff operating under strict daily confidentiality requirements.
  • Consultant Representatives needing co-located but physically separate working space.
  • Engineering Leads and their teams occupying a larger shared room adjacent to the PM.

Typical layout details:

  • Four to six rooms of approximately 3m x 3m each.
  • All rooms linked along a shared central corridor within an 18m x 6m or larger frame.
  • Entrance opens into a small reception or waiting area for controlled visitor access.
  • Private offices run along both sides of the central corridor for equal access and noise separation.
  • Document archive or storage room positioned at the end of the corridor.

The partition acoustic specification most projects get wrong:

There is a meaningful difference between two types of internal partitions used in prefab office cabins in Dubai:

  • Standard 75mm gypsum board partition: Reduces ambient sound by 35 to 40 decibels. Adequate for general office conversations and routine team discussions.
  • Double-leaf partition with acoustic insulation fill: Achieves 50-plus decibels of sound reduction. Required for confidential HR discussions, contract negotiations, and sensitive client review sessions.

If the HR or commercial office sits adjacent to a shared corridor, specifying the higher-performance acoustic partition at fabrication stage costs a fraction of what a mid-project retrofit costs.

Dubai free zone compliance note:

Under Trakhees regulations – covering JAFZA, Dubai World Central, and Dubai Maritime City – contractor and consultant cabins are sometimes required to be physically separated or clearly demarcated. An administrative cluster with a defined break point between two wings, connected at a shared boardroom or reception junction, satisfies this without needing two entirely separate cabin structures.

Open-Plan Collaboration Configuration

An open-plan collaboration configuration replaces individual enclosed rooms with a large shared workstation floor, paired with one or two enclosed meeting rooms. It is the natural choice for teams requiring constant communication and daily technical coordination across shared drawing sets and project deliverables.

Who it serves best:

  • MEP coordination teams managing multiple subcontractor interfaces simultaneously.
  • BIM and digital design teams working on overlapping, version-controlled drawing sets.
  • Design-build firms where engineers and project staff work in real-time across the same tasks.
  • Large EPC contractors with high-volume daily technical output and frequent cross-team referencing.
  • Site engineering clusters handling RFIs, submittals, and technical queries in fast-paced cycles.

Typical layout details:

  • One large 12m x 6m open workstation floor accommodating 10 to 20 desks.
  • One enclosed 6m x 3m boardroom at one end for formal reviews, client meetings, and subcontractor pre-commencement sessions.
  • Fluid open access across the main workstation floor for uninterrupted daily collaboration.
  • Perimeter cable raceways built in at fabrication to serve each desk position cleanly.

The cable management problem most projects discover too late:

In an open-plan Dubai construction site office with 15 or more active workstations, cable management is an HSE requirement – not an optional finish. Without properly managed power and data cable runs, exposed cables create tripping hazards that site auditors flag immediately during inspections.

The correct approach – specified at fabrication, not retrofitted on site:

  • Option 1: Raised flooring sections with underfloor cable trays for larger open-plan setups.
  • Option 2: Perimeter cable raceway systems running from the DB to each individual desk position.
  • Option 3: Dedicated conduit drops built into the floor structure at regular desk intervals during cabin manufacture.

Demountable partitions – built-in flexibility for evolving projects:

  • Specifying a demountable partition system rather than fixed gypsum partitions allows the layout to be reconfigured without structural work.
  • If three engineers need enclosed private offices at month five, the change happens over a weekend.
  • The same panels are removed, repositioned, and re-fixed – no cutting, no debris, no disruption to the adjacent workstation area.

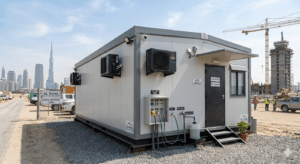

Self-Sufficient All-in-One Configuration

A self-sufficient all-in-one configuration integrates a main office room, a pantry, and a private WC within a single large cabin frame – typically a 12m x 3.6m unit – creating a fully independent workplace that operates without relying on separate welfare facilities elsewhere on site.

Self-sufficient site office cabin Dubai with WC and pantry

Who it serves best:

  • Remote site locations in desert zones, Jebel Ali area projects, and industrial outskirts of Dubai.
  • Early-phase project mobilisations where separate welfare blocks are not yet in place.
  • Senior management cabins requiring completely self-contained facilities separate from team cabins.
  • Oil and gas construction projects where site utilities are not established at mobilisation.
  • Short-duration specialist contractor setups that need a complete functional unit deployed quickly.

Zone breakdown for a standard 12m x 3.6m self-sufficient cabin (43 sqm total):

Zone Approx. Area
Main office area 22 sqm
WC facility 4 sqm
Pantry / kitchenette 6 sqm
Storage / document archive 5 sqm
Circulation and access 6 sqm

How the integrated plumbing system works:

What separates a genuinely self-sufficient cabin from a standard cabin with a toilet bolted on the end is the pre-installed internal plumbing system. A properly built self-sufficient configuration includes:

  1. A UV-stabilised polyethylene fresh water supply tank (500L to 1,000L capacity) mounted externally at one end of the frame.
  2. A grey water and waste collection tank positioned at the opposite end.
  3. Internal plumbing runs pre-installed within the cabin floor frame during fabrication – no exposed pipework added on site.
  4. Designated utility connection ports on the exterior frame for immediate hookup on delivery day.

The unit arrives, sits on foundation blocks, utility connections are made at the marked ports, and the cabin is fully operational the same day – no improvised connections, no welfare-related delays to project mobilisation.

MOHRE welfare compliance benefit:

  • UAE MOHRE guidelines require toilet facilities to be within a reasonable walking distance of all active work areas.
  • A self-sufficient cabin satisfies this requirement intrinsically because the welfare facility is part of the same working structure.
  • No separate welfare block coordination, no welfare compliance gap during early mobilisation phases.

You can review a range of self-sufficient and standard site office cabin configurations to compare what fits your project’s timeline and welfare requirements.

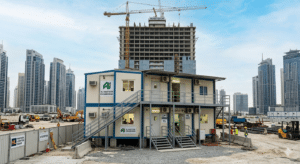

G+1 Double-Storey Configuration

A G+1 site office cabin is a double-storey prefabricated cabin structure where a second level is mounted on top of the ground floor unit – connected by an external or internal staircase – effectively doubling the usable workspace within the same plot footprint.

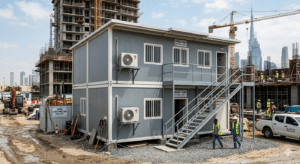

G+1 double storey site office cabin Dubai construction project

Who it serves best:

  • Urban high-rise construction sites in Business Bay, Downtown Dubai, Dubai Marina, and JBR.
  • Projects with tight plot boundaries constrained on multiple sides by hoarding, roads, or adjacent builds.
  • Government-awarded contracts requiring co-located but physically separated contractor and consultant spaces across two floors.
  • Projects with large teams requiring two distinct operational levels with natural access control between them.
  • JAFZA and DWC free zone projects where footprint allocation for the cabin complex is limited.

The structural differences that matter – and that most suppliers never explain:

A double-storey site office cabin is not simply a second cabin placed on top of a first. The structural engineering is fundamentally different across four key areas:

  1. Base frame steel section: Single-storey cabins use 100mm x 50mm RHS steel beams. A G+1 ground floor requires a minimum of 150mm x 75mm RHS beams to carry the additional 8 to 12 tonnes of upper-floor load safely.
  2. Anti-wind bracing: Cross-bracing at both structural ends is mandatory. Dubai’s spring shamal wind events sustain speeds exceeding 30 to 40 knots – end bracing prevents lateral instability in double-storey structures under these conditions.
  3. Foundation block count: Effectively doubles compared to a single-storey cabin of the same footprint. Soil bearing capacity assessment becomes critical on sandy or partially reclaimed ground conditions common across Dubai’s coastal districts.
  4. Bolted floor-to-floor connections: All connections between floors use bolted joints, not welds. This enables clean, damage-free disassembly and relocation at the end of the project without structural damage to either floor unit.

Internal versus external staircase – when the choice is not optional:

  • External staircase (standard choice): Saves interior floor space, faster to install, and the default specification for most G+1 prefab office cabins in the UAE.
  • Internal enclosed staircase (required for higher-occupancy or longer-duration): If the upper floor houses more than 15 persons, or the cabin is occupied for more than 12 months, Dubai Civil Defence requirements may mandate an enclosed, fire-rated internal staircase as the primary means of escape.

Specifying this correctly at fabrication costs a fraction of what a reactive retrofit costs after a DCD inspection flags it.

The natural operational hierarchy advantage:

  • Ground floor handles subcontractor meetings, material deliveries, HSE walkthroughs, and all external operational visits.
  • Upper floor remains the working environment for project management, senior engineers, and client representatives.
  • Decision-makers work without constant walk-in disruption from operational site traffic – with no access control system required.

Dubai Civil Defence requirements for higher-occupancy G+1 cabins:

Any G+1 cabin with upper-floor occupancy above 15 persons requires a second means of escape. This is satisfied by one of the following:

  • A second external staircase positioned at the opposite end of the upper floor.
  • A roof-level emergency ladder assembly meeting DCD minimum specification.

This requirement is non-negotiable on DCD-inspected sites in Dubai. Specify it at fabrication – it becomes far more expensive as a reactive add-on after an inspection. Browse Bait Al Maha’s double storey office cabin range for standard and custom G+1 configurations available for Dubai projects.

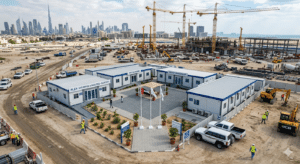

PLEX Modular Cluster Configuration (4-PLEX / 5-PLEX)

A PLEX configuration is a large modular site office complex formed by joining multiple standard cabin units side-by-side or end-to-end. A 4-PLEX joins four units. A 5-PLEX joins five. The result is a wide-span or deep office complex that functions as a complete multi-department project headquarters within a single connected structure.

PLEX modular site office cabin cluster configuration Dubai UAE

Configuration Units Joined Approx. Total Area Common Shape Best Fit
2-PLEX 2 units ~72 sqm Linear Small project HQ
3-PLEX 3 units ~108 sqm Linear Medium management hub
4-PLEX 4 units ~144 sqm Square or L-shape Large multi-department HQ
5-PLEX 5 units ~180 sqm L-shape or U-shape Mega-project site HQ

L-Shape versus U-Shape – when to use which:

L-Shape layout works best when:

  • The site boundary on one side is constrained by hoarding, an access road, or an adjacent structure.
  • The cabin complex needs to wrap a corner rather than extend in a straight line.
  • The corner junction serves as a natural shared boardroom or reception point where both wings meet.
  • Visitors from outside need access to one wing without passing through the operational areas of the other.

U-Shape layout works best when:

  • Sufficient plot space allows three wings to enclose a central area.
  • A sheltered outdoor briefing courtyard is operationally valuable for toolbox talks and daily briefings.
  • The project requires natural physical separation between two teams – contractor and consultant – while maintaining a shared central access point.
  • Wind protection for a common outdoor gathering area is a priority during Dubai’s spring shamal season.

In Dubai’s climate, a properly oriented U-shape courtyard is usable for outdoor briefings approximately seven to eight months of the year – outside the peak July-to-September heat window.

The inter-unit corridor connector that most PLEX specs miss:

When PLEX units are arranged in L or U configurations, they require weatherproof breezeway corridor panels linking them. These are insulated overhead connecting panels that allow staff to move between units without stepping outdoors.

Key reasons this is an operational necessity, not a comfort feature:

  • Dubai summer outdoor temperatures exceed 45°C for hours at a time.
  • Walking 10 metres between cabin units outdoors is genuinely counterproductive during peak summer months.
  • The corridor maintains the entire PLEX complex as a single unified fire zone for DCD compliance purposes – critical when total occupancy exceeds 30 persons.
  • It eliminates the risk of valuable project documentation being carried in open weather between units.

Zone-controlled HVAC – the energy cost argument:

Specify independently zoned split AC units per cabin unit rather than a centralised system. The financial and operational benefits include:

  • Individual units powered down overnight, on weekends, and during site shutdown periods.
  • A fault in one zone does not interrupt cooling in any other zone.
  • DEWA tiered electricity tariffs mean zone control keeps total monthly consumption lower and more predictable.
  • Maintenance or replacement of one unit does not disrupt the entire office complex during working hours.
  • Inverter-type units across a 5-PLEX complex save an estimated AED 400 to 600 per month compared to non-inverter units – a meaningful figure over a 24-month project.

Standard Site Office Cabin Dimensions in Dubai: What Each Size Can Realistically Hold

The most common large site office cabin dimensions in Dubai range from 12m x 3m – a single unit holding 8 workstations – to 6m x 18m modular clusters serving as full multi-department headquarters. Custom non-standard sizes including 10m x 4m and 14m x 4m frames are available for projects with specific spatial constraints.

Cabin Size Floor Area Capacity Partition Options Best Use
6m x 3m 18 sqm 1 private office or 4 desks 1 room Site supervisor office
9m x 3m 27 sqm 2 rooms or 6 desks 2 rooms Supervisor and engineer pairing
12m x 3m 36 sqm 3 rooms or 8 workstations Up to 3 rooms Single department office
12m x 3.6m 43 sqm Office + pantry + WC + storage 4 zones Self-sufficient site HQ
6m x 12m 72 sqm Boardroom + 3 offices + reception 4 to 5 rooms Mid-scale management hub
6m x 18m 108 sqm 5 to 7 rooms or mixed open and closed 5 to 7 rooms Large project admin HQ
12m x 12m 144 sqm 8 to 10 rooms or full open-plan 6 to 10 rooms Multi-department mega HQ
12m x 12m G+1 288 sqm 16 to 20+ rooms across 2 floors 10 to 20 rooms Urban space-constrained mega HQ

How to Calculate the Right Cabin Size: The Per-Person Space Formula

For Dubai site office cabins, the recommended minimum space allocation per use type is:

  • 5 to 6 sqm per person for open-plan workstation positions.
  • 9 to 12 sqm per person for enclosed private office rooms.
  • 4 sqm minimum for each WC facility.
  • 6 sqm minimum for each pantry or kitchenette unit.
  • 15 to 20 percent buffer added to the subtotal for storage, circulation, and future expansion.

The five-step cabin sizing calculation:

  1. List all roles and categorise each as private office or open-plan desk.
  2. Apply the formula: (private office occupants × 10 sqm) + (open-plan occupants × 6 sqm) + welfare allowance (WC + pantry sqm).
  3. Add 15% buffer to the subtotal for circulation space and expansion capacity.
  4. Match the required floor area to the nearest standard cabin dimension or PLEX configuration.
  5. Confirm site feasibility – check that the selected cabin dimensions fit within the plot and allow crane delivery access.

Worked example:

A project houses 5 private-office managers and 12 open-plan engineers, with 1 WC and 1 pantry required.

  • Calculation: (5 × 10) + (12 × 6) + 4 + 6 = 132 sqm minimum.
  • Adding 15% buffer: 132 × 1.15 = approximately 152 sqm required.
  • Best match: A 4-PLEX at approximately 144 sqm, or a G+1 on a 12m × 9m footprint yielding 162 sqm across two floors.

The most consistent planning mistake is under-sizing based on confirmed headcount only – without accounting for subcontractor managers, consultant representatives, and client visitors who will use the office daily from month two onward. The buffer is not padding. It is the difference between a site office that works and one that creates daily friction.

Core Technical Specifications: What a Quality Big Site Office Cabin Must Include for Dubai’s Climate

High-quality prefab site office cabins in Dubai must address four critical engineering demands:

  1. Structural integrity for crane lifting and repeated site relocation across projects.
  2. Thermal insulation rated for 45°C-plus UAE summer conditions without HVAC overload.
  3. DEWA-compliant electrical infrastructure throughout every room and zone.
  4. Interior finishes that withstand years of high-traffic use without degrading.

Structural Frame and Base

Heavy duty steel base frame site office cabin UAE galvanised

Standard requirements for every big site office cabin base frame in Dubai:

  • Cast-in lifting hooks with stamped SWL (Safe Working Load) ratings for every lift point.
  • Forklift pockets for internal site repositioning without crane mobilisation.
  • Anti-rust treatment covering all steel surfaces, weld points, and connection zones.
  • Heavy-duty corner castings at all four base corners for stacking capability where required.
  • Minimum four-hook configuration for any cabin exceeding 10m in length, each hook rated at minimum 5 tonnes SWL.

Hot-dip galvanisation versus spray coating – why this matters in Dubai:

  • Hot-dip galvanisation creates a 45 to 85 micron zinc layer metallurgically bonded to the steel – not sitting on top of it. Survives coastal humidity, sand exposure, and repeated site relocations without degradation.
  • Spray-applied zinc primer creates an 8 to 15 micron surface coating. In Dubai’s coastal districts, where salt-laden air accelerates corrosion, spray-coated frames begin showing rust penetration within two to three UAE summers.

For a modular site office cabin serving a 24-month project and then being relocated to a second site, hot-dip galvanisation pays back its premium through avoided maintenance and structural longevity alone.

Insulation: Sandwich Panel Selection for Dubai’s Climate

Site office cabins in Dubai use insulated sandwich panels as the core building envelope. The correct specification by surface:

  • Wall panels: 50mm minimum thickness for all external wall faces.
  • Roof panels: 75mm minimum thickness – always, not optionally – due to sustained direct overhead solar radiation on flat rooftops.
Property EPS Polystyrene Panels Rockwool Panels
Thermal Performance Good Very Good
Fire Resistance Limited – melts at approximately 80°C Excellent – non-combustible to 1,000°C+
Acoustic Insulation Moderate (25–30 dB) Good (30–38 dB)
Weight Light Heavier – 15 to 18 kg/sqm
Relative Cost Lower 15 to 20% higher
Dubai Civil Defence Acceptable for low occupancy Required for 15+ persons or G+1
Best Application Short-term, budget-constrained builds Long-duration, G+1, free zone compliance

Why 75mm roof panels are non-negotiable in Dubai:

Dubai’s flat cabin rooftops receive 8 to 10 hours of direct solar radiation daily during summer months. Using 50mm roof panels causes the following measurable consequences:

  • HVAC systems working 30 to 40% harder than necessary to maintain temperature.
  • Higher monthly DEWA electricity bills that accumulate significantly over a 24-month project.
  • Uneven temperature distribution inside the cabin despite AC running continuously.
  • Accelerated wear on compressor units due to sustained high-load operation in peak summer.

Rockwool panels certified by Dubai Civil Defence and meeting ISO 9001:2015 manufacturing standards are the correct specification for any multi-room, long-duration big site office cabin in Dubai.

HVAC and Cooling System Specification

Correct AC unit sizing by room area for Dubai site office cabins:

  • 18,000 BTU (1.5-ton) unit – for enclosed rooms of 18 to 20 sqm.
  • 24,000 BTU (2-ton) unit – for open-plan areas of 30 to 36 sqm.
  • 36,000 BTU (3-ton) unit – for large open-plan floors exceeding 40 sqm.

Inverter versus non-inverter AC – the financial comparison for Dubai site offices:

Factor Non-Inverter AC Inverter AC
Purchase Cost Standard market rate 20 to 30% higher upfront
Monthly Cost Per Unit (Dubai summer) AED 180 to 240 AED 100 to 140
Break-Even Period Approximately 14 to 18 months
Recommended For Projects under 12 months Projects 18 months and above
Noise Level Higher Significantly lower

AC positioning rules that are specific to Dubai:

  • Outdoor condenser units must face north or east – never west or south.
  • West-facing condensers receive peak afternoon solar radiation and lose significant efficiency as ambient air temperature approaches 48°C.
  • North or east-facing placement maintains condenser efficiency during peak afternoon hours and extends compressor operational life.

Additional HVAC requirements for multi-room configurations:

  • Each enclosed room requires a mechanical exhaust fan (minimum 150mm diameter) for fresh air circulation.
  • WC ventilation must run on a completely separate circuit from the main office HVAC at all times.
  • Condenser units require a minimum 600mm clear space on all sides for airflow performance and maintenance access.

Electrical and Data Infrastructure

DB sizing by cabin configuration type:

Cabin Size DB Specification Supply Required
Single cabin (1–2 rooms) 1 × 12-way DB Single phase
3–4 room cluster 1 × 24-way main DB 3-phase
5-plus room PLEX complex Main 3-phase DB + sub-DBs per unit 3-phase with zone sub-circuits
G+1 double-storey Separate DB per floor + main feeder DB 3-phase

Why sub-DBs per zone matter on active Dubai sites:

  • A fault in one room does not cut power to every other room simultaneously.
  • Each zone is isolated and inspected independently during routine maintenance.
  • Sub-DBs provide a clear, auditable circuit map for DEWA inspections and HSE audits.
  • Load balancing across zones reduces nuisance tripping during high-occupancy working periods.

Non-standard or non-DEWA-compliant wiring is one of the most frequently cited failures during Dubai site HSE audits. Every big site office cabin specification must include:

  • British Standard (BS) sockets and outlet fittings throughout all rooms.
  • Properly rated MCBs on every individual circuit.
  • Earth continuity verified and documented at commissioning.
  • A clear DB schedule provided with the cabin documentation package for the client.
  • DEWA-registered consultant sign-off on the electrical single-line diagram before applying for temporary power connection.

Data infrastructure specification for connected site offices:

  • CAT6 UTP cabling as minimum standard, terminating in wall-mounted RJ45 sockets at every desk position.
  • CAT6A cabling for G+1 complexes or sites anticipating 10 Gbps backbone infrastructure.
  • Conduit quantities to specify at order stage:
    • One data conduit per desk position.
    • One data conduit per shared printer or plotter station.
    • One data conduit per meeting room AV connection point.
  • Data conduits must run entirely separately from power conduits – combined raceways create electromagnetic interference degrading network performance.

Interior Finishes for Long-Duration Projects

Site office cabin interior finish Dubai prefab workstation

Flooring durability ranking for active construction site environments:

Flooring Type Durability Best Location Avoid When
Ceramic Tile ★★★★★ Reception, WC, pantry, corridors Private offices – hard surface
PVC Parquet (click-lock) ★★★★☆ Open-plan workstation areas Wet or moisture-exposed areas
Wooden Laminate ★★★☆☆ Private manager offices High-footfall areas or humid coastal sites
Carpet Tile ★★☆☆☆ Boardrooms – short-term only Sandy or dusty site environments

Why 2.5m minimum ceiling height is mandatory in Dubai’s climate:

  • Hot air stratifies – the warmest air layer sits at the ceiling level in any enclosed space.
  • In cabins with 2.2m ceilings, the temperature differential between floor and ceiling during a Dubai summer reaches 3 to 5°C – directly at head height for seated staff.
  • Reduced ceiling height forces HVAC systems to work harder and creates sustained thermal discomfort.
  • A minimum 2.5m finished ceiling height is required for all large site office cabin configurations in Dubai.

LED lighting lux levels by zone – specify these at order stage:

  • General office area: 400 to 500 lux (EN 12464-1 workplace lighting standard).
  • Drawing review and CAD workstation area: 750 lux.
  • Meeting and boardroom: 300 to 400 lux.
  • WC facilities: 200 lux.
  • Pantry and kitchenette: 300 lux.
  • Internal corridors: 150 to 200 lux.

Dubai Regulatory Requirements for Big Site Office Cabins: DM, Trakhees, DCD, and DEWA

Dubai site office cabin permits compliance DM Trakhees DCD DEWA

In Dubai, large site office cabins are classified as temporary structures. Installing them without appropriate regulatory clearances can result in:

  • Stop-work notices from Dubai Municipality or Trakhees.
  • Fines of up to AED 50,000 for permit violations.
  • Mandatory removal orders that directly delay project mobilisation schedules.
  • Failed DCD inspections that block DEWA temporary power connections and further delay operations.

Getting the compliance framework right before delivery is a project timeline protection measure, not a bureaucratic formality.

Dubai Municipality Temporary Structure Permit

Dubai Municipality classifies site office cabins as temporary structures under building permit regulations. Projects requiring cabins on-site for more than 30 days typically need a Temporary Structure Permit submitted via the DM ePlan digital system.

Documents typically required for DM Temporary Structure Permit application:

  1. Valid trade licence.
  2. NOC from the building or plot owner.
  3. Detailed structural drawings – layout dimensions, materials specification, and section details.
  4. Electrical plans showing DB layout, circuit schedule, and socket positions.
  5. Plumbing plans where WC or pantry facilities are included.
  6. Cabin technical datasheet from the manufacturer – including panel certifications and fire safety material documentation.
  7. Site plan showing cabin location relative to plot boundaries and setback distances.

Additional approvals required after DM structural approval:

  • DEWA approval for electrical and plumbing works.
  • Dubai Civil Defence sign-off for fire safety compliance.

DM permit approval for complete, well-documented applications typically takes 5 to 15 working days. Missing documentation is the single most common cause of delays.

Trakhees Compliance for Free Zone Projects

Key differences between the Trakhees and DM processes:

  • Trakhees often requires pre-approval of cabin specifications before delivery to site – not a notification after installation.
  • Welfare facility ratios – WC capacity per number of occupants – are more strictly enforced.
  • Material certifications are more detailed, particularly for fire-rated panels and structural steel documentation.
  • Contractor and consultant cabin separation may be required on certain Trakhees-regulated sites.
  • The Trakhees ePermit system is a separate portal from DM’s ePlan – both require DEWA and DCD approvals as downstream steps.

Dubai Civil Defence Fire Safety Requirements

Core DCD requirements for site office cabins with occupancy above 10 persons:

  • Fire extinguishers: 2kg dry powder at no more than 15 metres of travel distance from any occupied point.
  • Emergency exit doors: Minimum 900mm clear opening width on all designated emergency exits.
  • Smoke detectors: Installed in every enclosed room and in every corridor segment.
  • Fire-rated partitions: Required for complexes exceeding two connected cabin units in total floor area.
  • Rockwool sandwich panels: Required for 15-plus persons occupancy or any G+1 configuration.

Additional DCD requirements for G+1 cabins with upper-floor occupancy above 15 persons:

  • A second means of escape from the upper floor is mandatory – either a second external staircase or a roof-level emergency ladder meeting DCD specification.
  • Upper floor occupation without a compliant secondary escape route is not permitted under DCD guidelines on inspected sites.

DEWA Temporary Power Connection

Key facts about the DEWA temporary power connection process:

  • Complexes with total electrical load above 10 kVA require 3-phase temporary supply.
  • Applications require an approved electrical single-line diagram from a DEWA-registered consultant.
  • Connection issuance takes approximately 10 to 15 working days from a complete, approved application.
  • The DEWA Building NOC process takes approximately 3 working days per service (electricity and water separately).

Interim power for early-phase project mobilisation:

  • 15 kVA diesel generator: Suitable for a 3 to 4 room cabin complex with limited AC load.
  • 30 kVA diesel generator: Suitable for a 5 to 7 room complex with full AC and data load.
  • 40 kVA diesel generator: Suitable for a large PLEX or G+1 complex at full operational capacity.

Important clarification: Ejari or tenancy registration is not required for site office cabins on construction sites – a common point of confusion for project teams new to the UAE regulatory environment.

The Bait Al Maha team assists project teams with the full documentation package for DM and Trakhees permit applications – including structural datasheets, material certifications, and site installation drawings – removing the documentation burden from an already-stretched project team.

Should You Buy or Rent a Big Site Office Cabin in Dubai?

Renting is typically more cost-effective for projects under 18 to 24 months. Purchasing becomes the better financial decision when the project duration exceeds 24 months or when the same cabin will be redeployed across multiple consecutive projects.

Decision Factor Lean Toward Renting Lean Toward Buying
Project Duration Under 18 months 24 months and above
Number of Projects One-time project Multiple concurrent or sequential projects
Modification Needs None – use as-is Custom layout, branding, added fit-out
Budget Type OPEX preferred CAPEX available
Post-Project Plan Return to supplier Redeploy or resell

Hidden Costs of Renting That Buyers Often Miss

  • Inbound transport cost – charged separately by most portacabin rental companies in Dubai.
  • Crane installation fee on delivery – rarely included in the quoted monthly rental rate.
  • Damage deposit – typically one to two months of rental value held for the full project duration.
  • Return transport and crane demobilisation cost at project end.
  • Modification restrictions – most rental agreements prohibit custom partitions, additional data points, or branding.
  • Cleaning and reinstatement charges applied on return, particularly on longer-duration rentals.

Hidden Costs of Buying That Renters Often Miss

  • Transport and crane installation at the start and end of each project deployment.
  • Off-project storage costs between deployments – yard rental or weather exposure degradation.
  • Depreciation – prefab cabins in the UAE depreciate approximately 10 to 15% per year under standard market conditions.
  • Owner-responsibility maintenance during idle storage periods between projects.
  • Retrofitting costs if the cabin was not originally specified correctly for the next project’s requirements.

The Refurbished Cabin Option – The Middle Ground Most Projects Overlook

Professionally refurbished site office cabins from reputable UAE manufacturers offer a third path that is genuinely underutilised. A well-refurbished unit from a quality manufacturer provides:

  • New structural inspection confirming frame and base integrity throughout.
  • Replacement of degraded sandwich panels with new, certified sections.
  • Fully rewired electrical system to current BS standards with a new DB.
  • New interior finishes – flooring, wall lining, ceiling tiles, and LED lighting throughout.
  • Refreshed external cladding and full weatherproofing.

Purchase price is typically 30 to 40% lower than an equivalent new unit – the strongest value option for companies needing full ownership and redeployment rights under capital budget pressure. You can explore both new and refurbished options across Bait Al Maha’s full product range or get in touch for a direct quote comparison.

How to Plan a Multi-Room Site Office Cabin in Dubai: 7 Steps Before You Order

How to plan a multi-room site office cabin Dubai 7 steps

Skipping any of these seven steps at the order stage creates problems that are far more expensive to resolve mid-project.

Conduct a Department Headcount and Privacy Audit

List every department and every role occupying the cabin. For each, determine:

  • Does this person need a private enclosed office? (Manager, HR, QS, HSE, commercial team.)
  • Or does open-plan desk space serve them adequately? (Engineers, coordinators, administrators.)

This produces your room count and typology list – the starting point for every layout decision that follows.

Map Visitor and Personnel Traffic Flow

  • Identify which roles receive the most external visitors – clients, safety inspectors, subcontractor managers, authority representatives.
  • Their spaces belong nearest the entrance – accessible without passing through operational areas.
  • Staff requiring uninterrupted focus – QS team, document controllers, engineering coordinators – should be positioned deepest in the layout, furthest from the entrance.

Place Welfare Zones Strategically

Three rules govern welfare zone placement in every well-configured site office:

  1. The WC must not open directly into a meeting room, client reception area, or the main workstation floor.
  2. The pantry must be accessible from the workstation area without staff crossing through private offices.
  3. The first aid point should sit adjacent to the main entrance for rapid access during any incident on sites with 20-plus staff.

Optimise for Dubai’s Climate Orientation

Apply the following rules wherever the site layout permits:

  • Main entrance faces north or east – away from peak afternoon solar heat gain.
  • Minimise window openings on west-facing elevations – these receive the most intense afternoon radiation in Dubai.
  • All AC condenser units placed on north or east-facing walls only – never west or south.
  • Roof panels specified at 75mm minimum regardless of wall panel thickness selected.

Calculate Electrical and Data Load Before Ordering

Sum the following to determine total electrical load:

  • All AC unit loads in kW – 1 tonne of cooling equals approximately 3.5 kW.
  • General lighting load per room – typically 0.3 to 0.5 kW per room.
  • Data equipment load – servers, network switches, plotters, and printers – typically 0.5 to 2 kW per equipment cluster.

This total determines whether single-phase or 3-phase DEWA supply is required. Specifying data conduit runs, quantities, and routing at order stage is critical – retrofitting conduit through finished cabin walls is costly and disruptive mid-project.

Assess Ground Conditions for Foundation Block Specification

Ground condition determines the correct foundation type for every Dubai site:

  • Sandy or unstable soil – common on desert-fringe Dubai sites and coastal industrial plots: concrete foundation plinths, minimum 600mm × 600mm × 600mm, poured in-situ or pre-cast.
  • Confirmed stable, level ground: adjustable steel pedestals provide a faster and equally effective solution.
  • Sloped sites: adjustable steel pedestals allow the cabin frame to be levelled without any excavation or civil groundwork.

Plan One Expansion End at Zero Extra Cost

Specify at the time of ordering that one end of the cabin cluster be finished with a demountable modular panel face rather than a fixed structural wall.

Benefits of this specification:

  • Costs nothing additional at the fabrication stage.
  • Allows an additional cabin unit to be docked and connected mid-project without structural disruption to the existing complex.
  • If the project ends without expansion, the demountable end performs identically to a fixed wall.
  • Protects against scope growth at month six when additional space becomes urgent and new fabrication lead times cannot be accommodated.

Teams working with Bait Al Maha on site office projects consistently report this as one of the most valuable upfront decisions on long-duration contracts across Dubai and UAE free zones.

3 Real-World Site Office Cabin Configuration Scenarios from Dubai Projects

The following configurations reflect direct experience supplying and installing large site office cabin complexes across Dubai and the UAE. Project identities are not disclosed. Project categories, requirements, and configuration solutions are representative of completed work.

Infrastructure Road Contract, Dubai

U-shape PLEX site office cabin complex Dubai road infrastructure project

Field Detail
Project Type 18-month expressway upgrade contract
Site Location Dubai outskirts – open desert zone
Team Requiring Space PM, QS, HSE, Engineering Open-Plan, Consultant, Meeting Room
Configuration Selected U-shape 5-PLEX – two wings meeting at corner boardroom
Total Floor Area Approximately 216 sqm
Storey Single storey

Special specifications applied on this project:

  • Rockwool panels throughout – required for MOHRE and DCD compliance on a 40-plus staff site.
  • HSE office at ground-floor entrance level for immediate incident reporting access.
  • Dedicated 4 sqm first aid room adjacent to the HSE office.
  • Separate document archive with fire-rated door and lockable access for QS documentation.
  • 3-phase DEWA temporary supply with dedicated sub-DBs per wing.
  • Weatherproof inter-unit corridor connectors linking all five units throughout the complex.
  • 30 kVA diesel generator for first 25 days pending DEWA connection issuance.

Why the U-shape was chosen: The 35-person team required daily morning briefings. The U-shape created an internal shaded courtyard protected from desert wind and direct afternoon sun – a genuinely usable outdoor briefing space for the majority of the project duration without gathering everyone into a single cramped room.

High-Rise Residential Development, Business Bay Dubai

G+1 double storey site office cabin Business Bay Dubai high rise construction

Field Detail
Project Type 32-storey residential tower, 36-month build
Site Location Urban Business Bay – tight boundary plot
Team Requiring Space Developer’s rep, main contractor, structural consultant, MEP coordination,
client boardroom
Configuration Selected G+1 double-storey – 12m x 9m footprint, 2 floors
Total Floor Area Approximately 216 sqm across 2 floors
Storey G+1 double-storey

Special specifications applied on this project:

  • Internal enclosed fire-rated staircase – required by DCD for 22-person upper-floor occupancy.
  • Rockwool panels throughout both floors of the structure.
  • High-specification boardroom on the upper floor – ceramic tile, suspended ceiling, recessed LED panels, AV connection point.
  • Solar-ready roof provision included at fabrication per the client’s green building programme requirement.
  • 3-phase DEWA temporary supply with separate feeder DB per floor.
  • Separate external access doors for the ground-floor operations and upper-floor staircase entry.

Why G+1 was the only viable option: The 12m × 9m footprint was the maximum the site boundary permitted. A single-storey PLEX cluster was not feasible on this plot. The G+1 delivered 216 sqm within that footprint – identical to what a 3-PLEX linear cluster would occupy on an open flat site. Developer offices occupied the upper floor, completely separated from ground-floor engineering and operations traffic.

Industrial Facility Fit-Out, JAFZA Free Zone

L-shape site office cabin JAFZA Dubai free zone industrial project

Field Detail
Project Type 14-month warehouse and production facility fit-out
Site Location JAFZA – Trakhees regulated zone
Team Requiring Space Contractor office, client representative, HSE room, welfare block
Configuration Selected L-shape 3-PLEX – contractor wing and client wing meeting at
corner boardroom
Total Floor Area Approximately 108 sqm
Storey Single storey

Special specifications applied on this project:

  • Full Trakhees pre-approval documentation submitted before cabin delivery to site.
  • Rockwool panels throughout – specific Trakhees requirement for this JAFZA location.
  • Physical separation between wings – single shared connection point at the boardroom only.
  • Separate external entrance doors for each wing – contractor and client entering independently.
  • 15 kVA diesel generator for the first 30 days pending DEWA temporary connection.
  • JAFZA gate-compliant access log positioned at the main cabin entrance.

Why L-shape satisfied the compliance requirement: Trakhees regulations required physical demarcation between contractor and client workspaces. The L-shape created two clearly distinct wings – one per party – meeting only at the corner boardroom. Both teams accessed their own wing from their own entrance door. The boardroom opened into each wing through separate doors. The arrangement satisfied the Trakhees separation requirement without building two entirely separate cabin structures on a plot with no space to accommodate them.

To see more completed projects across Dubai and the UAE, the Bait Al Maha projects page shows a range of site office and prefab cabin installations across different industries and configurations.

What to Look for When Choosing a Site Office Cabin Supplier in Dubai

When selecting a prefab cabin manufacturer in Dubai or a portacabin supplier in the UAE, five criteria matter more than any other in the evaluation process.

Criterion Ask This Green Flag Red Flag
Manufacturing In-house or subcontracted? In-house UAE fabrication yard Reseller with no manufacturing capacity
Material Quality What panel spec and thickness? Certified 50mm/75mm with technical datasheets Verbal assurances, no documentation
Electrical BS standard wiring and certified DBs? BS sockets, DEWA-compliant DB with circuit schedule Non-standard wiring, no DB schedule
Documentation Can you support permit applications? Full technical datasheets, material certs, structural drawings “The client handles permits”
After-Sales Relocation and maintenance available? Crane, transport, repair, and refurbishment all in-house Delivery only, no post-installation support

What specification sheets do not reveal – the quality variables that matter on site:

Two cabins with identical specification sheets can perform very differently in practice. The variables that separate a quality build from a mediocre one include:

  • Weld quality on the steel base frame – visible at the manufacturer’s fabrication yard during inspection.
  • Panel bonding consistency – delamination between steel face and insulation core is a documented failure mode in lower-quality UAE sandwich panels after two hot summers.
  • Electrical termination workmanship – poorly terminated connections are a fire risk and a consistent HSE audit failure point on Dubai sites.
  • Responsiveness mid-project – suppliers who only deliver and disappear leave project teams managing structural or electrical issues alone during critical project phases.

Bait Al Maha is a UAE-based prefab cabin manufacturer operating from Sharjah with supply and installation capability across all seven emirates. The team covers the full project lifecycle – from configuration consultation and fabrication through to DM documentation support, crane-assisted installation, mid-project modifications, and post-project relocation and refurbishment services. Completed project references across Dubai, Abu Dhabi, and the UAE free zones are available to review on the projects portfolio page.

Frequently Asked Questions About Big Site Office Cabins in Dubai

frequently asked questions answered

What is a site office cabin?

A site office cabin is a prefabricated, modular workplace structure built from a steel frame and insulated sandwich panels. It is fitted with electrical supply, air conditioning, data cabling, and interior finishes, and serves as the operational base for project managers, engineers, and site teams for the full duration of a construction project.

What size is a standard site office cabin in Dubai?

Standard single-unit site office cabins in Dubai range from 6m x 3m (18 sqm) to 12m x 3.6m (43 sqm). Large multi-room configurations formed by linking multiple units range from 72 sqm for a 2-PLEX to over 200 sqm for a 5-PLEX or G+1 double-storey complex. The most common size for a single contractor’s site office is 12m x 3m, providing three rooms or eight workstations.

What is the difference between a porta cabin and a site office?

A porta cabin is the broader category – any prefabricated portable structure used for offices, accommodation, storage, toilets, or security purposes. A site office is a specific type of porta cabin configured with office-grade interior finishes, electrical infrastructure, data cabling, and air conditioning for use as a workplace. All site offices are a form of porta cabin, but not all porta cabins are site offices.

Do I need a permit for a site office cabin in Dubai?

Yes, in most cases. Dubai Municipality requires a Temporary Structure Permit for site office cabins installed for more than 30 days. Projects within JAFZA, DWC, or other PCFC-regulated free zones require Trakhees approval instead. Both processes also require DEWA approval for electrical works and Dubai Civil Defence sign-off for fire safety compliance.

How long does it take to install a site office cabin in Dubai?

A single large unit can be crane-positioned within one working day. A 4-PLEX to 5-PLEX cluster with full electrical hookup and AC takes three to five working days. A G+1 complex with internal fit-out typically requires seven to ten working days. Lead time from confirmed order to site delivery for new fabrication is three to six weeks.

Can site office cabins be customised in Dubai?

Yes. Partition layout, room count, WC and pantry placement, flooring, ceiling height, AC zoning, electrical DB configuration, and data point positions are all specified at the fabrication stage. Custom non-standard dimensions – such as 10m x 4m frames – are also available. Most quality UAE manufacturers produce an approved 2D layout drawing before fabrication begins.

Are site office cabins suitable for Dubai’s summer heat?

Yes, when correctly specified. Cabins with 75mm rockwool roof panels, 50mm insulated wall panels, individually zoned split AC units, and a minimum 2.5m ceiling height maintain comfortable working temperatures throughout Dubai’s summer months. Poorly specified cabins with thin roof panels and undersized AC units will struggle to perform in sustained 45°C outdoor conditions.

Can I rent a site office cabin in Dubai?

Yes. Site office cabin rental is widely available across Dubai and the UAE for both short-term and long-term project durations. Rental is generally the more cost-effective option for projects under 18 months. For projects exceeding 24 months, purchasing typically delivers better total value. Bait Al Maha offers both rental and purchase options with full delivery, installation, and documentation support across all UAE locations.

How much does a site office cabin cost in Dubai?

Costs vary based on size, specification, insulation type, and interior fit-out standard. Basic single-unit configurations start from approximately AED 8,000. Large multi-room PLEX configurations and G+1 double-storey complexes with full specification range from AED 50,000 to AED 200,000 and above depending on total floor area and fit-out level. For an accurate quotation based on specific project requirements, the fastest route is a direct consultation with a UAE-based manufacturer.

Planning Your Big Site Office Cabin in Dubai – Next Steps

Prefab site office cabin Dubai complete installation ready

A big site office cabin in Dubai is not a commodity purchase made at the last minute of a mobilisation plan. It is a modular, multi-room operational structure that shapes how effectively your entire project team works from day one of mobilisation to the final day of site occupation.

The five most important decisions this guide has covered:

  1. The right configuration type for your team’s actual operational structure – Administrative Cluster, PLEX, G+1, Self-Sufficient, or Open-Plan Collaboration.
  2. Correct dimensional sizing using the per-person space formula – not generic estimates.
  3. Dubai-compliant technical specifications that account for the UAE’s extreme climate at every layer of the build.
  4. Clear regulatory understanding of DM, Trakhees, DCD, and DEWA requirements before delivery day.
  5. A financially informed buy-versus-rent decision based on your actual project duration and redeployment plans.

Getting these five decisions right at the planning stage costs nothing extra. Getting them wrong mid-project costs time, money, and operational disruption at the worst possible point in the project schedule.

For project teams configuring a site office cabin for an active or upcoming Dubai project, the starting point is a direct consultation on configuration options, dimensions, and permit documentation. The Bait Al Maha team works across Dubai, Abu Dhabi, Sharjah, and all UAE free zones, handling everything from fabrication and delivery to mid-project modifications and post-project relocation and refurbishment services.
