Opening a container cafe or restaurant in Dubai costs between AED 180,000 and AED 1.5 million. The setup takes roughly 6 to 8 weeks from signed agreement to opening day. The final number depends on one decision more than any other: are you building a compact coffee container, or a full dine-in restaurant with a commercial kitchen? This guide separates the two. It walks through every cost line item Dubai’s authorities will ask you to pay for. It also lays out the setup process in the order it actually happens, not the simplified version most guides give you.
If you are still weighing whether this model fits your concept at all, it is worth reading our broader look at why container restaurants work in Dubai alongside this guide. That article covers the bigger picture; this one covers the exact numbers and steps.
Container Cafe vs. Container Restaurant Dubai: Which Format Should You Build?
A container cafe and a container restaurant are licensed differently in Dubai. That difference shapes almost every cost that follows.
- A cafe, technically a “cafeteria” activity under the Dubai Department of Economy and Tourism, typically serves coffee, light snacks, and pre-prepared food with minimal on-site cooking.
- A restaurant activity covers full food preparation, including grills, fryers, and open flames across multiple cooking stations. It triggers a heavier set of Dubai Municipality and Civil Defence requirements.
This distinction matters because the two paths diverge early.
- A cafe with an espresso machine, a panini press, and a display fridge can often pass inspection with basic ventilation and a small grease trap.
- A restaurant with a grill line and a deep fryer needs a full kitchen hood suppression system, gas safety certification if you are running LPG, and a grease trap sized for actual cooking oil volume, not just dishwashing runoff.
Both formats start from the same base unit. Whichever activity you choose, the container itself is built and modified around your menu, which is where a fabricator’s range of container units and layouts becomes useful to browse before you commit to a size.
Cafe vs. Restaurant, Side by Side
| Factor | Container Cafe | Container Restaurant |

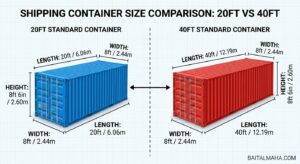

| Typical container size | 10ft–20ft | 20ft–40ft (or two combined) |
| License activity | Cafeteria / coffee shop | Restaurant / full F&B |
| Kitchen equipment | Espresso machine, panini press, fridges, blenders | Full cook line: grill, fryer, hood, gas or induction stations |
| Civil Defence scope | Basic fire extinguishers, simple ventilation sign-off | Kitchen hood suppression system, LPG gas approval (if applicable), heat-detecting fire alarm |
| Seating | 0–15 covers, often takeaway-first | 15–60+ covers |
| Realistic total cost | AED 180,000–350,000 | AED 350,000–1,200,000+ |
Quick Decision Checklist
Answer these four questions before you pick a container size.
- Does your menu need an open flame, grill, or deep fryer, or is it espresso, blended drinks, and pre-made food only?
- Do you want customers seated inside or under an attached shade structure, or is this a takeaway and delivery-first concept?
- Will your kitchen produce enough used cooking oil to require a grease trap sized above the minimum?
- Do you plan to run LPG gas cylinders on-site, which triggers a separate Civil Defence gas safety submission?
If you answered yes to the first and third questions, you are building a restaurant, not a cafe. Budget accordingly from day one. Confusing the two is one of the most common reasons container F&B projects go over budget: an operator licenses and builds for a cafe, then decides mid-project to add a grill station, and ends up redoing ventilation, electrical load, and fire suppression work that should have been designed in from the start.
Container Cafe & Restaurant Dubai Cost by Container Size
Most articles quote one flat range for container restaurant cost and stop there. That is not useful when a 20ft coffee container and a 40ft double-unit restaurant with an outdoor seating deck are entirely different investments. Here is how the numbers actually split by size and use case.
| Configuration | Best For | Realistic Seating | Total Setup Cost (AED) |
| Single 20ft container | Specialty coffee, juice bar, dessert kiosk, grab-and-go | 0–10, mostly takeaway | 180,000 – 350,000 |
| Single 40ft container | Small quick-service restaurant, casual dine-in | 15–30 | 350,000 – 700,000 |
| Double 40ft, combined or side-by-side | Full-service restaurant with open kitchen and dine-in hall | 30–60+ | 700,000 – 1,200,000 |
| Premium double-container with outdoor deck, solar, and branded exterior | Flagship or destination concept | 40–80, including outdoor seating | 1,000,000 – 1,500,000 |
A useful way to think about it:
- Your container size decision is really a decision about your fire load classification and your annual rent, not just your floor space.
- A larger container means more electrical capacity, a bigger kitchen hood system, and a higher Civil Defence risk category. All three push inspection costs and processing time up, not just your fit-out budget.
- Several operators choose two smaller units connected by a covered walkway instead of one oversized container. This keeps each unit under a lower fire-risk threshold while still delivering the total floor area they want.
A few points tie these figures together.
- The one-time cost figures above sit within the AED 200,000–1.5 million range quoted across most industry sources.
- A detailed cost breakdown published by PortaCabins UAE puts modified container restaurants in the UAE at roughly AED 300,000 to AED 800,000 before site works and premium finishes, broadly consistent with the mid-range figures above once land rent and permits are added on top.
- The exact figure for your project also depends heavily on the structural modification and conversion work involved, since a straightforward coffee counter and a full commercial kitchen require very different levels of container conversion.
- If you already have a container size and site in mind, it is worth requesting a fixed-price quote before locking in a budget, since actual fabrication cost varies more by design complexity than by container size alone.
Container Cafe & Restaurant Dubai: Complete Line-Item Cost Table
Most setup guides stop at four or five bullet points. In practice, a container F&B project has at least a dozen distinct cost lines. Missing even two or three of them is what turns a AED 350,000 budget into a AED 480,000 actual spend.
| Cost Item | Typical Range (AED) | Notes |
| Container unit + structural modification | 70,000 – 350,000 | Insulated, fire-rated, window/door cutouts, waterproofing for Dubai heat |
| Kitchen equipment | 50,000 – 250,000 | Scales heavily with cafe vs. restaurant tier |
| Interior fit-out & branding | 30,000 – 150,000 | Flooring, walls, lighting, furniture, signage inside |
| DET trade license (F&B activity) | 12,000 – 25,000 | Mainland license covering restaurant or cafeteria activity |
| Dubai Municipality food safety approval | 2,000 – 8,000 | Kitchen layout sign-off, HACCP-aligned plan |
| Civil Defence approval & fire suppression | 15,000 – 50,000 | Kitchen hood suppression, fire alarm, extinguishers, LPG approval if applicable |
| Grease trap installation | 4,500 – 14,000 | Larger commercial kitchens can run higher; sizing must match cooking oil output |
| Foundation & groundworks | 15,000 – 40,000 | Covered in full further down this guide |
| DEWA connection / 3-phase power upgrade | 5,000 – 30,000 | Depends on whether the site already has 3-phase supply |
| Signage permit | 1,500 – 5,000 | Separate from the trade license; often forgotten until branding is already printed |
| Insurance (public liability + equipment) | 3,000 – 10,000 per year | Not legally optional in practice for a public-facing F&B unit |
| POS system + payment gateway setup | 3,000 – 12,000 | Hardware plus first-year software fees |
| Site rent (annual) | 20,000 – 150,000+ | Varies enormously by zone |
| Contingency buffer | 10–15% of total budget | Covers inspection rework, material price swings, delays |
A few of these deserve a closer look, because they are the ones that catch first-time operators off guard.
- Grease traps are sized to your kitchen’s actual grease output, not to your container’s floor area. A coffee-and-pastry cafe with minimal frying can often use a smaller, cheaper trap. A restaurant running a grill and fryer needs a trap sized for that volume. Dubai Municipality will reject an undersized installation outright, forcing a costly mid-project swap.
- Signage permits are issued separately from your trade license by the relevant authority overseeing your site. Operators who print and install branded signage before securing this approval sometimes have to remove and reorder it to match approved specifications. This is an avoidable cost if the permit is sequenced correctly.
- Civil Defence fire suppression for any container running an open flame, grill, or deep fryer needs a wet chemical suppression system rated for Class K cooking oil fires, not a standard fire extinguisher. Kitchen fires are consistently cited as a leading cause of restaurant fire incidents, which is exactly why Dubai Civil Defence treats this approval as non-negotiable before issuing final sign-off.
One more point worth flagging on kitchen equipment specifically:
- Costs swing significantly based on layout, not just equipment count.
- A grill line laid out for a Southeast Asian street food menu needs a different footprint than an espresso bar.
- Equipment is usually planned alongside the kitchen layout itself rather than bought off a generic list, since layout mistakes are expensive to fix once the container is fabricated.

Foundation and Groundworks for a Container Cafe & Restaurant Dubai Project
This is the section that separates a genuine setup guide from a repackaged summary. A shipping container is a steel structure weighing several tonnes. It cannot simply be placed on bare sand or unprepared ground and expected to stay level, drain properly, and pass inspection. Almost every published article on this topic skips straight from “container delivered” to “utilities connected,” and that gap is exactly where budgets go wrong.
Before a container is positioned on-site, the plot typically needs the following groundwork.
- Ground survey and load-bearing check. Confirms the soil or existing surface can support the container’s weight without shifting or settling unevenly over time.
- Levelling and compaction. Uneven ground causes doors and windows to warp over time, which is a common reason for failed re-inspections months after opening.
- Plinth or pier foundation. Concrete piers or a shallow plinth raise the container off the ground, protect the underside from moisture, and create a clean surface for utility connections. This typically costs AED 15,000–30,000 depending on plot size and soil condition.
- Drainage slope. The plot needs to be graded so rainwater and wash-down water drain away from the unit rather than pooling underneath it, which protects both the structure and the grease trap connection.
- Utility trenching. Water, drainage, and electrical lines need to be trenched from the nearest connection point to the container, which adds cost the further the container sits from existing infrastructure.
Skipping or underbudgeting this stage is one of the most expensive mistakes an operator can make, because fixing a poorly founded container after installation almost always costs more than doing it correctly the first time. Budget AED 15,000–40,000 for foundation and groundworks depending on plot condition, and treat it as a mandatory line item, not an optional upgrade.
Hidden and Recurring Costs of Running a Container Cafe & Restaurant Dubai
The one-time setup budget gets all the attention. The monthly running costs are what actually determine whether your container cafe or restaurant survives its first year.
Typical Monthly Operating Costs
| Expense | Cafe (Monthly, AED) | Restaurant (Monthly, AED) |
| Site rent, prorated | 2,000 – 5,000 | 4,000 – 12,000 |
| DEWA utilities | 1,500 – 3,000 | 3,000 – 6,000 |
| Staff wages, lean team | 8,000 – 14,000 | 14,000 – 25,000 |
| License & permit renewals, prorated | 1,000 – 2,000 | 2,000 – 4,000 |
| Food cost | 25–32% of revenue | 28–35% of revenue |
| Maintenance, AC servicing, general upkeep | 500 – 1,500 | 1,000 – 3,000 |
Add these up and the pattern becomes clear.
- A lean container cafe typically runs AED 13,000–25,000 a month in fixed costs before food and variable expenses.
- A full container restaurant sits closer to AED 25,000–50,000 a month.
- Both figures remain well below what a comparably sized traditional brick-and-mortar restaurant pays in rent and fit-out depreciation alone, but neither is close to zero. Too many first-year budgets only plan for the opening-day spend and stop there.
Three recurring costs deserve specific attention.
- Relocation cost. If your site lease ends, or a better location opens up, moving a container is not free. Teardown, transport, reinstallation, and re-permitting at the new site typically runs AED 15,000–40,000 depending on distance and whether utility connections need to be redone from scratch. It is still far cheaper than breaking a three to five year lease on a traditional restaurant space, but it is a real cost that belongs in your contingency planning.
- Seasonal utility swings. Dubai’s summer cooling load is dramatically higher than winter. A container running standard air conditioning can see DEWA bills rise noticeably between the cooler October–April months and peak summer heat, particularly if the kitchen’s ventilation system is not separating cooking heat from the dining area efficiently. Budgeting one flat monthly utility figure without accounting for this swing is a common first-year miscalculation.
- Foundation upkeep. The plinth and drainage grading covered above are not a one-time-only concern. Grading can shift slightly over multiple summers of ground heat expansion, and periodic checks every year or two prevent small drainage issues from becoming expensive structural ones.

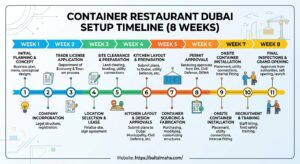

Step-by-Step Setup Process for a Container Cafe & Restaurant Dubai Project
Here is the process broken into the stages Dubai’s system actually requires, with the department involved and a realistic processing window for each.
Reserve your trade name and get initial activity approval.
Handled through the Dubai Department of Economy and Tourism (DET), either through the Dubai Invest portal or in person. You will select your F&B activity code, cafeteria or restaurant, and reserve a trade name that does not imply claims you cannot yet substantiate, such as “Halal” without the matching Municipality certification. This step typically clears within a few days once documentation is in order, though name rejections for misleading or duplicate names are common and can add a week.
Decide your legal structure and jurisdiction.
Most container concepts that plan to serve the general public need a mainland DET license rather than a free zone one, since free zone licenses generally restrict you to serving customers within that free zone. This is a decision point almost every quick guide skips, and getting it wrong means re-licensing later.
Secure your site lease and Ejari registration.
Your plot needs to be zoned for F&B use. Commercial, mixed-use, or designated tourism zones typically qualify; purely residential plots usually do not. This is also where your annual rent gets locked in, so confirming zoning before signing saves you from a lease you cannot legally operate under.
Container design and structural fabrication begins.
Fire-rated insulation, window and door cutouts, electrical rough-in, and plumbing hookups happen at this stage, typically running in parallel with Step 5 rather than after it. This parallel-track approach is exactly what compresses the timeline from months to weeks.
Submit MEP and layout drawings to Dubai Municipality.
This covers your kitchen zone layout, handwashing station placement, cold storage arrangement, and grease trap sizing and location. Municipality reviewers check against HACCP-aligned hygiene standards, and incomplete drawings are the single biggest cause of delay at this stage.
Complete foundation and groundworks.
This needs to happen before or during container positioning, not as an afterthought once the unit has already arrived on-site.
DEWA connection and load assessment.
Commercial kitchens generally require 3-phase power. If your site previously ran on single-phase supply, this upgrade needs to be requested and approved before final connection.
Dubai Civil Defence fire safety submission.
This is a separate drawing package from your Municipality submission, covering kitchen hood suppression, fire alarm and heat detection, emergency lighting, and, if you are using LPG gas, a distinct gas safety submission that typically has to be processed sequentially rather than alongside the main fire safety package. Budget extra time here if your concept involves gas cooking.
Final inspections across all three authorities.
Dubai Municipality inspects the completed kitchen against the approved layout. Civil Defence inspects the installed suppression and alarm systems. DEWA confirms the electrical connection matches the approved load. All three typically need to pass before your trade license is finalized.
Staff health cards and Person in Charge (PIC) food safety certification.
Every food handler needs an occupational health card, and at least one staff member needs PIC certification confirming completion of Dubai’s food safety training. This can be arranged in parallel with earlier construction steps so it does not become a bottleneck at the end.
Soft launch, then grand opening.
A short soft-launch period lets you stress-test kitchen workflow and staff training with real, lower-volume customers before a full public opening.
Run end to end without major snags, this entire sequence lands inside the 6–8 week window most industry sources quote. Where projects slip, it is almost always at Step 8, gas safety submissions arriving late, or Step 5, incomplete Municipality drawings bouncing back for revision. Both are entirely avoidable with correct sequencing from day one, which is exactly where working with a fabrication team experienced across Dubai Municipality and Civil Defence approvals tends to save the most time.

Container Cafe & Restaurant Dubai: Site Rent by Zone
The “AED 30,000–100,000+ per year” rent figure quoted everywhere hides a huge range depending on exactly where you place the container. Here is a more useful breakdown by zone type.
| Zone Type | Examples | Typical Annual Rent (AED) | Best Fit |
| Business & industrial districts | Al Quoz, Dubai Investment Park | 25,000 – 60,000 | Lunch-focused restaurant or coffee container serving office workers |
| Emerging residential communities | Dubai South, Motor City, Studio City | 20,000 – 45,000 | First-mover cafe or casual restaurant in underserved areas |
| Event & entertainment districts | Near Dubai Arena, La Mer, Bluewaters | 60,000 – 150,000+ | Concepts that can flex hours around event schedules |
| Mall & community pop-up plots | Community retail centers, mixed-use developments | 40,000 – 90,000+ | Established concepts wanting consistent daily footfall |
A few things to keep in mind when comparing zones.
- These figures are estimates based on typical market ranges, and they vary by exact plot, landlord, and lease term length.
- Always confirm current rates directly with the landlord or free zone authority before finalizing a location, since commercial rent in Dubai shifts with broader market conditions.
- Container sites are frequently leased on 6–12 month terms rather than the 3–5 year commitments traditional restaurants sign, so a rent figure that looks high on paper is still a far shorter-term commitment than it would be for a fixed-structure restaurant in the same location.
- If you are torn between two zones, get in touch with your shortlist and concept. Matching container size to the right plot early avoids the redesign issues covered later in this guide.
Container Cafe & Restaurant Dubai vs. Food Truck, Kiosk, and Traditional Restaurant
If you have not fully committed to the container format yet, it is worth seeing how it stacks up against the other common low-cost F&B entry points in Dubai.
| Format | Typical Total Setup Cost (AED) | Setup Time | License Type | Seating | Mobility |
| Container cafe/restaurant | 180,000 – 1,200,000+ | 6–8 weeks | Cafeteria or restaurant (DET + DM + DCD) | Yes, dine-in possible | Relocatable, not mobile day-to-day |
| Food truck | 150,000 – 300,000, including vehicle | 8–12 weeks | Trade license + DM + RTA + DCD | No | Fully mobile |
| Kiosk | 80,000 – 200,000 | 4–6 weeks | Cafeteria/retail food activity | No, takeaway only | Fixed to one spot |
| Traditional restaurant, mid-range | 500,000 – 1,500,000+ | 8–12 months | Restaurant license (DET + DM + DCD) | Yes, full dine-in | None |
A few points stand out from this comparison.
- Food trucks require both a Dubai Municipality food establishment permit and a central kitchen arrangement for HACCP-compliant food preparation, since most trucks are not licensed to do full cooking on board. This catches a lot of first-time food truck applicants off guard, and it adds a recurring central-kitchen rental cost that container operators do not carry, since the container itself is the licensed kitchen.
- Food trucks also need Roads and Transport Authority approval on top of the usual Municipality and Civil Defence sign-offs, since the vehicle itself is regulated as a road vehicle, not just a food premises.
- Kiosks are the cheapest and fastest option, but they cap out at takeaway-only service with no dine-in capacity, which limits revenue per transaction compared to a seated container restaurant.
- Traditional restaurants remain the most expensive and slowest route by a wide margin, and that gap is exactly why the container model has gained so much traction with first-time Dubai F&B operators over the past few years. Browsing a portfolio of completed container restaurant and cafe projects is usually a faster way to judge fit than comparing spec sheets alone.
A Hybrid Model Worth Considering
Some operators are not choosing between formats at all. They are combining them.
- A container serves as the fixed, licensed kitchen and dine-in space at a primary location.
- A food truck, run under the same brand and sometimes the same kitchen license through a shared central kitchen arrangement, covers weekend festivals, corporate events, and seasonal markets.
This hybrid approach spreads revenue across both a stable daily location and short-term, high-margin event opportunities, without requiring a second full container build. It is rarely mentioned in setup guides, largely because most guides treat each format as a standalone decision rather than as pieces of the same business.
Container Cafe & Restaurant Dubai: Five-Year Cost of Ownership
A one-time setup number tells you what it costs to open. It does not tell you what it costs to actually own and run the business over time, which is the number that matters most to anyone comparing formats seriously. Here is a five-year estimate for a mid-tier container restaurant against a comparably sized traditional restaurant, combining setup cost, five years of rent, five years of fixed operating costs, and one relocation event for the container, a realistic assumption over a five-year span.
| Cost Category | Container Restaurant (40ft) | Traditional Restaurant (Mid-Range) |
| Initial setup cost | 500,000 | 900,000 |
| Five years of rent | 250,000 (avg AED 50,000/year) | 1,750,000 (avg AED 350,000/year) |
| Five years of fixed operating costs | 1,500,000 (avg AED 25,000/month) | 4,200,000 (avg AED 70,000/month) |
| One relocation event | 30,000 | Not applicable, but lease renewal risk applies instead |
| Estimated five-year total | 2,280,000 | 6,850,000 |
A few things to note about this comparison.
- These are directional estimates built from the ranges used throughout this guide, not a guarantee for any specific concept, location, or operator.
- The gap widens the longer both businesses operate, since the container format’s lower fixed costs compound every single month.
- A traditional lease typically carries built-in annual rent increases that a short-term container lease does not, which is one more reason the five-year gap grows rather than stays flat.

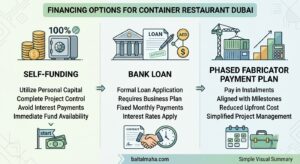

Financing Your Container Cafe & Restaurant Dubai Project
Most container F&B projects get funded through one of three routes, and each comes with its own documentation expectations.
- Self-funding. The most common route for smaller cafe-scale projects. It keeps you free of loan repayments during your slowest early months, but it ties up personal capital that could otherwise cover a longer contingency runway.
- Bank business loans. UAE banks generally want to see a detailed business plan, projected cash flow for at least 12–24 months, your trade license or approval to obtain one, and a signed site lease before considering a loan application. A firm cost proposal from your container fabricator, showing exactly what is included and what is not, makes this process considerably smoother, since banks are wary of open-ended construction budgets.
- Phased payment plans with your fabrication partner. Many container suppliers structure payments around project milestones rather than requiring the full amount upfront. This spreads cash flow pressure across the build timeline instead of front-loading it entirely. It is worth asking any fabricator you contact for a proposal whether this kind of phased structure is available before you finalize a bank application.
Realistic break-even expectations differ by tier.
- A well-positioned coffee container with low overhead can often reach positive cash flow within 4–8 months of opening.
- A full container restaurant, carrying higher staff and food costs, more commonly reaches break-even in the 8–14 month range.
These are general expectations, not guarantees. Your actual timeline depends on location, concept execution, and local competition, so treat any projection, including this one, as a planning input rather than a promise. Where significant capital is involved, a conversation with a licensed financial advisor or your bank is worth having before committing.
A Worked Break-Even Example
Numbers are easier to trust when they are worked through rather than just stated as a range. Take a mid-tier single 40ft container restaurant with a total setup cost of AED 500,000 and monthly fixed operating costs of AED 30,000.
- Average spend per customer: AED 45.
- Food cost at 30 percent of revenue leaves a gross margin of roughly AED 31.50 per customer once direct food cost is removed.
- Fixed monthly costs of AED 30,000 divided by that gross margin per customer means the business needs to serve approximately 952 customers a month, or roughly 32 customers a day, just to cover fixed costs.
- At that daily volume, the AED 500,000 setup cost is typically recovered, after accounting for a reasonable profit margin on top of break-even, somewhere between 10 and 14 months of steady trading.
This is one illustrative scenario, not a forecast for any specific concept. A higher average spend, a stronger location, or tighter food cost control shortens this timeline considerably, while a slower location or thinner margins extends it. The exercise is worth repeating with your own numbers before committing to a site or a container size.
Common Mistakes When Setting Up a Container Cafe & Restaurant in Dubai
- Choosing container size before confirming plot zoning. Operators sometimes commit to a 40ft double-container layout, then discover their preferred plot’s zoning or available footprint will not accommodate it. This forces a costly redesign or a search for a new site entirely. Confirm the plot first, and size the container second.
- Skipping fire-rated insulation to save on upfront cost. A cheaper, non-fire-rated insulation package looks like an easy saving during fabrication, but it fails Civil Defence inspection outright. Retrofitting fire-rated material into an already-assembled container costs considerably more than installing it correctly the first time.
- Signing a site lease before securing trade name and activity approval. Rent starts accruing the moment a lease is signed, whether or not your licensing is moving forward. Sequencing this correctly, name and activity approval first and lease second, avoids paying for months of unused site rent while paperwork catches up.
- Underestimating grease trap sizing for a full cooking line. As covered earlier, a trap sized for light cafe use will fail inspection under restaurant-level cooking volume. Swapping it out mid-project after plumbing is already installed is one of the more expensive rework jobs on this list.
- Printing signage before the signage permit is approved. Exterior branding is one of the most exciting parts of launching a new concept, and it is tempting to order it early. If the approved permit specifies different dimensions or placement than what has already been printed, that branding often has to be redone at your own cost.
- Skipping the ground survey and foundation stage. Placing a container directly on unprepared ground leads to warped doors, drainage failures, and re-inspection issues that cost far more to fix after installation than to prevent before it.
Container Cafe & Restaurant Dubai: Quick Reference Cost & Timeline
| Tier | Container Size | Total Setup Cost (AED) | Monthly Operating Cost (AED) | Timeline | License Type |
| Compact cafe | 10ft–20ft | 180,000 – 350,000 | 13,000 – 25,000 | 6–7 weeks | Cafeteria |
| Small restaurant | 40ft single | 350,000 – 700,000 | 20,000 – 38,000 | 7–8 weeks | Restaurant |
| Full-service restaurant | Double 40ft | 700,000 – 1,200,000 | 30,000 – 50,000 | 8 weeks | Restaurant |
| Flagship/premium | Double 40ft + deck | 1,000,000 – 1,500,000 | 35,000 – 55,000 | 8–10 weeks | Restaurant |
Container Cafe & Restaurant Dubai FAQs
Is a container restaurant legal in Dubai? Yes. A container restaurant or cafe follows the same DET trade license, Dubai Municipality food safety approval, and Civil Defence fire safety process as any fixed restaurant. The structure type does not change the licensing requirement.
How much does it cost to open a small restaurant in Dubai? A small container-based restaurant typically costs AED 350,000 to 700,000 to set up, compared to AED 500,000 to 1.5 million for a traditional small restaurant. Rent, kitchen equipment, and container size all affect the final figure.
How long does it take to get a restaurant license in Dubai? Licensing alone can clear in a few weeks once documents are in order, but the full process, including fit-out, Municipality approval, and Civil Defence sign-off, typically takes 6 to 8 weeks for a container setup.
Is a container restaurant profitable in Dubai? Profitability depends on location, concept, and cost control, but lower setup and rent costs mean container restaurants often reach break-even faster than traditional restaurants, typically within 8 to 14 months for a full-service unit.
Do container restaurants need a fire safety certificate in Dubai? Yes. Any container with a cooking setup involving grills, fryers, or open flames needs Dubai Civil Defence approval, including kitchen hood suppression and fire alarm systems, before the trade license can be finalized.
What is the cheapest way to open a restaurant in Dubai? A single small container on a cafeteria license, sited in a business or industrial zone with a lean equipment list, is generally the lowest-cost legal entry point into Dubai’s F&B market.
The Bottom Line
Dubai’s foodservice market has been growing at a pace few global cities can match. The UAE foodservice sector was valued at roughly USD 27.28 billion in 2026 and is forecast by Mordor Intelligence to reach USD 61.21 billion by 2031, while Dubai’s restaurant sector alone generated an estimated AED 28.5 billion in revenue, according to industry data compiled by Gitnux, with quick-service formats expanding faster than any other segment.
That growth is exactly why the gap between a rushed, underbudgeted container project and a properly sequenced one matters so much. The container cafe and restaurant model in Dubai genuinely does compress cost and timeline compared to a traditional restaurant build, but only when three things are handled correctly from the very first step:
- The right size and license path for your concept, cafe or restaurant.
- Correct sequencing across DET, Dubai Municipality, DEWA, and Civil Defence.
- Proper foundation, grease trap, and fire suppression planning before construction begins, not after inspection fails.
If you are weighing a cafe against a full restaurant, sizing a container against a specific plot, or trying to build a realistic budget before talking to a bank, a direct conversation with a team that has actually taken units through Dubai Municipality and Civil Defence inspection will save far more time than piecing the process together from general guides. You can see examples of that process in our container restaurant and cafe projects, or get in touch directly if you would rather talk through your concept and plot before finalizing a budget.
