Container conversion Services in Dubai is the process of structurally rebuilding a standard steel shipping container into a functional office, cafe, home, or accommodation unit, using reinforced framing, climate-rated insulation, and full electrical and plumbing fit-outs. Local fabricators deliver these units to active sites across JAFZA, Dubai South, DIP, and Al Quoz within weeks rather than the months a traditional build would take. This is why the approach has become the default choice for site offices, labor housing, and pop-up retail across the emirate.
That is the short answer. The longer answer, the one that actually matters once you are staring at a quotation or trying to figure out whether a converted container will pass Civil Defense inspection, takes a bit more unpacking. Dubai’s container conversion market has grown fast enough that it now includes everything from a bare-bones AED 20,000 site cabin to a fully livable, air-conditioned modular home that costs as much as a small apartment. Knowing where your project sits on that spectrum, and what actually drives the price and the paperwork, is what this guide is built to explain.
What Is Container Conversion Services ?
Container conversion Services is the structural and mechanical transformation of a standard ISO shipping container into a purpose-built space. It typically involves wall cutting for doors and windows, steel reinforcement around the openings, spray-foam or panel insulation, electrical wiring, and in many cases plumbing and HVAC. The container stops being a cargo box and becomes a building component, engineered to hold its shape once its steel skin has been cut into.
That distinction matters because the term “container conversion” gets used loosely online, often interchangeably with two other terms that actually mean something different.
- Container modification usually refers to smaller changes, such as adding a personnel door, a window, or shelving, without a full interior fit-out. A modified container can still be used for storage.
- Container conversion Services goes further. It means the unit is being rebuilt into a livable or workable space, with insulated walls, a finished floor, wiring, and often air conditioning.
- Modular building refers to a structure assembled from multiple converted containers, stacked or connected side by side, engineered as a single building rather than a collection of separate boxes.
Fabricators in the UAE typically work with four container types for conversion projects.
- 20ft standard container. Roughly 5.9 metres long with a 2.35 metre internal height. The most common choice for single-room offices, guard cabins, and kiosks.
- 40ft standard container. Doubles the floor area of a 20ft unit, making it suitable for larger offices or multi-desk workspaces.
- 40ft high cube container. Adds around 30 centimetres of extra internal height over the standard 40ft. This becomes noticeable once ceiling-mounted AC ducting and lighting are installed, which is why it has become the preferred size for container offices and livable conversions in the UAE.
- Reefer (refrigerated) container. Occasionally repurposed for cold storage units or specialist applications, since the factory insulation is already far heavier than a standard dry container’s.
Why Dubai Has Become a Container Conversion Hub
Dubai’s container conversion demand comes down to three overlapping forces: a construction sector that needs infrastructure fast, a regulatory push toward sustainable building, and a free zone economy where project sites open and close on tight timelines.
- Free zone construction cycles drive constant turnover. JAFZA, Dubai Investment Park, Dubai South, and Al Quoz collectively host thousands of active logistics, manufacturing, and trading operations at any given time. Each new tenant typically needs a site office, security cabin, or storage unit within weeks of signing a lease, long before a permanent building is even an option. A converted container can be delivered, connected, and occupied while a traditional structure is still at the design-approval stage.
- Labor accommodation regulation is a direct demand driver. Under UAE labor law, any establishment with 50 or more workers earning AED 1,500 or less per month must provide accommodation, and that housing has to meet specific space, ventilation, and facility standards set by the Ministry of Human Resources and Emiratisation. Converted containers are one of the fastest ways for contractors to stand up compliant accommodation blocks on or near active construction sites.
- Speed against traditional construction is the core value proposition. A conventional single-story site office in Dubai can take two to three months from design approval to handover once foundation work, block-and-mortar construction, and MEP fit-out are accounted for. Installed in a single day once it arrives, because the structural shell, insulation, and most of the electrical work are already finished before the unit reaches the plot.
For businesses tracking ESG commitments, a container conversion is one of the few construction options that can be pointed to as evidence of circular-economy practice rather than just a cost-saving measure.
Types of Container Conversions Available in Dubai
Most articles on this topic list four or five conversion types and stop. In practice, Dubai fabricators handle a much wider range of use cases, and each one comes with its own fit-out priorities.
- Mobile and site offices. The most common conversion by volume. A single 20ft or 40ft unit gets insulated walls, split-unit AC, electrical wiring for desks and lighting, and usually a small pantry or storage nook. These are built for construction site management, JAFZA and DIP compliance offices, and temporary administrative space while a permanent building goes up. Turnaround from order to delivery typically runs three to five weeks for a standard fit-out.
- Labor and staff accommodation units. These require a different design brief entirely. Bunk configurations have to respect MOHRE’s space-per-worker rules, ventilation needs to handle continuous occupancy rather than daytime-only use, and fire safety detection has to meet Civil Defense standards for residential occupancy rather than commercial. Triple-decker beds are prohibited under current labor accommodation rules, which affects how many workers a single converted unit can legally house.
- Cafes, kiosks, and pop-up retail. Food-service conversions carry the heaviest mechanical load of any container type. Beyond insulation and AC, they typically need plumbing for a wash station, extraction hoods and ducting for cooking equipment, a serving window cut into the container wall with weatherproof shuttering, and grease-trap provisions if food is being cooked rather than just served. These units show up at beachside kiosks, mall pop-up events, and standalone roadside cafes.
- Site security cabins and guard posts. The simplest and cheapest conversion category. A single container gets a window, a door, basic lighting, and sometimes a small AC unit, with minimal interior fit-out. These are usually the fastest to produce and the first unit ordered on any new site.
Design and Customization Options
Once the structural and mechanical basics are settled, most clients underestimate how much design flexibility a converted container actually offers. This is not a one-look-fits-all product, and the finish choices matter both for how the space functions day to day and for how it reads to visitors, staff, or customers.
- Exterior cladding and branding. A container does not have to look like a container once it is finished. Composite cladding panels, timber-look finishes, or a simple painted and branded exterior are all common choices. For retail or cafe conversions in particular, exterior branding is often what makes the unit recognizable from a distance on a busy site or roadside location.
- Window and door configuration. The number, size, and placement of window and door openings has a direct effect on both natural light and structural cost, since every opening needs reinforcement to compensate for the steel removed.
- Interior finishes. Flooring options range from basic vinyl or laminate through to more durable epoxy coatings for high-traffic commercial units. Wall finishes typically use insulated wall panels rather than painted drywall, since panels hold up better against the internal condensation risk discussed in the climate engineering section. Ceiling height can be increased slightly by recessing the AC ducting into a bulkhead rather than running it exposed, a small design choice that makes a noticeable difference in how spacious a converted unit feels once furnished.
- Solar and off-grid options. For remote sites without reliable grid access, or for clients specifically chasing sustainability credentials, rooftop solar panels can be integrated directly into a container conversion Services, paired with battery storage sized to the unit’s electrical load.
The Container Conversion Process, Step by Step
Understanding the sequence helps explain both the timeline and where costs get added.
- Structural assessment and container sourcing. The fabricator inspects or sources the container, checking for a valid CSC (Container Safety Convention) plate, corrosion damage, and floor condition, then decides whether a new or one-trip unit or a used cargo-worthy unit is the right starting point for the project.
- Design and engineering drawings. Structural load calculations are prepared, especially important for any conversion that involves cutting large openings, stacking units, or adding a second floor. These drawings are also what gets submitted for JAFZA, Dubai Municipality, or Civil Defense approval.
- Cutting, framing, and reinforcement. Openings for doors, windows, and service penetrations are cut, and steel framing is welded around each opening to restore the structural strength lost when the corrugated steel skin is removed.
- Insulation and climate control installation. This is where Dubai conversions diverge sharply from conversions built for temperate climates, covered in detail in the next section.
- Electrical, plumbing, and fit-out. Wiring, lighting, sockets, and, where relevant, plumbing lines get installed, followed by interior finishes such as flooring, wall panels, and cabinetry.
- Quality inspection and delivery. The finished unit is inspected for weatherproofing, electrical safety, and finish quality before being transported and craned into position on-site.
Timeline ranges vary by complexity.
- A basic security cabin or single-room office can be ready in two to three weeks.
- A fully fitted office with AC, plumbing, and custom joinery typically takes four to six weeks.
- Multi-container modular buildings, because they involve more structural engineering and a longer approval cycle, commonly run eight to twelve weeks from order to handover.
Engineering for Dubai’s Climate
This is the part most container conversion articles skip entirely, and it is arguably the most important technical decision in the whole project. A conversion built to specifications common in Europe or North America will genuinely fail in Dubai’s summer, not just perform poorly.
Standard insulation is not enough
A shipping container is a sealed steel box, and steel is an excellent heat conductor. Without proper insulation, the interior of a container sitting in direct Dubai sun can climb well above ambient temperature within a couple of hours. Dubai-grade conversions typically use closed-cell spray-foam or rigid polyurethane foam insulation at a thickness noticeably greater than what a fabricator in a cooler climate would specify, combined with a reflective or heat-resistant roof coating to cut down on radiant heat gain through the largest exposed surface.
HVAC has to be sized for the load, not just the floor area
Research on UAE building performance points to Gulf-climate buildings needing roughly 30 to 40 percent more cooling capacity than the global standard sizing guidelines would suggest for a building of the same footprint. Undersizing the AC unit on a container conversion is a common and expensive mistake. The system ends up running at maximum output nearly continuously, wears out faster, and still struggles to hold a comfortable temperature on the hottest days of the year.
Corrosion resistance needs to account for humidity and coastal exposure
Dubai’s summer humidity, combined with salt-laden air near the coast, accelerates corrosion faster than a dry inland climate would. Conversions intended for long-term use benefit from marine-grade anti-corrosive primer and paint systems, not just a standard exterior coat, particularly around welded joints and cut edges where the factory coating has been disturbed.
Ventilation design matters even in AC-dependent units
Units that are not continuously air-conditioned, such as storage-adjacent spaces or overflow labor accommodation, need passive ventilation designed specifically to prevent condensation build-up. Trapped humidity inside a sealed steel box is one of the fastest ways to start interior corrosion and mold growth.
Free Zone Compliance and Approvals
This is the section most competitor articles leave out entirely, and it is often the single biggest source of delay on a container conversion Services project. Approval pathways differ depending on where the container is going, and getting this wrong means a stop-work order, a fine, or in the worst case, a mandatory removal of a unit that has already been installed.
JAFZA (Jebel Ali Free Zone)
Any physical modification within JAFZA, including placing a converted container on a plot, falls under the jurisdiction of Trakhees, JAFZA’s engineering and licensing authority, rather than Dubai Municipality directly. Every structural addition requires a Trakhees Building Permit before installation, and once construction is complete, an Operational Fitness Certificate from the Trakhees EHS department is required before the unit can legally be occupied. As of 2026, JAFZA’s Engineering Department has moved to requiring BIM-compatible submissions for structural modifications. Standard fit-outs can still be submitted as AutoCAD drawings as long as an IFC data file is attached, but anything involving structural changes, such as a stacked or multi-unit conversion, needs a full 3D model built in Revit, Tekla, or an equivalent platform. JAFZA also conducts quarterly inspections of installed units, and unapproved works are treated as a compliance violation, not a minor paperwork gap.
Dubai Investment Park and Al Quoz
Unlike JAFZA, plots in DIP, Al Quoz, and Ras Al Khor fall under standard Dubai Municipality and Civil Defense jurisdiction rather than Trakhees. This generally means a more familiar municipal building-permit process, but it still requires submitted drawings, structural sign-off, and Civil Defense clearance for fire safety before a converted container can be occupied.
Dubai South
As a newer free zone built around Al Maktoum International Airport and the Expo 2020 site legacy area, Dubai South runs its own facilities and engineering approval process for tenants, similar in spirit to JAFZA’s Trakhees system but administered through Dubai South’s own authority. Businesses installing container units here should confirm current submission requirements directly with the Dubai South facilities team, since a fabricator with recent project experience there will know the current process rather than an outdated version of it.
Civil Defense fire safety sign-off
Regardless of which free zone or municipal jurisdiction applies, any occupied structure, including a converted container used as an office, cafe, or accommodation unit, needs to meet Dubai Civil Defense fire safety standards. This typically covers smoke detection, fire extinguisher placement, clear emergency egress, and for labor accommodation specifically, sprinkler or detection systems appropriate to the occupancy load.
DEWA connection
Getting electricity and water connected through the Dubai Electricity and Water Authority is a separate process from the building permit itself, and it needs to be planned for early since DEWA connection timelines can run in parallel with, rather than after, the physical installation of the unit.
Realistic timeline expectations vary significantly by free zone and by how complex the submission is.
- A straightforward single-unit office conversion in a municipality-governed area can often clear approval in a few weeks.
- A JAFZA submission involving structural review should be budgeted at several weeks to a few months.
- A multi-container modular building, in any jurisdiction, should also be budgeted at several weeks to a few months.
Building this into your project timeline from the start avoids the common mistake of ordering a container conversion on a tight deadline only to discover the approval process alone will outlast it.
This section is general guidance based on published regulatory information and is not a substitute for legal or engineering advice specific to your project. Approval requirements and fee structures are set by the relevant authority and can change, so confirm current requirements directly with JAFZA, Dubai Municipality, Dubai South, or Civil Defense before finalizing a project timeline.
How Much Does Container Conversion Services Cost in Dubai?
Cost is the question everyone actually wants answered first, and it is also the question competitor pages tend to dodge with vague language like “affordable” or “cost-effective” instead of numbers.
Four factors do most of the work in determining a final price.
- Container condition. New or one-trip versus used.
- Container size. 20ft versus 40ft or 40ft high cube.
- Fit-out complexity. A bare office shell versus a plumbed cafe or livable home.
- Insulation and HVAC specification. Standard versus Dubai-grade climate engineering, discussed earlier in this guide.
Starting price points. A basic 20ft container office conversion in Dubai, with standard insulation, a single AC unit, and simple electrical fit-out, starts at roughly AED 23,575 based on current market pricing for standard specifications. That figure climbs from there once you add plumbing, custom cabinetry, higher-grade insulation, or a larger footprint. A 40ft or 40ft high cube conversion with a fuller fit-out typically lands well above that baseline, and cafe or clinic conversions with plumbing and specialist equipment sit higher still because of the added mechanical trades involved.
Relative cost tiers by use case, from lowest to highest complexity:
- Security cabins and basic guard posts sit at the low end, since they need minimal insulation and no plumbing.
- Standard site offices come next, with insulation, AC, and electrical fit-out but no wet trades.
- Labor accommodation units cost more per square meter than a comparable office because of the ventilation, fire safety, and multi-occupancy electrical requirements.
- Cafes, kiosks, and clinics carry the highest per-unit cost among single-container conversions, driven by plumbing, extraction, and specialist fixtures.
- Livable residential conversions and multi-container modular buildings sit at the top of the range, combining full mechanical, electrical, and plumbing fit-out with the structural engineering needed for stacking or connecting units.
Comparison against traditional construction. A block-and-mortar site office of comparable size typically costs more per square meter once foundation work, masonry, and a full MEP fit-out are accounted for, and it takes considerably longer to complete. The value case for container conversion is not just the unit price but the combination of lower upfront cost and a fraction of the construction timeline, which matters most for businesses that need infrastructure on a fixed project schedule rather than an open-ended one.

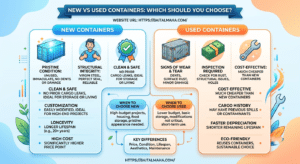

New vs Used Containers: Which Should You Choose?
This decision affects both the upfront cost and the long-term durability of the finished conversion, and it is worth understanding the grading system before comparing prices.
- New and one-trip containers. A one-trip container has made a single ocean voyage from the factory, which means it is close to new condition with minimal wear, no significant dents, and intact factory paint. These start at a higher price point than used units but need the least remedial work before conversion begins, which can offset some of that premium in labor costs. For a livable home conversion or any project where long-term durability matters most, a new or one-trip container is generally the safer starting point.
- Used containers and grading. Used containers are typically sold under one of three grades.
○ Cargo-Worthy. The unit is still certified fit to carry cargo and structurally sound despite cosmetic wear.
○ Wind and Water Tight. The unit will keep out the elements but may no longer meet cargo certification standards.
○ As-Is. Sold with no guarantee of condition, priced accordingly lower.
For a basic storage-to-office hybrid, a security cabin, or any conversion where budget matters more than pristine cosmetics, a Cargo-Worthy used container is often the practical middle ground. It offers meaningful savings over a new unit while still being structurally reliable enough for a fabricator to build on.
How to Choose a Container Conversion Services Company in Dubai
The gap between a good conversion and a problematic one usually comes down to who built it, not what type of container they started with. A few checks up front save a lot of trouble later.
Ask to see completed projects, not just renders. A fabricator with real installed projects across JAFZA, DIP, or Dubai South can point you to units that have been in use for a year or more, which tells you far more about durability than a design mock-up ever will.
Confirm structural engineering credentials for anything beyond a single-container conversion. Stacked or multi-container modular buildings need a qualified structural engineer’s sign-off, and this is not optional for approval purposes in any of Dubai’s jurisdictions.
Look for free-zone-specific experience, not just general UAE experience. A contractor who has actually taken a project through JAFZA’s Trakhees BIM submission process, for example, will move faster and avoid rejected submissions compared to one who has only worked in municipality-governed areas.
Ask about warranty and after-service support. Insulation, AC systems, and electrical fit-outs all need occasional servicing, and a fabricator who offers a defined warranty period and a service contact after handover is signaling that they expect the unit to still be functioning well past the delivery date.
Insist on a transparent, itemized quote. A quote that breaks out the container cost, insulation and HVAC, electrical and plumbing, foundation work, crane hire, and permit fees separately is far easier to compare against another vendor’s quote than a single lump sum, and it is also the clearest sign of a fabricator who is not planning to pad costs with vague line items later.
Watch for red flags before signing anything.
- A quote significantly below every other bid you have received is worth questioning rather than celebrating, since it often means substandard insulation, an undersized AC unit, or a used container that has not been properly inspected.
- Reluctance to provide a written, itemized breakdown is a sign to look elsewhere.
- Refusal to name a structural engineer for a multi-unit project is a sign to look elsewhere as well.
Maintenance and Lifespan of Converted Containers
-
Structural lifespan under normal maintenance.
A well-built and properly maintained container conversion can reasonably last 25 to 30 years, and in some cases considerably longer. The steel corner castings and structural rail frame that carry the container’s load are engineered to be far more durable than the corrugated wall panels. In a well-maintained unit, those load-bearing rails can outlast the wall cladding by decades, meaning the cladding can eventually be replaced without needing to rebuild the entire structure. Corten, or weathering, steel, the material most shipping containers are built from, is specifically designed to develop a stable, protective oxide layer that slows further corrosion, which is part of why containers hold up as well as they do in the first place.
-
What actually shortens lifespan.
Rust is the single biggest threat, and it accelerates wherever moisture sits against bare or damaged steel for extended periods, around door seals, at floor level where water can pool, and at any point where paint has chipped and exposed metal to air and humidity. Dubai’s combination of intense UV exposure and, in coastal areas, salt-laden air makes coating quality and maintenance more important here than in a drier, inland climate.
-
Realistic maintenance intervals.
Seals around doors and windows should be checked at least annually and resealed as soon as cracking or gaps appear. HVAC systems, given the heavier cooling load discussed earlier, benefit from servicing on a schedule closer to every three to four months rather than the annual check that might suffice in a milder climate. A visual rust inspection once or twice a year, particularly after the summer humidity season, catches small problem areas before they spread and require a full repaint.
-
Relocation and repurposing potential.
One advantage a container conversion has over a traditional building is genuine portability. A unit that has finished its useful life on one site, or is simply no longer needed there, can often be relocated to a new plot rather than demolished, which reinforces the sustainability case made earlier in this guide and gives businesses a way to treat the conversion as a movable asset rather than a sunk cost tied to one piece of land.

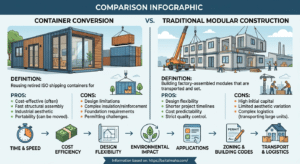

Container Conversion vs Traditional Modular Construction
Both approaches solve the same basic problem: getting usable building space onto a site quickly. The right choice depends on what you are optimizing for.
- Speed. Container conversions win decisively here. Fabrication happens off-site in parallel with permit approval, and installation is typically a single day once the unit arrives. Traditional modular or panelized construction still requires on-site assembly across several days to weeks.
- Cost. Container conversions are generally cheaper for small to mid-sized spaces, particularly single-room offices and cabins, though the gap narrows for large, heavily fitted-out buildings where the structural cost of a steel container stops being a meaningful advantage over a purpose-built modular frame.
- Portability. This is where containers clearly outperform traditional modular buildings. A converted container was engineered from the start to be craned, trucked, and relocated, which is not always true of panelized modular construction designed for a single permanent placement.
- Durability. Both approaches can be built to last decades with proper maintenance, but a container’s steel shell offers stronger resistance to fire, pests, and extreme wind loading than most lightweight modular panel systems. A well-engineered modular building can sometimes offer more design flexibility for very large, multi-story structures where stacking containers becomes structurally impractical.
Frequently Asked Questions
How long does a container conversion take in Dubai?
A basic single-container office or cabin typically takes two to three weeks to fabricate, while a fully fitted conversion with plumbing and custom finishes runs four to six weeks. Multi-container modular buildings usually take eight to twelve weeks once structural engineering and approval timelines are factored in.
Can container offices be moved between sites?
Yes. Converted containers are designed to be craned and transported, which is one of their main advantages over block-and-mortar construction. Relocating a unit still requires re-securing any new-site approvals and reconnecting utilities, but the physical structure itself is built to be moved more than once.
Are converted containers legal for permanent residential use in Dubai?
It depends on the plot’s zoning and the approving authority. Container homes are more commonly approved as temporary or semi-permanent structures on industrial or free zone plots than as permanent residential dwellings on standard municipal residential land, so this needs to be confirmed with Dubai Municipality or the relevant free zone authority before committing to a residential conversion project.
What size containers are used for conversions?
20ft and 40ft standard containers are the most common, with the 40ft high cube increasingly preferred for offices and livable conversions because of its extra internal height. Reefer containers are occasionally repurposed for cold storage or specialist applications.
Do converted containers need Dubai Municipality approval?
In areas governed directly by Dubai Municipality, such as Al Quoz, DIP, and Ras Al Khor, yes, a building permit and Civil Defense sign-off are required. In JAFZA, the equivalent approval runs through Trakhees rather than Dubai Municipality directly, and Dubai South operates its own facilities approval process.
How long do converted shipping containers last?
With proper maintenance, 25 to 30 years is a realistic expectation, and the structural steel frame itself can last considerably longer than that, since the wall cladding tends to wear out well before the load-bearing rails and corner castings do.
What is the difference between a new and used container conversion Services?
A new or one-trip container starts closer to factory condition with minimal wear, which suits long-term or residential conversions best. A used container, if properly graded and inspected, particularly at Cargo-Worthy standard, offers meaningful cost savings for commercial applications like offices and cabins without a significant compromise in structural reliability.
Can multiple containers be joined into one large building?
Yes. Containers can be stacked vertically or connected side by side once the internal walls between them are cut and reinforced, creating a single larger space out of two or more units. This requires structural engineering to manage load transfer and is treated as a building project rather than a simple installation for approval purposes, so it needs a full permit submission in whichever jurisdiction the site falls under.
Do converted containers need ongoing maintenance like a normal building?
Yes, though the maintenance profile is different. Instead of the plumbing and masonry upkeep a traditional building needs, a container conversion mainly needs seal checks, rust inspection, and AC servicing on the schedule outlined earlier in this guide. Skipping this maintenance is the most common reason a conversion falls short of its expected 25 to 30 year lifespan.
