Housing 50, 100, and 500 workers using modular labor accommodation cabins requires scalable layouts, specific container or prefab quantities, and integrated utility modules. Standard ratios allocate roughly 3.5 to 4.5 square meters per worker, pairing multi-tier bunk configurations with centralized sanitation, dining, and management blocks.
If you have searched this topic before landing here, you have probably already seen the basic numbers. What most guides do not tell you is why those numbers exist, how they change once you cross certain worker thresholds, how to calculate them for a headcount that is not a round number, and what the 2026 update to UAE labour accommodation law actually changes for anyone planning a camp right now. This guide covers all of it, camp size by camp size, with the reasoning behind every figure.
Why Labour Accommodation Cabin Planning Isn’t Just Beds Divided by Capacity
It is tempting to treat labour accommodation cabin planning as a simple division problem. Take the worker count, divide by beds per cabin, and order that many units. In practice, that approach produces a camp that fails inspection, creates bottlenecks every morning, or runs out of budget halfway through the project.
Real camp sizing works backwards from four separate constraints that all have to be satisfied at the same time.
- Regulatory minimums. These are the fixed space, occupancy, and facility ratios set by MOHRE and enforced through the Labour Accommodation System.
- Fire and life safety. This covers the block spacing, exit widths, and egress distances that Civil Defence requires before issuing a No Objection Certificate.
- Operational reality. This is how many workers actually need to shower, eat, or use a toilet within the same 45-minute window before a shift starts.
- Utility capacity. This is how much water, power, and sewerage the site can actually deliver, which often becomes the real limiting factor on larger camps long before land size does.
A camp designed only around the minimum space-per-worker rule can pass a paper inspection and still fail in practice. A queue for the shower block at 5:30 am is a welfare problem that regulators increasingly treat as seriously as floor space. Understanding this distinction is what separates a labour accommodation cabin setup that works from one that only technically complies.
The 2026 Update to UAE Labour Accommodation Law: What Changed
Anyone researching this topic using older articles is working from outdated information. In 2026, the UAE Ministry of Human Resources and Emiratisation introduced a significant update to labour accommodation regulation. The update consolidates and expands the previous framework built on Cabinet Resolution No. 13 of 2009 and Ministerial Resolution No. 212 of 2014.
The revised Worker Accommodation Standards Guide brings in requirements that did not exist in the older rulebook. Here is what changed, and why it matters for anyone planning a new labour accommodation cabin camp.
- Minimum 5-kilometre separation from family residential areas. Labour accommodation is now expected to sit close to industrial zones and transport routes instead.
- Free internet access. Operators must provide it so workers can stay in contact with family and access digital government and banking services.
- 24-hour medical clinics, sports facilities, and financial services access. These are now mandatory for any complex housing 1,000 or more workers.
- Dedicated facilities for People of Determination and injured or sick workers. This is called out specifically as a new minimum requirement, alongside multilingual safety and rights information posted at the accommodation.
- Sufficient space for vehicle movement, parking, and bus access. This must be planned into the site so emergency vehicles and Civil Defence teams can reach every block without delay.
- Mandatory registration of accommodation and worker data. Operators must register accommodation details and resident worker information with MOHRE and keep those records current. The ministry can suspend an accommodation’s registration where incorrect data or violations are found.
The wage and headcount trigger for mandatory accommodation provision also remains active under the current guide.
- Employers with 50 or more workers earning at or below the ministry’s wage threshold must provide compliant accommodation, or a housing allowance in its place.
- Local authorities in individual emirates retain the ability to lower that headcount threshold or raise the wage cap for their jurisdiction.
- It is worth checking with the relevant emirate before assuming the federal figure is the only one that applies to a given project.
None of this replaces the baseline space and facility rules covered below. It sits on top of them. A labour accommodation cabin camp built to the old 2014-era checklist alone is no longer fully compliant in 2026.
Baseline Rules for Every Labour Accommodation Cabin Setup
Before splitting this out by worker count, it is worth laying out the rules that do not change whether the camp houses 50 people or 500. These are the non-negotiables that MOHRE inspectors and Civil Defence assessors check first, and they are the same reasoning that shapes everything that follows.
Space per worker.
The regulatory minimum is 3.0 square metres of floor space per worker in a sleeping area. Several current guides and legal advisories reference a range extending to 3.5 or even 4.0 square metres, depending on the accommodation category and emirate. Treat 3.5 square metres as a safer working assumption at the planning stage rather than designing exactly to the legal floor, since it provides a margin of safety against inspection disputes.
Ceiling height and occupancy.
Rooms need a minimum ceiling height of roughly 7 feet, or 2.1 metres. Occupancy is generally capped at 8 to 10 workers per room. Sleeping on the floor, doubling up in a single bunk, or exceeding the room’s rated occupancy are treated as serious violations, not minor paperwork issues.
Sleeping furniture.
Every worker is entitled to an individual bed, a bedside table or equivalent surface, and a lockable wardrobe or locker in their labour accommodation cabin. This is a specific, checked item during inspections, not a general suggestion.
Climate control and ventilation.
Air conditioning and mechanical ventilation are required in every sleeping unit, not only in common areas. UAE summer ambient temperatures regularly exceed 45°C, so standard residential-grade AC units are not considered adequate. High-ambient inverter units rated for continuous operation above 50°C are the practical standard used across the industry.
Shared facilities.
Every camp needs access to ablution blocks, a kitchen or canteen, a laundry point, a first-aid or medical room, and a prayer room. Ablution blocks in this region typically combine toilets, showers, and a dedicated wudu washing area for ritual ablution before prayer. None of these facilities are optional additions once a camp crosses the 50-worker threshold that triggers mandatory accommodation provision.
Registration and approvals.
Two separate government approvals apply in parallel, and both are required before occupancy, not after.
-
- MOHRE registration through the Labour Accommodation System, confirming the facility and its resident worker data meet the ministry’s standards.
- Civil Defence approval, confirming the fire safety plan, suppression systems, detection systems, and emergency egress routes meet the required standard for the accommodation’s size and layout.
Suppliers who work with these rules daily, such as an established labour accommodation cabin supplier in Dubai, can usually flag which of these six baseline items tends to trip up a first-time camp plan before it reaches inspection stage.
Why do these specific rules exist, rather than some other set of numbers? The reasoning behind each one is worth understanding, not just memorising.
- Ventilation and AC requirements exist because heat stress in an unventilated sleeping room during Gulf summer conditions is a genuine, documented health risk, not a comfort issue.
- Occupancy caps of 8 to 10 per room tie directly to fire egress calculations, since evacuating a room beyond that density within a safe time window during an emergency becomes materially harder.
- Space and furniture minimums exist to prevent overcrowding-related disease transmission and give every worker a private, lockable space for personal belongings.
Understanding the logic behind each rule makes it far easier to plan a labour accommodation cabin camp that passes inspection on the first attempt, because the design follows the intent of the regulation, not just its letter.

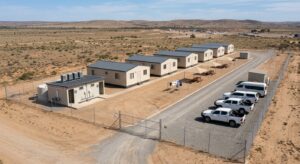

Housing 50 Workers: Full Labour Accommodation Cabin Breakdown
A 50-worker camp sits right at the regulatory trigger point. It is the smallest headcount at which mandatory accommodation provision generally applies under current MOHRE rules. This makes getting the basics right especially important, since it is often a contractor’s first labour accommodation cabin project and first exposure to the full compliance process.
Dormitory Cabins and Sanitation for 50 Workers
- Dormitory cabins: 6 to 8 standard modular units, based on a typical 6-metre by 3-metre cabin fitted with two-tier steel bunks housing 6 to 8 workers per cabin. A single row or simple L-shaped layout is usually sufficient at this scale.
- Sanitation: 4 to 6 combined toilet and shower stalls. A single centralised ablution block is normally enough, provided it sits close enough to the dormitory row that morning queuing does not become a bottleneck before the first shift.
Support Facilities, Approvals, and Timeline for 50 Workers
- Core support facilities: one small kitchen and canteen cabin, which is sometimes combined into a single unit at this scale, one laundry cabin, and a combined first-aid and site management office. Pairing the first-aid and office functions into a single cabin is common practice at 50 workers, since a dedicated standalone medical room is not yet a strict operational necessity, though it remains good practice.
- Prayer facilities: a single small prayer cabin, or a designated prayer corner within a shared block. A dedicated cabin is the more compliant and more commonly deployed option.
- Approvals: MOHRE registration is required once the 50-worker, wage-threshold condition is met. Civil Defence fire safety approval is required regardless of camp size. There is no small-camp exemption from fire safety compliance.
- Plot footprint: roughly 1,000 to 1,500 square metres of usable plot, once fire-lane clearance between blocks, vehicle access, and parking are factored in. This is considerably more than the raw floor-space-per-worker calculation alone would suggest.
- Setup timeline: 2 to 4 weeks from order confirmation to full readiness for MOHRE and Civil Defence inspection, using standard-stock modular units, assuming the site already has basic power and water access.
- Budget consideration: the main cost variables at this scale are panel specification and whether units are rented or purchased. Rock wool panels for fire compliance cost more than basic EPS panels, but are the correct choice for accommodation use. Renting is almost always the more sensible route for projects under 12 months, while purchasing typically becomes the better financial decision for anything approaching 18 months or longer.
For a first labour accommodation cabin project, working from a supplier’s standard labour camp cabin range rather than a fully custom build usually keeps both the budget and the timeline realistic at this scale.
Housing 100 Workers: Full Labour Accommodation Cabin Breakdown

At 100 workers, the camp stops being a simple row of cabins and starts needing genuine layout planning. This is the point where meal-shift bottlenecks, shower queues, and block spacing begin to matter operationally, not just on paper.
Dormitory Cabins and Sanitation for 100 Workers
- Dormitory cabins: 12 to 14 multi-bed units. A double-loaded corridor layout, meaning two rows of cabins facing each other with a shared walkway between them, starts to make more sense than a single row at this scale, both for land efficiency and for keeping utility runs shorter and simpler.
- Sanitation: 10 to 12 toilet and shower stalls, distributed so that no single block serves more than roughly 50 workers. Splitting sanitation into two smaller blocks rather than one large one is generally the better decision, purely to avoid a single point of congestion when an entire shift wakes up within the same 30-minute window.
Support Facilities, Layout, and Timeline for 100 Workers
- Dining and canteen: a larger centralised dining and canteen cabin, or a smaller canteen combined with staggered meal shift scheduling. A standard 12-metre by 3-metre dining cabin seats roughly 30 to 40 workers per sitting, so a 100-worker camp running two staggered sittings can operate comfortably with a single dining cabin of that size, or two smaller ones running in parallel.
- Other support facilities: a dedicated laundry cabin, separate from the kitchen function at this scale, a proper standalone first-aid room, a prayer room sized for meaningful group prayer, and a small administrative site office for camp management and security.
- Layout logic: positioning dormitory blocks so the ablution facilities and dining hall sit roughly equidistant from every dormitory row reduces walking-distance friction across the whole camp. This has a measurable effect on how smoothly a shift change actually runs.
- Approvals: a full Civil Defence safety plan approval is mandatory at this scale, along with the on-site inspections that follow before occupancy is signed off. MOHRE registration and Labour Accommodation System entry remain required in parallel.
- Plot footprint: roughly 2,500 to 3,500 square metres for a well-spaced 100-worker camp, factoring in the wider fire-lane clearances that apply once block count and camp density increase.
- Setup timeline: 4 to 6 weeks from order confirmation to full occupancy readiness, using standard modular stock. This takes longer than the 50-worker scale largely because layout planning and utility distribution take more time to finalise.

Housing 500 Workers: Full Labour Accommodation Cabin Breakdown
At 500 workers, a labour accommodation cabin camp stops functioning like a construction-site amenity and starts functioning like a small residential township, with the master planning, utility infrastructure, and staffing structure to match. This is also the scale at which the newest 2026 MOHRE requirements bite hardest, since several of the enhanced facility obligations are explicitly triggered at or near this size.
Dormitory Cabins and Sanitation for 500 Workers
- Dormitory cabins: 60 to 65 modular rooms, typically organised into multiple distinct residential blocks or zones rather than one continuous run. Splitting the camp into zones, commonly by trade, contractor, or work shift, is standard practice at this scale, both for operational management and because it keeps individual fire-safety zones within a manageable size for evacuation planning.
- Sanitation: more than 50 toilet and shower units, distributed evenly across the residential zones so that each block has its own dedicated ablution facility rather than workers crossing zones to reach one. Combined ablution blocks with an integrated wudu area remain the standard configuration across all zones.
Core Support Facilities at Commercial Scale
- A large commercial kitchen with a dedicated dining hall operating in staggered shifts. A single 12-metre by 3-metre dining cabin is nowhere near sufficient at this scale, so camps typically deploy 4 to 5 dining cabins running in rotation to feed the full workforce across two or three sittings.
- A standalone medical service room with a nurse station, and, depending on project scale and local authority requirements, potentially a full on-site clinic. The Dubai Health Authority mandates on-site medical facilities for large construction sites once workforce numbers cross applicable thresholds, and equivalent OSHAD-SF requirements apply in Abu Dhabi to projects with 500 or more workers specifically.
- A central laundry facility sized for commercial throughput rather than a single small cabin.
- One or more mosque or prayer cabins. A standard 6-metre by 3-metre mosque cabin holds roughly 25 to 30 worshippers per prayer session in two rows. Camps of 500 or more workers typically install two or three separate prayer cabins to avoid queuing across the five daily prayer windows.
- Recreation space, now an explicit expectation under the updated 2026 accommodation standards rather than a nice-to-have addition.
- Security and camp administration blocks, generally staffed around the clock at this scale rather than during office hours only.
Infrastructure, Approvals, and Timeline for 500 Workers
- Utility infrastructure: this is where 500-worker camps genuinely diverge from smaller ones. Water supply shifts from simple tankered delivery, which is workable at 50 to 100 workers, to a decision between mains connection or a much larger tankering and storage schedule. Generator capacity must be sized against simultaneous AC load across 60-plus cabins running through Gulf summer peak demand, not estimated from a smaller camp and scaled up loosely. Sewerage, whether through mains connection or septic and tankering, needs proper engineering calculation rather than rule-of-thumb sizing.
- Emergency egress and master planning: egress route design becomes a formal engineering exercise. Assembly point capacity, route widths, and maximum travel distances from any dormitory to an exit all need to be calculated and submitted as part of the Civil Defence approval package, not estimated on-site after the cabins are already positioned.
- Camp management structure: a camp of this size typically operates with a dedicated site office team, round-the-clock security staffing, and a formal medical rota. Informal management, which can work adequately at 50 workers, does not scale to 500 without creating genuine welfare and safety gaps.
- Plot footprint: roughly 12,000 to 18,000 square metres, depending on zoning approach, block spacing, and how much recreation and vehicle circulation space is built in.
- Setup timeline: 8 to 12 weeks from order confirmation to full occupancy, factoring in master planning, multi-stage Civil Defence approval, and utility infrastructure installation. This is considerably longer than the 2 to 4 weeks achievable at 50-worker scale.
A camp of this size is rarely a simple order-and-deliver process. Most 500-worker projects benefit from involving a labour accommodation cabin supplier in Dubai at the master-planning stage, before block positions are finalised, rather than after the layout is already drawn.
Labour Accommodation Cabin Comparison: 50 vs 100 vs 500 Workers
| Camp Size | Dormitory Cabins | Sanitation Units | Plot Footprint (approx.) | Setup Timeline | Key Facility Additions |
| 50 workers | 6 to 8 | 4 to 6 | 1,000 to 1,500 sqm | 2 to 4 weeks | Combined kitchen/canteen, combined first-aid/office. |
| 100 workers | 12 to 14 | 10 to 12 | 2,500 to 3,500 sqm | 4 to 6 weeks | Standalone laundry, dedicated first-aid room, prayer room. |
| 500 workers | 60 to 65 | 50 or more | 12,000 to 18,000 sqm | 8 to 12 weeks | Commercial kitchen, nurse station, multiple mosque cabins, recreation space, 24/7 security. |
A few patterns are worth pulling out of this table directly.
- Most figures, including dormitory cabins and sanitation units, scale in direct proportion to worker count.
- Plot footprint is the exception. It scales faster than headcount, because larger camps need proportionally more space for fire-lane clearance, block separation, and vehicle circulation. A camp ten times the size of a 50-worker camp typically needs roughly twelve to fifteen times the land, not ten.
- Setup timeline also scales non-linearly, since larger camps carry master-planning and multi-stage approval steps that smaller camps skip entirely.
Anyone comparing quotes against these figures can check the labour accommodation cabin and prefab range to see how standard configurations map against each tier before committing to a layout.
How to Calculate Labour Accommodation Cabin Counts for Any Worker Count
The ratios behind the 50, 100, and 500-worker figures above are not unique to those three numbers. They scale linearly, which means the same formulas work for any headcount a project actually has, whether that is 75, 220, or 340 workers.
- Dormitory cabins needed equals total workers divided by beds per cabin, typically 6 to 8 beds per standard modular unit. For example, a 220-worker camp using 8-bed cabins needs roughly 28 dormitory units, since 220 divided by 8 equals 27.5, rounded up.
- Sanitation units needed equals total workers divided by 8 to 10, since the standard ratio is one toilet or shower stall per 8 to 10 workers. The same 220-worker camp would need approximately 22 to 28 sanitation stalls, depending on which end of the ratio range is used. It is worth erring toward the higher figure once shift patterns are dense, since a camp with a single early shift start time needs more sanitation capacity than one with staggered start times across the same headcount.
- Support cabin scaling follows a clear inflection point. Below roughly 150 to 200 workers, single-purpose support cabins, meaning one kitchen, one laundry, and one first-aid room, are typically sufficient. Above that threshold, support facilities generally need to shift from single cabins to dedicated multi-unit or commercial-grade blocks. This is the same point at which camps typically move from informal management to a formal site office structure as well.
A Practical Worked Example
Take a 150-worker camp as a mid-scale test case.
- Dormitory cabins: 150 divided by 7 average beds per cabin equals approximately 21 to 22 cabins.
- Sanitation units: 150 divided by 9, using the mid-range ratio, equals approximately 16 to 17 stalls.
- Dining capacity: at 30 to 40 seats per dining cabin with two staggered sittings, one to two dining cabins covers the full workforce.
- Prayer cabin: one standard 6-metre by 3-metre mosque cabin, holding 25 to 30 people per session, with staggered prayer timing across departments, is generally sufficient below 200 workers.
This calculation approach turns three fixed reference points into a genuinely reusable planning tool. It works whether the actual project sits neatly at 50, 100, or 500 workers, or somewhere in between.
MOHRE and Civil Defence Requirements Explained
These two approval processes run in parallel, cover different risks, and both have to be satisfied before a labour accommodation cabin camp can be occupied. Understanding what each one actually checks makes the whole process considerably less confusing.
MOHRE Registration and the Labour Accommodation System
- Who needs it. Employers with 50 or more workers earning at or below the ministry’s designated wage threshold are required to provide accommodation meeting MOHRE standards, or a housing allowance in lieu. Local authorities in specific emirates can adjust this headcount or wage threshold within their jurisdiction, so it is worth a direct check against current local rules before assuming the federal figure applies unmodified.
- The registration process. Accommodation must be registered in MOHRE’s Labour Accommodation System, also referred to as ELAS, the Electronic Labour Accommodation System, with accurate resident worker information kept current throughout occupancy. This is not a one-time filing. MOHRE has stated it can suspend an accommodation’s registration file where inaccurate data or standards breaches are identified, and repeated violations resulting in labour disruption can lead to further administrative action.
- What gets inspected. Space per worker, room occupancy, sleeping furniture provision, ventilation and AC function, and ablution facility ratios are all checked. Under the 2026 update, inspectors also check the newer requirements around internet access, medical facility provision at scale, and accessibility for injured or differently-abled workers.
- Renewal. Accommodation registration is not permanent. Periodic re-inspection applies, and any material change to the camp, such as an increase in worker count, a change in block layout, or facility modifications, typically triggers a review of the existing registration rather than being treated as a minor update.
Civil Defence Fire Safety Approval
- The legal basis. Civil Defence authority in the UAE traces back to Federal Law No. 9 of 2006, which establishes the General Directorate of Civil Defence’s power to set, inspect, and enforce fire safety standards nationally. Individual emirates, including Dubai Civil Defence, Abu Dhabi Civil Defence, and their counterparts elsewhere, then issue their own technical circulars on top of that federal base. Specific requirements, such as sprinkler thresholds or alarm zone configuration, can differ slightly between emirates for otherwise similar camps.
- The approval sequence. Civil Defence approval for a labour accommodation cabin camp typically runs through four stages: submission of architectural and fire safety drawings, review and approval of those drawings before construction or installation proceeds, on-site installation of the approved systems, and a final inspection confirming installed systems match the approved drawings before a No Objection Certificate is issued. The drawing package usually covers the site plan, exit routes, fire-rated door specifications, and alarm system layout.
- What is checked at inspection. Fire suppression system function, fire alarm and detection system placement, emergency lighting, sprinkler head positioning where applicable, fire-rated door specification, and clear, unobstructed emergency egress routes matching the approved drawings exactly. As of 2026, Hassantuk smart fire monitoring, a connected alarm monitoring system, has become a mandatory requirement across commercial premises in Dubai, and labour accommodation falls within that scope.
- Why this applies regardless of camp size. There is no small-camp exemption from Civil Defence approval. A 50-worker camp needs the same category of fire safety plan as a 500-worker camp. What changes with scale is the complexity of that plan, not whether one is required at all.
Choosing the Right Labour Accommodation Cabin Type
Cabin choice is not just about bed count. Panel specification and frame type materially affect fire compliance, thermal comfort, and how long a labour accommodation cabin lasts before it needs replacing.
Panel and Frame Specification
- Panel specification. Rock wool sandwich panels offer both strong insulation performance and a genuine fire rating, typically 30 to 120 minutes depending on thickness. These are the correct specification for accommodation cabins where Civil Defence fire compliance is mandatory. Basic EPS, or expanded polystyrene, panels are cheaper but carry no meaningful fire rating and are generally not appropriate for sleeping accommodation, regardless of camp size. This is one of the few areas where cutting cost on specification creates direct regulatory risk, not just a comfort trade-off.
- Frame type. Standard single-storey dormitory cabins use a galvanised light steel frame, which is cost-effective and well-suited to single-storey layouts at any camp scale. Where land is constrained and a camp needs to stack accommodation vertically, a heavier structural steel chassis becomes necessary. Any stacked configuration beyond two storeys typically requires separate structural engineer certification and municipality permit approval before installation.
Scale-Appropriate Cabin Choices
- 50-worker camps generally work well with standard single-storey bunk cabins. These are fast to deploy, straightforward to install, and proportionate to the camp’s complexity.
- 100-worker camps benefit from separating dormitory cabins from dedicated single-purpose support cabins, such as kitchen and laundry, rather than combining functions, since combined-function cabins start to create bottlenecks once daily usage crosses a certain volume.
- 500-worker camps justify purpose-engineered modular blocks built specifically for higher-density, higher-load use, reinforced for the electrical and AC load that commercial-scale kitchens, multiple dining cabins, and dozens of dormitory units create when running simultaneous AC draw during summer peak demand.
For a broader look at how modular cabin types differ across use cases, including the panel and frame specifications suited to each, the full portacabin types guide breaks down site office, accommodation, ablution, and specialised cabin categories in detail. It is also worth browsing the full labour accommodation cabin and prefab range currently available before finalising a specification, since seeing standard configurations side by side often makes it easier to decide what a specific project actually needs.
Labour Accommodation Cabin Cost at Each Scale
Most articles on this topic avoid pricing altogether, which leaves anyone budgeting a camp with no real starting point. The figures below are current 2026 UAE market benchmarks and should be treated as planning ranges rather than fixed quotes. Actual cost depends heavily on panel specification, site location, and whether units are rented or purchased.
Unit-Level Pricing
- A standard 6-metre by 3-metre worker accommodation cabin, fitted with steel bunks and lockers for 6 workers, typically costs AED 22,000 to AED 35,000 to purchase outright, or AED 600 to AED 1,200 per month to rent, usually with a minimum 3-month rental term.
- A plumbed, multi-stall toilet and ablution container block runs AED 35,000 to AED 60,000 to purchase, or AED 700 to AED 1,500 per month to rent.
- Specialised units, such as a portable site clinic, sit higher, typically AED 45,000 to AED 80,000 to buy, given the medical-grade flooring, lighting, and fitout involved.
Cost by Camp Size
Applying those unit costs to the three camp sizes covered above gives a rough order-of-magnitude budget range, before factoring in delivery, installation, utility connection, and ongoing maintenance.
- 50 workers: roughly 7 dormitory cabins, 5 ablution stalls, and core support units put the cabin-purchase total in the broad range of AED 250,000 to AED 400,000, or considerably less on a rental basis for shorter projects.
- 100 workers: with 13 dormitory cabins, 11 ablution stalls, and a larger support facility set, the purchase total typically falls between AED 500,000 and AED 800,000.
- 500 workers: at 60-plus dormitory cabins, 50-plus ablution units, and commercial-grade kitchen, medical, and security facilities, total camp cost moves into the multi-million-dirham range. Master planning, engineering certification, and utility infrastructure often account for as much of the budget as the cabins themselves.
Rent Versus Buy
- Under 12 months: renting is almost always the financially sensible choice. It avoids tying up capital in an asset that outlives the project’s need for it, and the supplier typically handles maintenance and logistics as part of the rental agreement.
- 18 to 24 months or longer: purchasing tends to become the better financial decision, since the total rental cost over that period usually exceeds the purchase price, and a purchased camp remains a redeployable asset once the project ends rather than a sunk cost.
- Somewhere in between: it comes down to whether the camp is likely to be redeployed on a future project or sold off once this one wraps up.
A quick look at current rental and turnkey camp services is generally the fastest way to work out which side of that line a specific project actually falls on.
Hidden Costs to Budget For
A few line items consistently get left out of first-pass camp budgets, and all of them matter more as camp size increases.
- AC servicing. High-ambient inverter units need servicing roughly every 3 months in UAE conditions, at approximately AED 100 to AED 300 per unit per visit. This cost multiplies quickly once a 500-worker camp has well over 100 individual AC units running across dormitory, kitchen, and support cabins.
- Delivery and installation. Transport typically runs AED 500 to AED 1,500 per standard cabin, depending on distance from the manufacturer, with a similar range for installation labour, including crane positioning, structural bolting, and AC commissioning.
- Permit and approval fees. Civil Defence and MOHRE approval processes carry their own administrative fees, separate from the cabin cost itself, and these scale with camp complexity rather than simple headcount.
- Utility connection or generator running cost. Particularly at 500-worker scale, the choice between mains utility connection and generator-and-tanker supply has a material ongoing cost difference that is easy to underestimate at the planning stage.
Building a full cost picture before approaching a supplier, rather than budgeting from unit price alone, is one of the more consistent gaps between camps that stay on budget and camps that don’t.
Seven Signs a Labour Accommodation Cabin Layout Will Fail Inspection
This is a checklist rarely covered elsewhere, drawn from the same operational logic that runs through every section above. Before finalising a site plan, check it against these seven warning signs.
- Dormitory cabins are positioned with no measurable clearance for a fire lane between blocks.
- A single ablution block is expected to serve more than roughly 50 workers.
- The kitchen or generator cabin sits inside a standard EPS-panel structure with no fire rating.
- There is no dedicated route for an ambulance or fire vehicle to reach every block directly.
- The camp has no formal record of MOHRE Labour Accommodation System registration in progress before cabins are ordered.
- Sleeping areas fall below 3.0 square metres of floor space per worker once furniture and walking space are accounted for.
- There is no separate first-aid or medical point once the camp exceeds roughly 100 workers.
Any one of these on its own is fixable. Several of them together on the same site plan are the most common reason a labour accommodation cabin camp gets sent back for rework after its first Civil Defence review.
Common Mistakes When Scaling a Labour Accommodation Cabin Camp
Most camp planning failures do not come from getting the dormitory count wrong. Dormitory cabin counts are the easiest figure to calculate correctly. The mistakes that actually cause problems tend to sit elsewhere.
- Under-provisioning sanitation relative to shift patterns. A camp built exactly to the minimum toilet-to-worker ratio on paper can still fail in practice if every worker on-site starts the same shift at the same time. The ratio needs to account for real usage concentration, not just total headcount averaged across a full day.
- Ignoring fire-lane spacing between blocks. It is a common error to maximise the number of cabins that fit on a plot without leaving adequate clearance between blocks for both fire safety and vehicle access. This mistake often only becomes visible once Civil Defence reviews the site plan, by which point cabins may already be delivered and positioned.
- Underestimating electrical and AC load at scale. A generator sized comfortably for 50 workers’ worth of AC and lighting load does not scale linearly to 500 workers without proper calculation. Simultaneous peak summer AC draw across dozens of cabins is a genuine engineering load calculation, not a rough multiplication.
- Treating approvals as a formality rather than a planning input. MOHRE and Civil Defence requirements work best when they shape the site layout from the first sketch, not when they are checked against a layout that has already been finalised. Submitting drawings for approval before committing to final cabin positioning saves far more time than it costs.
Where to Source a Compliant Labour Accommodation Cabin in the UAE
Once the numbers are worked out, the remaining decision is who actually supplies and installs the camp. A few things are worth checking before placing an order, regardless of which supplier is involved.
- Panel specification on paper, not just in conversation. Ask for the panel type and fire rating in writing, not a verbal assurance, since this is exactly what a Civil Defence inspector will check first.
- Experience with the specific headcount tier. A supplier who regularly configures 50-worker camps is not automatically set up for the master planning a 500-worker complex needs, and it is worth asking directly about past projects at a comparable scale.
- Turnkey capability versus cabin-only supply. Some suppliers deliver cabins only and leave layout, utility planning, and approval submission to the contractor. Others manage the full process end to end. Knowing which one is being quoted avoids a gap in responsibility later.
- Realistic lead times. A quote that promises a 500-worker camp in two weeks is worth double-checking against the realistic 8 to 12 week timeline this guide has already covered.
Suppliers with a documented track record across different camp sizes, such as the completed labour accommodation and site projects available to review from established UAE manufacturers, are generally easier to evaluate against these points than a supplier with no visible project history at all.
Frequently Asked Questions
What is a labour accommodation cabin?
A labour accommodation cabin is a modular, factory-built portable unit used to house construction and industrial workers, typically fitted with bunk beds, lockers, air conditioning, and ventilation to meet UAE labour housing standards.
How many workers can one labour accommodation cabin house?
A standard 6-metre by 3-metre labour accommodation cabin typically houses 6 to 8 workers, depending on the bunk configuration and the minimum 3 square metres of floor space required per person.
What is the minimum space required per worker in a labour accommodation cabin?
The regulatory minimum is 3.0 square metres of floor space per worker, though several current guides reference up to 3.5 or 4.0 square metres depending on accommodation category and emirate.
Is labour accommodation mandatory in the UAE?
Yes. Employers with 50 or more workers earning at or below the ministry’s wage threshold must provide MOHRE-compliant accommodation, or a housing allowance instead.
How much does a labour accommodation cabin cost in the UAE?
A standard worker accommodation cabin typically costs AED 22,000 to AED 35,000 to buy, or AED 600 to AED 1,200 per month to rent, depending on panel specification and fitout.
How many toilets are required per worker in a labour camp?
The standard working ratio is one toilet and shower stall for every 8 to 10 workers, tighter than the general construction-site benchmark, since accommodation covers full-day and overnight use.
How long does it take to set up a labour accommodation cabin camp?
A 50-worker camp typically takes 2 to 4 weeks, a 100-worker camp 4 to 6 weeks, and a 500-worker camp 8 to 12 weeks, from order confirmation to full occupancy readiness.
What is the difference between a labour accommodation cabin and a shipping container?
A labour accommodation cabin is purpose-built with insulated sandwich panel walls for thermal comfort and fire compliance, while a converted shipping container has limited insulation and is generally better suited to storage than sleeping accommodation.
Final Takeaway
The relationship between camp size and facility count is genuinely linear. A 500-worker labour accommodation cabin camp is not a different kind of project from a 50-worker camp. It is the same set of ratios applied at ten times the scale, with the added complexity of master planning, staged approvals, and commercial-grade utility infrastructure that only becomes necessary once headcount crosses roughly 150 to 200 workers.
Getting the early decisions right is what determines whether a camp is ready on schedule or stuck in an approval cycle while workers wait for housing that should already be in place.
- Calculate space and sanitation needs using the actual ratios, not rough estimates.
- Plan sanitation and dining capacity around real shift patterns, not averaged headcount.
- Engage MOHRE and Civil Defence early, before the site layout is finalised, rather than at the compliance-checking stage.
- Match panel specification and cabin type to the camp’s actual scale, not just its budget.
For teams working through camp sizing on an active project. The labour accommodation cabin and prefab building range covers configurations across every scale discussed here, from single dormitory units through to full turnkey camp planning. The team can work through site-specific plot size, utility conditions, and headcount directly. Get in touch with your project details for a proper specification and quote rather than a generic one.
