The most common porta cabin uses in Dubai construction projects are: site offices, labour accommodation, welfare and dining facilities, sanitary and shower blocks, secure material storage, security and guard booths, first aid and medical stations, on-site testing laboratories, meeting and training rooms, and VIP developer marketing suites.
Each of these applications is driven by a specific on-site need – and in most cases, by a UAE regulation that makes the cabin a legal requirement rather than an optional extra.
Dubai’s construction market reached approximately USD 42.75 billion in 2025 and is forecast to exceed USD 52 billion by 2030 (Mordor Intelligence). With 428 new projects launched in 2024 alone and the Dubai Urban Plan 2040 accelerating infrastructure delivery across the emirate, the demand for fast, compliant, and climate-ready site infrastructure has never been higher.
Permanent site structures take too long and cost too much on time-limited projects. Standard imported cabins fail within one UAE summer. What Dubai’s construction sites need are prefabricated porta cabins engineered specifically for the Gulf climate – properly insulated, climate-controlled, and deployable within 24 to 48 hours.
This article covers all ten uses in full, with Dubai-specific regulations, engineering specifications, and practical details that project managers, procurement teams, and site engineers actually need.
Why Porta Cabins Dominate Dubai Construction Sites
Before covering each use, it helps to understand why porta cabins in Dubai have become the default site infrastructure choice rather than an alternative. Four specific realities drive this:
- Extreme heat. Temperatures between June and September regularly exceed 48°C. Uninsulated or poorly specified site structures become unusable within hours of the working day starting.
- Remote site locations. Many Dubai projects – outer Dubailand plots, Jebel Ali industrial zones, desert infrastructure corridors – sit far from mains sewage, water supply, and fibre connectivity. Porta cabins can be configured to operate fully off-grid.
- Regulatory obligations. Dubai Municipality and MoHRE mandate specific welfare, safety, and accommodation facilities for all construction sites above set worker thresholds. These are inspected, not suggested.
- Programme pressure. Tier 1 developers like Emaar, Nakheel, ALDAR, DEWA, and RTA operate on tight construction programmes where delays carry financial penalties. A porta cabin can be craned into position and operational within 48 hours. A permanent structure cannot.
The result: on any serious Dubai construction site, porta cabins do not just support the project – they make the project function.
Site Office Porta Cabins in Dubai – The Project Command Centre
A porta cabin site office in Dubai is a fully air-conditioned, data-connected workspace for project managers, engineers, consultants, and administrative staff. It can be craned into position and made operational within 24 to 48 hours – without a single brick of permanent construction.
Dubai Municipality requires that construction sites of a certain scale maintain a dedicated site office as a condition of permit approval and ongoing compliance inspections. That office must function as a real, productive workspace – not just a place to sit.
What a Dubai Site Office Cabin Must Accommodate
A properly specified site office cabin in Dubai needs to house all of the following:
| Zone | Purpose |
| Project management space | Large enough for engineering drawings, with a dedicated plan chest or drawing table |
| Consultant separation | A partitioned or private area for the engineer’s representative, away from the contractor’s floor |
| HSE officer station | A dedicated desk with CCTV monitoring feeds, safety records, and direct communication to the site entrance |
| Administrative support area | For document controllers, procurement coordinators, and site administrators |
| Visitor reception point | Where municipality inspectors, client representatives, and sub-contractor managers are received separately from the working office |
Why Double-Storey Configurations Are Standard on Large Dubai Projects
On larger Dubai sites, a single unit is rarely sufficient. A double-storey linked configuration – two or three ground-floor units with one or two units above, connected by external steel staircases – is common on Tier 1 contractor sites.
- Upper floor: Senior project staff, project manager’s private office, HSE officer station.
- Ground floor: Open-plan coordination space, drawing area, administrative desks, visitor reception zone.

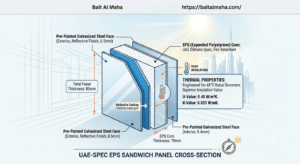

The Climate Specification That Separates UAE Cabins From Standard Imports
A standard porta cabin from a European or Asian catalogue fails in a Dubai summer. The correct engineering specification for a portable cabin in Dubai is:
| Component | Standard Market | UAE-Built Requirement |
| Panel insulation | 40mm EPS | 50–75mm EPS sandwich panel |
| Roofing finish | Standard galvanised steel | Reflective cool-roof coating |
| Window frames | Standard aluminium | Thermal-break aluminium profiles |
| Structural frame | Painted mild steel | Hot-dip galvanised steel |
| AC sizing (3m × 6m cabin) | 1-tonne split unit | Minimum 1.5-tonne split unit |
Internal Fitout for a Fully Functional Dubai Site Office
Beyond the shell, a properly fitted office cabin must include:
- Fibre data points at each workstation.
- A rack space allocation for CCTV equipment and network switches.
- Generator-rated power sockets for backup during utility interruptions.
- A fireproof document cabinet for permit drawings and official correspondence.
- Partition walls separating the project manager’s private area from the general open-plan space.
Explore our full range of site office porta cabins designed and built for Dubai’s climate and project requirements.
Labour Accommodation Cabins – Complying With UAE MoHRE Standards
Porta cabin labour accommodation in Dubai is governed by Ministerial Resolution No. 44 of 2022 on Occupational Health and Safety and Labour Accommodation. This regulation mandates that companies employing 50 or more workers earning AED 1,500 or less per month must provide free accommodation that meets defined health, safety, and welfare standards.
Non-compliance is expensive. MoHRE inspectors conduct unannounced welfare audits on construction sites across Dubai. Penalties include:
- Fines per non-compliant worker.
- Company blacklisting from government tenders.
- Suspension of business activities.
By the end of 2023, MoHRE reported a 1,000% increase in compliance among companies registered in the Labour Accommodation System compared to February 2022 – reflecting exactly how seriously the ministry enforces these obligations.
What the Law Says Every Worker Must Have
Under Cabinet Resolution No. 13 of 2009 and Ministerial Decree No. 212 of 2014, every worker’s accommodation must provide:
- A dedicated bed space with a minimum clearance of 36 inches from all sides.
- A lockable personal cupboard of at least 2 metres in height.
- Full air conditioning and mechanical ventilation.
- A minimum of 3 square metres of personal floor area per worker.
- Natural light, clearly marked emergency exits, smoke detectors, and fire extinguishers.
Two rules that frequently catch contractors off guard:
- Three-bunk beds are explicitly prohibited under UAE regulations.
- Cooking equipment of any kind is not permitted inside bedrooms.
The Three Accommodation Tiers on a Dubai Construction Site
Accommodation on a large Dubai project is rarely uniform. Three distinct tiers typically operate on the same site:
- General labourers – shared bunk-room setups of 6 to 10 beds per room, communal bathrooms, and shared locker facilities.
- Skilled tradespeople and plant operators – smaller shared rooms of 2 to 4 occupants, improved ventilation, and more individual storage space.
- Engineers, supervisors, and technical staff – en-suite units with individual or two-person rooms, a private bathroom, and a work desk.
The structural shell of a labour accommodation cabin remains the same across all three tiers. Only the internal fit-out configuration changes – making it straightforward to order the correct specification for each workforce segment from one manufacturer.
A Compliant Dubai Labour Camp Is an Ecosystem, Not Just Cabins
An accommodation cabin on a Dubai mega-site never stands alone. A fully compliant camp is a coordinated infrastructure cluster that includes:
- A dedicated mosque or prayer room cabin.
- A laundry room with washing machines, drying racks, and an ironing station.
- A canteen and dining facility (detailed in Use 3).
- A recreation room with seating, television, and phone charging stations.
- Sanitary and shower blocks at the required provision ratios (detailed in Use 4).
- A first aid station positioned centrally within the camp (detailed in Use 7).
Sourcing all of these units from a single prefab cabin manufacturer – with consistent panel specifications and coordinated delivery – saves substantial mobilisation time and avoids the quality gaps that come from piecing a camp together from multiple suppliers.

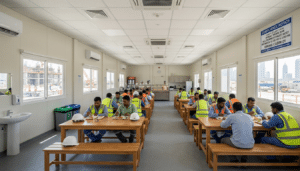

Welfare and Dining Porta Cabins – A Legal Requirement, Not a Goodwill Gesture
Dubai’s midday work ban prohibits all outdoor work under direct sunlight between 12:30 PM and 3:00 PM, from 15 June to 15 September every year. Enforced under Ministerial Resolution No. 44 of 2022, this regulation requires every employer to provide a shaded, ventilated rest area for all outdoor workers during the prohibited hours.
The penalties for non-compliance are serious:
| Violation | Penalty |
| Worker found outdoors during ban hours | AED 5,000 fine per worker |
| Multiple offences at the same site | Total fines up to AED 50,000 |
| Repeated non-compliance | Escalated enforcement and site shutdown risk |
A welfare porta cabin is not optional welfare provision. It is a legal operating condition for any construction site running through a UAE summer.
What a Compliant Canteen Cabin Requires Inside
A kitchen and dining cabin that passes a Dubai Municipality welfare inspection must have all of the following:
- Wall cladding – FRP (fibre-reinforced plastic) or stainless steel panels. Food-safe, easy to disinfect, and resistant to the moisture and mould that builds in a kitchen environment.
- Flooring – non-porous, non-slip vinyl or epoxy coating. Standard ceramic tiles are not acceptable in kitchen preparation zones because grout lines trap organic material.
- Ventilation – commercial-grade kitchen exhaust fans. Steam, cooking odours, and food preparation heat require a powered exhaust system – a split AC unit alone is not sufficient.
- Waste management – sealed, lidded bins, documented drainage connections, and a pest control log available for inspection.
- Seating capacity – sufficient tables and benches for one full shift simultaneously, so workers are never required to eat outdoors during a break period.
Scaling the Dining Setup for Sites With 300+ Workers
On large projects, a single canteen cabin is not enough. The standard approach is to daisy-chain two to four modular units side-by-side – joined with internal openings – creating a continuous dining hall that allows:
- Shift-based meal service without outdoor queuing.
- Separate food preparation and serving zones within the connected cluster.
- Future extension by simply adding another unit without disrupting the existing setup.

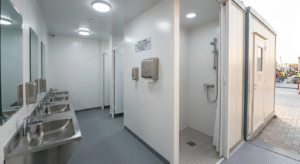

Sanitary and Shower Block Porta Cabins – Ratios, Compliance, and the Desert Drainage Problem
Dubai Municipality specifies minimum sanitary facility ratios for all active construction sites:
Minimum 1 toilet unit per 25 workers Minimum 1 shower unit per 15 workers
For a site crew of 200, that means a minimum of 8 toilets and approximately 13 shower points – a scale that makes purpose-built prefabricated sanitary blocks the only practical compliant solution. These units arrive pre-plumbed and pre-wired, ready for connection to mains supply or a self-contained tank system.
What a Sanitary Block Must Have to Pass Inspection
A compliant toilet cabin on a Dubai construction site must include all of the following:
- Anti-bacterial wall surfaces – FRP panels or fully grouted tiles that can be repeatedly disinfected without surface degradation.
- Forced exhaust ventilation – a powered exhaust fan, not passive louvres. Required to maintain air quality in UAE summer conditions.
- Non-slip floor finishes – laid with a drainage gradient that prevents standing water between cleaning cycles.
- Stainless steel fittings – taps, shower heads, and cubicle hooks. Chrome-plated fixtures corrode within months in a humid shower environment.
- Adequate interior lighting – inside each shower cubicle and throughout the common changing area.
- A cleaning schedule card – signed at each visit and available to show inspectors on request.
The Desert Wastewater Problem That Most Articles Miss
Many Dubai construction sites – outer Dubailand plots, desert corridors along Emirates Road, and Jebel Ali industrial zones – have no mains sewage connection. A standard sanitary cabin relying on gravity drainage to a civil sewer is non-functional on these sites.
There are two compliant solutions:
- Integrated holding tanks – sealed tanks beneath the unit, pumped out by a licensed tanker on a scheduled basis. Suitable for smaller worker counts and shorter project durations.
- On-site sewage treatment units – for larger camps, a dedicated prefabricated treatment plant connects to the sanitary block cluster and processes greywater and blackwater to a compliant disposal or irrigation standard, eliminating repeated tanker logistics.
Material Storage Porta Cabins – Protecting Inventory From Dubai’s Desert Conditions
A secure storage cabin in Dubai protects tools, paints, polymer materials, precision instruments, and raw stock from four specific threats that the UAE desert environment creates every day:
| Threat | What It Does to Unprotected Materials |
| Sand ingress | Abrasive desert dust enters through frame gaps – damages tool mechanisms, clogs pneumatic fittings, contaminates paints, and scratches optical lenses |
| UV degradation | HDPE piping, conduit, rubber seals, and cable sheathing degrade within weeks under direct UAE summer sunlight – materials become brittle before reaching the point of installation |
| Thermal damage | An uninsulated steel container in direct Dubai sun exceeds 65°C internally – precision instruments experience thermal cycling that loosens assemblies and breaks down lubricants |
| Humidity damage | Dubai’s winter humidity events cause condensation damage on heat-stressed materials stored without climate control |
Three Types of Storage Cabin – and Why They Are Not Interchangeable
Most articles treat all storage cabins as one category. On a Dubai construction site, there are three distinct types, each requiring different specifications:
- General Tool and Equipment Stores
The standard insulated unit for hand tools, power tools, safety equipment, and consumables.
- Multi-point locking bars or shrouded padlock systems (a standard padlock hasp is inadequate on a Dubai project site).
- Internal shelving and tool pegboards rated for the stored equipment weight.
- Earthed power points for battery charger stations.
- A ventilation window for air circulation during non-working hours.
- Flammable Materials Storage Cabins
Fire-rated units for paints, thinners, adhesives, and LPG cylinders. Required specifications:
- Louvred ventilation panels at both low and high levels to prevent vapour accumulation.
- Fire-rated EPS or PIR sandwich panel construction – not standard polystyrene.
- External-only door handles – cannot be accidentally locked from the inside.
- Positioned at least 5 metres from any occupied cabin or heat source.
- FM200 suppression-readiness on Tier 1 government contracts where specified.
- Chemical Storage Cabins
For admixtures, waterproofing compounds, acids, and other regulated substances:
- A raised floor sill or built-in secondary containment bund to contain spills.
- Chemical-resistant internal wall and floor liners.
- MSDS (Material Safety Data Sheet) rack positioned inside the door.
- A documented inventory reconciliation system.
- Signage compliant with UAE Civil Defence hazardous substance labelling requirements.

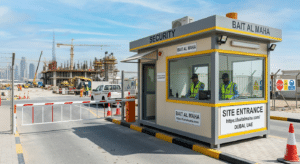

Security and Guard Porta Cabins in Dubai – Access Control, Not Just Shade
A security cabin on a Dubai construction site is not simply a place for a guard to shelter from the sun. On major projects – Downtown high-rise towers, Palm Jumeirah villa clusters, DEWA infrastructure contracts, RTA road schemes – a security cabin is an integrated access-control command post.
What a modern Dubai site security cabin must house:
- Biometric access scanning terminals (Emirates ID-linked turnstile systems are standard on government contracts).
- CCTV monitoring screens covering four to sixteen simultaneous camera feeds.
- A gate barrier control panel connected to vehicle entry points.
- A vehicle arrival and departure log terminal.
- Radio communication equipment linked to the site office and Dubai Police response protocols.
A 1.2m × 1.2m fibreglass kiosk cannot house any of this equipment properly. A correctly specified security cabin – 3m × 2.4m or 4m × 2.4m – provides the equipment rack space, a monitoring workstation, cable management infrastructure, and an adjacent toilet for guards working 12-hour shifts.
Guard Comfort Is a Security Operational Issue
A security guard on a 12-hour shift in a Dubai July needs a properly air-conditioned space to maintain professional alertness throughout. The link between an inadequate cabin and a security failure is direct:
- Fatigue from heat stress reduces vigilance – increasing the risk of workers entering without documentation checks.
- Physical discomfort shortens the time a guard actively monitors CCTV feeds.
- No toilet access forces the guard to leave the post unattended – the most common cause of uncontrolled site entry events on Dubai projects.
Guard cabin sizes available range from:
- 1.2m × 1.2m kiosks for low-traffic, single-entry points.
- 3m × 2.4m guard rooms for standard site main gates with biometric equipment.
- 4m × 2.4m fully equipped guard rooms with attached toilet – for Tier 1 government contract sites.
All configurations are built with the same EPS sandwich panel construction used in site offices – making them a security infrastructure investment, not a basic welfare provision.

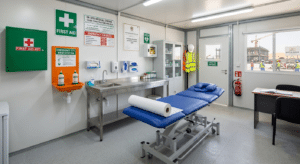

First Aid and Medical Station Porta Cabins – A Statutory Requirement on Every Dubai Site
UAE Federal Law No. 8 of 1980, updated by Federal Decree-Law No. 33 of 2021, and the OSHAD System Framework – applied by Dubai regulators across all Tier 1 contracts – mandate on-site first aid facilities for construction sites above defined worker thresholds. A prefabricated first aid cabin is the fastest and most practical route to compliance on any project of scale.
Why Dubai’s Heat Makes First Aid Proximity a Life-Safety Decision
Between June and September, Dubai afternoon temperatures regularly exceed 48°C. Heat exhaustion can progress to heat stroke within minutes if an affected worker is not moved to a cool environment and given fluids immediately. Every minute of delay after symptoms appear increases the severity of the outcome.
The positioning of the first aid cabin matters clinically:
- A centrally placed cabin means an affected worker reaches care in 2 to 3 minutes.
- A cabin at the site boundary means a worker in early heat stroke is walked across an exposed site in 48°C heat – compounding the emergency rather than resolving it.
Minimum Contents of a Compliant Dubai Site First Aid Cabin
A compliant medical cabin must contain all of the following:
- Clinical-grade vinyl flooring – seamless, easy to disinfect, and chemical-resistant.
- Stainless steel worktops and a dedicated hand-wash basin with hot and cold water.
- An adjustable treatment couch with a paper roll dispenser.
- A wall-mounted eye-wash station with sealed sterile solution.
- A lockable medicines cabinet with a controlled substances inventory log.
- An emergency oxygen cylinder with a demand valve and adult face mask.
- A dedicated, cross-ventilated AC system – first aid rooms require consistent cooling, not shared AC with an adjacent cabin.
- Clearly labelled emergency exits and an evacuation chart displayed at eye level.
- A dedicated communication line connected to Rashid Hospital or Dubai Hospital – the primary trauma reception facilities for Dubai construction casualty events.
On-Site Testing Laboratory Porta Cabins – The Most Financially Valuable Cabin on Site
On any Dubai Tier 1 construction project – Emaar communities, Nakheel waterfront schemes, ALDAR residential developments, or DEWA and RTA infrastructure contracts – an on-site concrete cube testing laboratory is a contractual requirement, not a convenience. The engineer of record, the project manager, and the client’s quality representative all need QA data on fresh concrete within defined curing windows. Transporting samples to an off-site laboratory every time is both slow and expensive.
This is one of the least-discussed porta cabin uses in Dubai construction, yet on high-volume projects with daily concrete pours, a laboratory unit delivers the clearest and most measurable financial return of any cabin type on site.
Technical Specifications That Most Suppliers Never Discuss
An on-site testing lab is not a standard office with a workbench added. It requires four specific engineering decisions at the design stage:
- Temperature Stability for Concrete Curing
- Fresh cube specimens require a curing environment maintained between 20°C and 25°C, per BS EN 12390-2.
- The AC unit must be thermostatically controlled to hold this range consistently – not simply “cool the room.”
- Door seals and insulation grade directly affect the ability to maintain this stability during busy pour days.
- Floor Load Rating for Heavy Test Equipment
- A concrete compression testing machine weighs between 500 and 2,000 kg depending on capacity.
- The cabin floor must be rated for this point loading without deflection.
- The specific equipment footprint and loading position must be confirmed with the manufacturer at the design stage – not after delivery.
- Vibration Isolation Through Careful Positioning
- Slump flow apparatus, penetration resistance testers, and concrete thermometers are precision instruments.
- Vibration from adjacent generators, compactors, and piling rigs degrades measurement accuracy.
- Lab cabin placement must account for proximity to vibration sources during site mobilisation planning.
- Specialist Interior Fitout
- Chemical-resistant epoxy resin benchtops.
- A DI (deionised) water supply point for equipment cleaning and calibration.
- A dedicated cube mould storage rack, organised by pour date.
- A 15 to 20-amp dedicated circuit for the compression testing machine.
- A ventilated storage cabinet for chemical test reagents.
The Financial Case for an On-Site Lab
Transporting concrete cube samples to an approved off-site lab adds 24 to 48 hours to the QA cycle on every pour. If early results flag a mix compliance issue, the concrete placed in that window may need to be investigated, cored, or removed – a cost that runs to hundreds of thousands of dirhams on a large structural element.
An on-site lab:
- Delivers early-age strength data within the curing window.
- Allows the team to act before the problem compounds further pours.
- Eliminates the logistical cost of daily sample transport across Dubai’s road network.
- Typically recovers its full cabin cost within the first 2 to 3 months of a 12-month daily-pour programme.

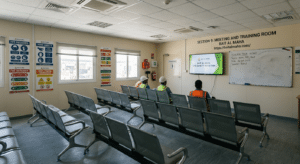

Meeting and Training Room Porta Cabins – Safety Culture Made Physical
A dedicated training cabin on a Dubai construction site is where daily toolbox talks happen, new-worker safety inductions are delivered, HSE reviews are conducted, and emergency drill briefings are run. In Dubai’s contractor ecosystem, this is not optional infrastructure – it is the visible evidence of a mature safety programme that Dubai Municipality inspectors and client safety representatives look for directly.
The difference between briefing workers in the open air – standing in the sun, distracted, partially hearing the speaker – and a dedicated, air-conditioned training cabin is measurable in HSE incident statistics and auditable in inspection records.
The Multilingual Reality of Dubai Construction Sites
Dubai construction sites are among the most linguistically diverse working environments in the world. A typical large project crew communicates in English, Arabic, Hindi, Tagalog, Bengali, Nepali, and Sinhala. A training cabin that accounts for this reality is fitted with:
- Safety poster boards in English, Arabic, Hindi, and Tagalog – the four principal working languages across UAE construction sites.
- A fire evacuation route chart in at least two languages, positioned at eye level near the exit.
- A projector or large wall-mounted television for video-based induction content – visual formats communicate across language barriers far more effectively than text-heavy slide decks.
- Multilingual emergency contact cards posted adjacent to the cabin’s communication point.
This level of preparation signals to a municipality inspector that the contractor takes its duty of care seriously. More importantly, workers who fully understand their safety briefing create measurably fewer incidents.
Recommended Interior Fitout for a Dubai Training Cabin
- Folding training tables and stackable chairs – reconfigurable from a toolbox talk layout (rows) to a team coordination layout (central table) without a separate furniture set.
- A wall-mounted writable surface – whiteboard or writable paint – for daily planning and ad hoc sketching during briefings.
- USB and standard power charging stations at the wall – increasingly required as workers register attendance via smartphone apps on government-linked Dubai projects.
- A fire evacuation map mounted at door height, with the muster point in colour that needs no translation.
- Twin-cabin configuration with an internal connecting door for sites running parallel induction groups simultaneously.
VIP Marketing Suite Porta Cabins – Where Dubai’s Real Estate Market Meets On-Site Experience
In Dubai’s off-plan property market, a VIP porta cabin marketing suite allows major developers – Emaar, DAMAC, Sobha, Nakheel – to host investor presentations directly on the development plot, often before a single structural column has been cast.
Off-plan transactions accounted for 63% of all Dubai property sales in 2024, up from 54% in 2023 (Engel & Völkers Middle East). With 428 new projects launched in 2024 alone, in a market where buyers commit hundreds of thousands to millions of dirhams to a property that does not yet exist, the quality of the on-site sales experience directly drives reservation rates.
A generic downtown showroom tells a buyer about the project. A branded, premium porta cabin on the actual plot – where the buyer can stand on the ground, see the site, and picture the building – answers the question every off-plan buyer carries into the conversation:
“Is this real? Can I trust this?”
Why On-Site VIP Suites Consistently Outperform Showrooms
Standing on the actual ground where a future apartment will rise, inside a cabin that already looks and feels premium, with a scale model of the development positioned in front of you – that is a fundamentally different sales conversation. A well-executed VIP cabin at a project launch weekend regularly generates tens of millions of dirhams in signed reservations that a showroom visit would not have produced.
Interior Fitout for a Developer-Grade Marketing Suite
A developer VIP cabin is a fundamentally different product from a standard porta cabin and must be specified as such from the manufacturing stage:
- Flooring – large-format porcelain tiles (600mm × 600mm or larger) or premium luxury vinyl plank. Nothing that reads as temporary.
- Ceiling – gypsum board false ceiling with recessed LED lighting on a dimmer circuit.
- Reception area – a branded reception counter, fresh floral arrangement, and low-level background music system.
- Sales floor – a scale model display platform, large-format architectural renderings on the walls, and private meeting pods with glass partitions for one-to-one financial discussions with buyers.
- Exterior cladding – branded ACP (aluminium composite panel) cladding in the developer’s brand colours – the same material used on premium commercial building façades, applied to the cabin exterior.
- Climate control – ceiling cassette AC units rather than wall-mounted splits. This single detail most clearly distinguishes a developer-grade VIP fitout from a standard cabin interior.
Three Lifecycle Uses That Justify the Capital Investment
A well-built developer VIP cabin does not go to a rental yard after the launch phase. It typically follows one of these three paths:
- Relocation as the permanent site office for the project’s construction phase once sales are complete.
- Conversion to a show apartment or handover presentation suite during the project’s completion phase.
- Refurbishment and redeployment to the next project launch – with updated cladding, branding, and interior finishes.
A purchase cost spread across two or three project uses, each generating direct commercial value, produces strong acquisition economics for any developer managing an active project pipeline.
How Dubai’s Climate Shapes Every Porta Cabin Specification
One point underpins every section above: porta cabins built for Dubai are a different engineering product from those built for temperate-climate markets. The baseline specifications that every UAE-built porta cabin must meet are:
| Feature | Why It Matters in the UAE |
| 50–75mm EPS sandwich panels | Maintains internal temperatures below 24°C when external heat exceeds 48°C |
| Reflective cool-roof coating | Significantly reduces solar heat gain on the roof surface throughout summer |
| Thermal-break aluminium windows | Prevents heat conduction from the hot exterior frame into the interior workspace |
| Hot-dip galvanised steel frame | Resists UAE coastal humidity and desert temperature cycling without accelerated corrosion |
| Reinforced roof profiles | Rated for Gulf dust storm (shamal) wind and sand load pressure on flat horizontal roofs |
| AC units on shaded elevations | A split unit facing direct sun operates at significantly higher energy cost and lower efficiency |
These are not premium upgrades. They are the engineering baseline for a prefabricated portable cabin in the UAE that will remain functional and structurally sound across a project lifecycle of 12 to 36 months.
Buy or Rent a Porta Cabin in Dubai – A Practical Decision Guide
Porta cabin rental in Dubai typically ranges from AED 500 to AED 5,000 per month depending on size, specification, and duration (industry range). Whether renting or buying makes better financial sense depends on four variables: project duration, unit count, relocation needs, and future project pipeline.
When Renting a Porta Cabin in Dubai Makes More Sense
- Project duration of 12 months or less.
- Small unit count – fewer than 5 to 10 cabins required.
- Site location changes as the project progresses (infrastructure projects moving along road or utility corridors).
- The project is a one-off with no anticipated repeat configuration requirement.
When Buying a Porta Cabin in Dubai Makes More Sense
- Project duration of 18 months or more.
- Large unit counts – 20 or more units for a full camp configuration.
- Multiple projects in the pipeline where the same units can be refurbished and redeployed between projects.
- Developer-grade fitout requirements where the capital cost is justified by the commercial return across multiple uses.
For a project-specific recommendation on whether to rent or purchase, the right answer depends on your exact site timeline, unit count, and whether future projects are already in planning.
Frequently Asked Questions
What is a porta cabin used for on a construction site?
A porta cabin on a Dubai construction site is used for ten core purposes: site offices, worker accommodation, welfare and dining facilities, sanitary blocks, material storage, security guard posts, first aid stations, concrete testing laboratories, training and meeting rooms, and VIP marketing suites. Each use meets a specific operational or regulatory requirement under Dubai Municipality, MoHRE, or UAE Federal Law.
What is the price of a porta cabin in Dubai?
Porta cabin prices in Dubai vary by size, specification, and whether you are renting or buying.
- Rental: AED 500 to AED 5,000 per month (industry range, depending on size and spec).
- Purchase: From approximately AED 8,000 for a basic security kiosk to AED 100,000 or more for a fully fitted site office or developer marketing suite.
Request a project-specific quote for an accurate price based on your exact requirements.
How long does it take to install a porta cabin in Dubai?
- Single cabin: Craned into position and fully operational within 24 to 48 hours of arriving on-site.
- Full camp configuration (20–50 units): Typically 3 to 7 days, depending on civil foundation work required and the complexity of utility connections.
Are porta cabins in Dubai suitable for extreme heat?
Yes – when properly specified. UAE-built porta cabins use 50–75mm EPS sandwich panels, reflective roofing, thermal-break aluminium windows, and correctly sized split AC systems to maintain interior temperatures below 24°C even when external temperatures exceed 48°C. Generic imported units without these specifications are not suitable for a Dubai summer.
What are the UAE rules for worker accommodation porta cabins?
Under Ministerial Resolution No. 44 of 2022, companies with 50 or more workers must provide compliant, free accommodation. Under Cabinet Resolution No. 13 of 2009, every worker must receive:
- A minimum of 3 square metres of personal floor space.
- A lockable cupboard of at least 2 metres in height.
- Full air conditioning and mechanical ventilation.
- Natural light, fire safety equipment, and clearly marked emergency exits.
MoHRE conducts unannounced inspections and can fine, blacklist, or suspend non-compliant employers.
Can porta cabins be customised with company branding in Dubai?
Yes. Porta cabins can be fitted with:
- Branded ACP panel cladding in custom RAL colours.
- Gypsum ceilings and recessed LED lighting.
- Premium flooring – porcelain tiles or luxury vinyl plank.
- Branded reception counters and full showroom interiors.
Developer VIP marketing suites and contractor consultant cabins are regularly built to this specification across Dubai’s major developments. View our services page for ACP and custom fitout options.
Which porta cabin is best for a construction site in Dubai?
The best portable cabin for a Dubai construction site depends entirely on the specific use:
| Use | Specification Priority |
| Site office | Insulated, data-connected, partitioned – with CCTV rack space |
| Labour accommodation | MoHRE-compliant bunk or en-suite layout – with ventilation and fire safety |
| First aid station | Clinical vinyl flooring, treatment couch, oxygen, AC |
| Testing lab | Temperature-stable, heavy floor-load rated, epoxy benchtops |
| Security cabin | Equipment rack space, ergonomic counter, attached toilet |
For any use case, the cabin must meet UAE climate specifications – 50–75mm EPS panels, reflective roofing, and correctly sized AC. View the full product range to identify the right configuration for your site.
Looking for porta cabins for a Dubai, Sharjah, Abu Dhabi, or Northern Emirates project? Get in touch with our team for a site-specific recommendation, or browse our completed projects to see the full range of cabin configurations we have delivered across the UAE.
