Tag: DubaiConstruction

  • Labour Camp Cabin Supplier in Dubai: Setup, Rules & Costs

    Labour Camp Cabin Supplier in Dubai: Setup, Rules & Costs

    A trusted labour camp cabin supplier in Dubai provides MOHRE-compliant, heat-engineered prefabricated portacabins starting from AED 8,000 for a single sleeping unit and rising to AED 600,000+ for a fully operational 100-worker turnkey camp. Monthly costs run AED 500 to AED 1,500 per worker. Every cabin must meet a minimum of 3 sq.m of sleeping space per worker, mandatory air conditioning, fire safety systems, and registered sanitation under MOHRE Ministerial Resolution No. 44 of 2022. Setup takes 1 to 6 weeks depending on camp size. This guide covers every step – rules, costs, setup, and supplier selection.

    Why Finding the Right Labour Camp Cabin Supplier in Dubai Matters More Than You Think

    Your company wins a major construction tender in Dubai. Contracts are signed on a Thursday. By Sunday morning, the question lands on the project manager’s desk that nobody properly planned for: “Where do we legally house 300 workers before the first load of rebar arrives on site?”

    This scenario plays out across Dubai every single week – and it catches even experienced contractors off guard. Unlike other GCC markets where temporary worker accommodation is a relatively simple procurement step, finding the right labour camp cabin supplier in Dubai means navigating a three-layer compliance structure that carries real financial penalties if you get it wrong.

    Those three compliance layers are:

    • MOHRE – the Ministry of Human Resources and Emiratisation, setting federal worker welfare and accommodation standards across the UAE.
    • Dubai Municipality – enforcing structural safety, building permits, fire compliance, electrical standards, and sewage regulations at the emirate level.
    • Free zone authorities – JAFZA, Trakhees, or TECOM, each adding project-specific approval requirements on top of both MOHRE and DM.

    Layer in Dubai’s extreme summer climate – outdoor temperatures regularly exceeding 48°C between June and September – and the full picture becomes clear. A labour camp cabin in Dubai is not a metal box. It is a thermally managed, legally registered, government-inspected structure that must pass multi-authority scrutiny while keeping your workforce healthy, productive, and legally housed.

    What this guide covers:

    • What a labour camp cabin actually is – and the three distinct product types available in Dubai.
    • Who needs one and how to make the buy-versus-rent decision correctly.
    • Complete MOHRE, Dubai Municipality, and free zone compliance rules explained in full.
    • Engineering and climate specifications every Dubai cabin must physically meet.
    • A step-by-step setup process from site survey to MOHRE inspection sign-off.
    • Real 2025–2026 cost tables – purchase prices, rental rates, and the hidden costs most projects miss.
    • Zone-by-zone location guide covering Sonapur, DIP, Jebel Ali, Al Quoz, and Ras Al Khor.
    • The eight costliest mistakes Dubai contractors make – and how to avoid every one of them.
    • The 2025–2030 trend shift already reshaping the Dubai prefab accommodation market.

    What Is a Labour Camp Cabin? Three Types Every Dubai Contractor Should Know

    A labour camp cabin in Dubai is a prefabricated, modular accommodation unit manufactured off-site and installed on a designated plot to house construction, industrial, or logistics workers. These units are built with galvanized or mild steel frames and insulated sandwich panels, connected to DEWA power, municipal water, and sewage on-site, then configured into camp layouts covering sleeping quarters, bathroom blocks, kitchens, dining halls, and support facilities.

    The Dubai market offers three distinct product types. Understanding which one fits your project is a decision that must happen before you contact a single portacabin supplier in Dubai.

    Three types of labour camp cabins in Dubai - portacabin, prefab permanent structure, and container conversion

    Portacabins (Modular and Fully Relocatable)

    Portacabins are the workhorse of the Dubai labour camp market. These are steel-framed, sandwich panel-insulated units designed to be craned onto flatbed trucks and redeployed across multiple project sites over their working life.

    Standard available sizes and their primary uses:

    • 3m × 6m – most common for small sleeping bays, security rooms, and site supervisor offices.
    • 3m × 9m – mid-range units used for bathroom blocks and compact dining areas.
    • 3m × 12m – larger sleeping quarters capable of housing 16 to 20 workers per unit.

    Key advantages of portacabins for Dubai projects:

    • Fully relocatable – crane on, truck off, and redeploy to the next project site.
    • Fast installation – most standard units can be placed and connected within days.
    • Scalable – additional units are added as headcount grows without major ground work.
    • Widely available for both purchase and short-term rental across Dubai.

    When relocatability creates real value: When your Al Quoz project finishes, the cabins are craned onto flatbeds and move directly to your Jebel Ali project. For contractors running sequential or simultaneous projects, this is a genuine financial asset. For single-project buyers with no confirmed second deployment, the purchase economics need careful evaluation against the rental alternative.

    Prefabricated Permanent Structures

    These are bolted or welded semi-permanent buildings constructed on concrete foundations and not intended to be moved once installed. They cost more upfront, require a full Dubai Municipality building permit, and are typically specified for camps running two or more years on a fixed site.

    Key characteristics of prefabricated permanent structures:

    • Higher construction quality and thicker insulation as standard.
    • Better natural alignment with MOHRE space and ventilation standards due to larger room dimensions.
    • Requires DM building permit submission before any ground work begins.
    • Offers a higher quality of living environment, which supports worker retention on long projects.
    • Best suited for mega project operators and main contractors with a confirmed multi-year project pipeline on a single site.

    Container Conversions

    ISO shipping container repurposing is a growing trend in Dubai’s southern industrial zones – particularly Dubai Investment Park (DIP), Jebel Ali, and Ras Al Khor. Containers are structurally robust, stackable into two- and three-storey configurations, and comparatively cost-effective to source.

    Advantages of container conversions:

    • Structurally strong – ISO containers are built to carry 25+ tonnes of stacked load.
    • Stackable – can be configured into multi-storey camp layouts on compact sites.
    • Cost-effective to acquire compared to purpose-built cabin structures.
    • Suitable for remote or rugged industrial sites where durability is the priority.

    The critical compliance point every buyer must understand: A converted container must meet exactly the same MOHRE insulation, ventilation, and sleeping space standards as any other accommodation structure. Raw, uninsulated containers fail inspection immediately. Dubai Municipality inspectors specifically look for this shortcut. Any container conversion used for worker accommodation must have full sandwich panel wall lining, mechanical ventilation, and certified AC systems before it is legally occupiable.

    You can explore the full range of containerized and prefab cabin options – including labour residence cabins, site office cabins, kitchen and mess hall units, and toilet blocks – to compare specifications before approaching any supplier.

    The Distinction That Costs Contractors Real Money Every Year

    There is one terminology confusion that generates financial surprises on Dubai projects every year – the difference between a cabin supplier and a camp operator.

    What this means in practice:

    • A supplier who delivers excellent cabins will not automatically manage your DEWA connection.
    • A supplier will not submit your MOHRE accommodation registration unless it is explicitly in their service scope.
    • Many projects require both a cabin supplier and a camp operator – and they are not interchangeable.

    Clarify in writing exactly which scope each party is responsible for before signing any agreement.

    Who Needs a Labour Camp Cabin in Dubai? And What Type Fits Your Project?

    Labour camp cabins in Dubai are required by any company employing workers who cannot practically be housed in city accommodation.

    The industries most commonly affected include:

    • Construction and civil infrastructure.
    • Oil and gas operations across onshore and offshore sites.
    • Manufacturing and light industry in Dubai’s industrial zones.
    • Logistics, warehousing, and port operations.
    • Facility management and large-scale cleaning services.
    • Healthcare and infrastructure project contractors.

    The right solution depends on your worker count, project duration, budget structure, and site location.

    Fully operational MOHRE-compliant labour camp in Dubai with sleeping cabins, dining hall, and bathroom blocks

    Matching Your Camp Solution to Worker Count

    Large main contractors – 300 to 2,000+ workers

    These operations require a full modular labour camp ecosystem, including:

    • Sleeping blocks (minimum 3 sq.m per worker sleeping area).
    • Dedicated ablution blocks (1 bathroom unit per 8 to 10 workers).
    • A commercial kitchen and dining hall (1.5 sq.m per simultaneous diner).
    • Laundry facilities (1 machine or trough per 15 workers).
    • Recreational areas (required by MOHRE for camps of 500+ workers).
    • A small on-site medical room with first-aid supplies.

    At this scale and project duration, purchasing is almost always the better financial decision, provided cabins have a confirmed redeployment plan after the project ends.

    Mid-size subcontractors – 50 to 300 workers

    This is the most common buyer profile in Dubai’s construction market. Modular portacabin clusters work effectively here – scalable as headcount grows, and relocatable when the project completes. Both purchase and rental are financially viable depending on the project length.

    Small contractors or short-term projects – 20 to 50 workers

    At this scale and duration, renting from an established labour camp cabin supplier in Dubai is almost always the better financial decision. The per-cabin rental market is active and well-supplied, and the capital savings versus purchasing are significant when the project runs under twelve months.

    Free zone operators – variable headcount

    Companies working within JAFZA, DIP, TECOM, or Trakhees-governed areas face an additional compliance layer on top of standard MOHRE and Dubai Municipality requirements. Each free zone runs its own HSE accommodation approval process, which can add two to four weeks to your mobilisation timeline if not initiated on day one.

    Should You Buy, Rent, or Lease? The 3-Factor Decision Guide

    Workforce Stability

    • Fluctuating headcount → Rent. Flexibility to scale units up or down without owning idle cabins is worth the rental premium.
    • Fixed, predictable workforce → Buy. Operational certainty over the full project life justifies the capital commitment.

    Budget Structure

    • CAPEX-constrained → Rent. Preserve upfront capital and manage accommodation as a monthly operating cost.
    • OPEX-constrained → Buy. Deploy available capital now to reduce the monthly cost burden across the full project duration.

    Dubai Labour Camp Rules – MOHRE, Dubai Municipality, and Free Zone Authorities Fully Explained

    Dubai labour camp rules operate at three distinct levels. MOHRE sets federal worker welfare standards. Dubai Municipality enforces structural and safety permits at the emirate level. Free zone authorities – JAFZA, Trakhees, and TECOM – impose additional project-level requirements on top of both. Non-compliance can result in fines of up to AED 50,000 per violation per worker, and in serious cases, complete project work permit suspension.

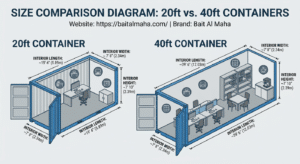

    Dubai labour camp compliance layers - MOHRE, Dubai Municipality, and free zone authority requirements

    MOHRE Standards – The Federal Compliance Foundation

    The primary legislation governing worker accommodation in Dubai and across the UAE is Ministerial Resolution No. 44 of 2022 Regarding Occupational Health and Safety and Labour Accommodation, in effect since February 2022.

    Supporting legislation that also applies:

    • Cabinet Resolution No. 13 of 2009 – General Standards for Collective Labour Housing for camps of 500 or more workers.
    • Ministerial Decree No. 212 of 2014 – Standards Manual for camps housing fewer than 500 workers.
    • Administrative Decision No. 19 of 2023 – Additional occupational safety and accommodation requirements.

    Who must comply: Under Ministerial Resolution No. 44 of 2022, establishments employing 50 or more workers earning AED 1,500 or less per month must provide registered accommodation and register through the MOHRE Labour Accommodation System at mohre.gov.ae.

    The complete MOHRE compliance checklist for every labour camp cabin in Dubai:

    1. Minimum 3 sq.m of sleeping area per worker – sleeping floor space measured around each bed only; bathroom and corridor areas do not count.
    2. 1 bathroom unit per 8 to 10 workers – each unit comprising a toilet, shower, and washbasin.
    3. Minimum dining space of 1.5 sq.m per worker eating simultaneously in the dining hall.
    4. Laundry facilities – minimum one washing machine or laundry trough per 15 workers.
    5. Company signage in both Arabic and English displayed on the building exterior.
    6. A designated camp manager (welfare officer) appointed for all camps of 50 or more workers.
    7. Non-flammable building materials used throughout the cabin structure and roof.
    8. Sufficient lighting – natural and artificial – in all sleeping, dining, bathroom, and common areas.

    Compliance growth since 2022: Since the MOHRE Labour Accommodation System launched in February 2022, registered compliance among private sector companies increased by 1,000% by the end of 2023, according to MOHRE’s published data. That figure signals two things: enforcement has intensified dramatically, and a significant portion of the market was previously operating outside the law.

    Dubai Municipality Standards – The Structural and Safety Layer

    MOHRE governs welfare standards. Dubai Municipality governs the physical installation, structural integrity, and safety systems. Both layers must be satisfied before a single worker is legally permitted to move in.

    Key Dubai Municipality requirements for labour camp cabin installations:

    • Building permit – Required for any semi-permanent or permanent cabin structure before any ground work begins. DM permit processing cannot be accelerated. Starting it late is the single most common cause of timeline overrun in Dubai camp setup.
    • Fire safety compliance – Tiered by camp size:
      • All camps: fire extinguishers in each sleeping cabin, heat and smoke detectors throughout.
      • Larger camps: interconnected alarm systems.
      • Above specified occupancy levels: full sprinkler or FM-200 suppression systems required.
    • Civil Defence certificate – The Dubai Civil Defence authority issues fire safety compliance certificates independently. Both DCD and DM sign-offs are required before workers move in.
    • Sewage and wastewater – Camp sewage must connect to the DM municipal sewage network or a DM-certified septic tank with licensed waste removal. Open drainage is entirely illegal and is among the most common primary inspection failure points.

    Free Zone Authorities – The Third Compliance Layer

    If your project falls within any free zone boundary, a third authority must approve your accommodation setup before it is legally operational.

    The practical rule for free zone projects:

    • Identify the relevant free zone authority on day one of project planning.
    • Start their approval process in parallel with Dubai Municipality – never after.
    • Running these approvals sequentially rather than simultaneously costs two to four weeks that most mobilisation schedules cannot absorb.

    What Happens When You Do Not Comply?

    Financial penalties:

    • Fines range from AED 5,000 to AED 50,000 per violation per worker, depending on the severity and nature of the non-compliance.
    • Space violations – sleeping area below the 3 sq.m minimum – attract the highest individual fines in the MOHRE penalty framework.

    Operational consequences:

    • Dubai Municipality can freeze new work permit issuances to any company with outstanding accommodation violations.
    • Persistent or severe violations result in project suspension notices – a full stop on all construction activity until accommodation is remediated and re-inspected.
    • Suspension of a 200-worker project for two weeks can cost far more in lost productivity than the compliance investment would have.

    Complaint-triggered inspections:

    • Workers report accommodation issues directly to the MOHRE hotline at 800MOHRE (800 64673).
    • Complaints trigger priority inspections within 48 to 72 hours – typically unannounced.
    • Since MOHRE’s complaint systems became accessible via mobile platforms, the volume and speed of complaint-triggered inspections has increased significantly.

    Reputational and commercial consequences:

    • Both DM and MOHRE maintain digital violation records visible to other authorities during future permit and tender processing.
    • Companies with documented violation histories are increasingly disqualified from public sector tenders.
    • International clients operating ESG reporting frameworks are auditing worker accommodation standards as part of supply chain due diligence. A violation record surfaces in these audits and can cost contracts with major developers.

    Engineering Standards for Dubai’s Climate – What Your Labour Camp Cabin Must Physically Withstand

    Labour camp cabins in Dubai must withstand:

    • Summer temperatures exceeding 48°C from June to September.
    • Coastal humidity at sea-facing and creek-adjacent sites.
    • Sand-laden shamal winds at high velocity.
    • Structural wind loads at UAE design speeds of 45 metres per second.

    A standard portacabin specification designed for a European or South Asian climate is not adequate in this environment without significant modification. Dubai Municipality inspectors know the difference.

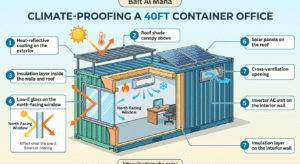

    Sandwich panel insulation cross-section for Dubai labour camp cabin - PU core vs EPS core comparison

    Sandwich Panel Insulation – The Most Important Specification Decision You Will Make

    The wall and roof panels are the single biggest determinant of thermal performance in any prefab labour camp cabin in Dubai. Every cabin uses sandwich panels, but the core material and thickness determine whether your AC system can maintain 24°C on a July afternoon or runs at maximum capacity and still fails.

    Sandwich panel comparison table for Dubai conditions:

    Panel Type Core Material Thickness Thermal Rating Dubai Suitability
    Basic EPS Expanded Polystyrene 50mm Low Storage cabins only. Fails MOHRE worker accommodation compliance in peak summer.
    Mid-grade EPS Expanded Polystyrene 75mm Medium Acceptable with oversized AC units. Electricity costs will be significantly higher.
    PU Core Polyurethane 75mm High Recommended standard for sleeping quarters in Dubai.
    PIR Core Polyisocyanurate 100mm Highest Best choice for large camps. Reduces AC energy consumption by 25 to 30%.

    What to ask every labour camp cabin supplier in Dubai before signing:

    • What is the exact U-value of your standard insulation panel?
    • What core material does it use – EPS, PU, or PIR?
    • What is the panel thickness – 50mm, 75mm, or 100mm?
    • Are these figures confirmed in the written purchase agreement?

    Never accept “insulated panels” as a specification. Insist on the core material, thickness, and U-value confirmed in writing.

    Air Conditioning Sizing – What Actually Works in a Dubai Summer

    The practical sizing rule for UAE camp designers: 1.5-ton inverter split unit per 20 sq.m of occupied sleeping space.

    AC specification choices and their consequences:

    • DC inverter units – energy-efficient, variable speed, lower electricity bills over a full summer season. Strongly preferred for all Dubai labour camps.
    • Fixed-speed units – higher electricity consumption at equivalent cooling output. Avoid where project duration exceeds six months.
    • Unshaded outdoor condensers – lose 20 to 30% of cooling efficiency in direct August sun. A basic steel shade canopy over each outdoor unit costs a fraction of one month’s wasted electricity and is consistently overlooked.

    Monthly electricity impact: A 100-worker camp running fixed-speed AC units through a Dubai summer month can consume 30,000 to 50,000 kWh more electricity than an equivalent inverter-equipped camp. Over a 12-week summer season, this difference runs into tens of thousands of dirhams.

    Structural Requirements – Frames, Foundations, and Wind Loading

    Critical structural specifications for Dubai conditions:

    • Wind load certification – UAE design wind speed is 45 metres per second. Every cabin frame must be certified to withstand this load.
    • Galvanized steel frames for coastal sites – Mandatory for any site within approximately 3 kilometres of the sea, the Creek, or any harbour. Mild steel corrodes in coastal humidity within 12 to 18 months.
    • Raised flooring – In clay-heavy soil areas like Sonapur (Al Muhaisnah), cabins must sit a minimum of 150mm above ground level. Anti-slip surfaces required in bathrooms and all wet areas.
    • Foundation type must match soil conditions – Rocky ground, clay soil, and compacted gravel have different load-bearing characteristics.

    Foundation options for Dubai sites:

    Foundation Type Best Suited For Cost Level
    Concrete plinths Semi-permanent camps on level, stable ground. Higher upfront.
    Steel base frames Uneven or rocky terrain, adjustable installation. Mid-range.
    Compacted gravel beds Short-term camps on stable, dry ground only. Not for coastal sites. Lowest.

    Ventilation – Why Passive Airflow Fails Above 35°C

    Passive cross-ventilation – windows on opposing walls, no mechanical assistance – is sufficient in temperate climates and during Dubai’s winter months. Above 35°C ambient temperature, it moves hot air through the cabin without reducing heat stress.

    Minimum mechanical ventilation requirements for compliant Dubai labour camp cabins:

    • Exhaust fans in every sleeping bay – minimum one per occupied room.
    • Exhaust fans in every bathroom block – minimum one per bathroom unit.
    • Kitchen ventilation on a separate exhaust circuit – never shared with any sleeping cabin HVAC system.
    • Commercial-grade exhaust hoods over all cooking equipment in the kitchen block.
    • Regular maintenance – filters cleaned monthly, fan performance checked quarterly.

    How to Set Up a Labour Camp Cabin in Dubai – A Complete Step-by-Step Process

    Setting up a labour camp cabin in Dubai follows four sequential phases:

    1. Pre-setup planning and authority approvals (Weeks 1 to 2).
    2. Site preparation – ground work and utility connections (Weeks 2 to 3).
    3. Cabin delivery, installation, and MEP commissioning (Weeks 3 to 4).
    4. Final MOHRE and Dubai Municipality inspection sign-off before worker move-in.

    The most important rule of Dubai camp mobilisation: Authority approvals started late become the critical path item sitting between your cabins being physically ready and your workers being legally permitted to occupy them. Always start the approvals in Week 1 – never after the cabins are ordered.

    Labour camp cabin setup timeline in Dubai - 4-phase process from site survey to worker move-in

    Pre-Setup Planning (Weeks 1–2)

    Conduct a Thorough Site Survey

    Visit the site with an MEP engineer before ordering any cabin. The survey must document:

    • Soil type and condition – determines foundation approach and preparation cost.
    • DEWA connection points – whether an LV supply already exists or needs to be drawn from the nearest point.
    • Sewage network access – municipal connection feasibility or certified septic system requirement.
    • Available plot area – measured against your headcount and MOHRE space calculations.
    • Proximity to the sea or humid zones – determines whether galvanized steel frames are mandatory.

    Calculate Headcount and Plan the Camp Layout

    Calculate total built area required using MOHRE minimum figures:

    • Sleeping areas: 3 sq.m per worker (sleeping space definition only, not total room area).
    • Bathroom blocks: 1 unit per 8 to 10 workers (toilet + shower + washbasin per unit).
    • Dining area: 1.5 sq.m per worker eating simultaneously.
    • Kitchen, laundry, and recreational areas: calculated separately based on total camp occupancy.

    Submit the site layout drawing to Dubai Municipality as part of the building permit application.

    Submit All Authority Applications Simultaneously

    Do not wait to complete one application before starting the next. Submit all three in the same week:

    1. Dubai Municipality building permit application.
    2. MOHRE Labour Accommodation System registration at la.mohre.gov.ae.
    3. Free zone authority approval where applicable – JAFZA, Trakhees, or TECOM.

    Running these in parallel rather than in sequence saves two to four weeks on your mobilisation timeline.

    Issue RFQs to Minimum Three Suppliers

    Send a Request for Quotation to at least three suppliers, each with a full technical specification attached covering:

    1. Panel type, core material, and minimum U-value required.
    2. Frame material – galvanized or mild steel specified clearly.
    3. AC capacity – ton rating and inverter or fixed-speed type required.
    4. Flooring specification – raised height, anti-slip surface material.
    5. Warranty terms required – structural (minimum 12 months) and MEP (minimum 6 months).

    Quotes without a matching specification sheet are not comparable. Like-for-like comparison is only possible when all suppliers quote on identical specifications.

    Site Preparation (Weeks 2–3)

    Ground Levelling and Compaction

    The site must be levelled and compacted to a minimum California Bearing Ratio (CBR) value capable of supporting the cabin base load. On clay-heavy soil common in Sonapur and Muhaisnah, this sometimes requires significant rework. Discovering inadequate ground conditions after cabin delivery is one of the most commonly reported and most avoidable delays in Dubai camp mobilisation.

    Choose the Correct Foundation Type

    Select the foundation system that matches your ground conditions:

    • Concrete plinths – most robust option, highest upfront cost. Best for semi-permanent camps on level, stable ground.
    • Steel base frames – faster to install, adjustable for uneven or rocky terrain. Preferred where ground conditions are variable.
    • Compacted gravel beds – lowest cost option. Appropriate for short-term camps on stable dry ground only. Not recommended for coastal sites or clay-heavy soil.

    Utility Trenching

    Excavate and install the following services before any cabin is placed on site:

    1. Water supply line from the nearest municipal connection point.
    2. Sewage outlet pipe running to the municipal network or certified septic tank.
    3. DEWA LV electrical cable from the approved connection point.

    Get DEWA’s technical requirements for the electrical supply in writing before trenching begins. The trench depth and cable specifications are prescribed by DEWA and must be followed exactly for the connection inspection to pass.

    Install Perimeter Fencing and Security Gate

    Dubai Municipality requires all organised labour camps to have:

    • A clearly defined perimeter boundary with solid fencing.
    • A controlled entry point with a lockable gate.
    • Clear access for emergency vehicles.

    Install the perimeter fence and security gate before the DM structural inspection. This is a standard DM checklist item.

    Cabin Delivery and Installation (Weeks 3–4)

    Coordinate Delivery Logistics

    Confirm the following before the first delivery truck arrives on site:

    • A crane or forklift of sufficient lifting capacity is booked and on-site.
    • Site access routes can accommodate delivery vehicle dimensions and turning circles.
    • A banksman and certified lifting supervisor are present during all crane operations.
    • For two-storey configurations, crane availability is confirmed in advance – not assumed.

    Follow the Correct Assembly Sequence

    Install in this order without skipping steps:

    1. Steel base frame installation and levelling.
    2. Insulated wall panel assembly.
    3. Roof panel installation and waterproofing.
    4. Door and window frame fitting.
    5. Internal partition walls where required.
    6. MEP fit-out – electrical, plumbing, AC, and ventilation.

    Do not commission AC units before the building envelope is fully sealed. Running split units in an open or partially assembled frame wastes electricity and risks compressor damage.

    MEP Commissioning

    Test every system before calling for inspection:

    • AC split units – verify cooling output and temperature hold at 24°C.
    • Electrical distribution boards – test all circuits, RCDs, and earthing connections.
    • Interior lighting – confirm adequate illumination in all sleeping, bathroom, kitchen, and common areas.
    • Bathroom plumbing – check water pressure, drainage flow, and all fixtures.
    • Kitchen connections – verify cooking equipment is safely connected and exhaust is functioning correctly.

    Fire Safety Installation and Civil Defence Sign-Off

    Install all required fire safety equipment before calling for any inspection:

    • Fire extinguishers in each sleeping cabin and all common areas.
    • Smoke and heat detectors throughout the camp.
    • Emergency exit lighting on all evacuation routes.
    • Sprinkler or FM-200 suppression systems where required by occupancy threshold.

    Request the Dubai Civil Defence inspection and obtain their sign-off certificate. Civil Defence clearance is a prerequisite for DM final approval.

    Inspections and Operational Readiness

    MOHRE Accommodation Inspection

    Submit the inspection request through the MOHRE portal. Inspectors will check:

    • Sleeping area per worker – measured against the 3 sq.m sleeping space definition.
    • Bathroom ratios per total worker count.
    • AC functionality and indoor temperature at or below 24°C.
    • Kitchen and laundry provision – equipment and capacity confirmed.
    • Building material compliance – non-flammable confirmation.
    • Documentation completeness – all permits, registrations, and contracts on file.

    Dubai Municipality Final Inspection

    DM inspectors verify:

    • Structural compliance with the approved building permit drawings.
    • Civil Defence fire safety clearance certificate on file.
    • Electrical installation quality and DEWA compliance.
    • Sewage connection confirmation to municipal network or certified septic system.

    Setup Timeline at a Glance:

    Camp Size Estimated Total Timeline Critical Path Item
    Under 50 workers 1 to 2 weeks MOHRE registration timing.
    50 to 200 workers 3 to 4 weeks DM permit and DEWA connection.
    200 to 500 workers 5 to 6 weeks Authority approvals and site preparation.
    500+ workers (full camp) 6 to 10 weeks All authorities in parallel from Week 1.



    Labour Camp Cabin Cost in Dubai – Complete Pricing Guide

    Labour camp cabin costs in Dubai range from AED 8,000 for a basic single sleeping unit to AED 600,000+ for a fully operational 100-worker turnkey camp. Monthly rental runs AED 800 to AED 2,500 per cabin, or AED 500 to AED 1,500 per person in a fully managed, all-inclusive facility. Hidden costs – site preparation, DEWA connection, compliance fees, furniture, and operations – typically add 30 to 40% on top of the cabin purchase price.

    Labour camp cabin cost breakdown in Dubai - full mobilisation cost for 100 workers

    Purchase Price by Cabin Type  2026 UAE Market Rates

    Cabin Type Dimensions Capacity Price Range (AED) Best For
    Basic sleeping cabin (EPS 50mm) 3m × 6m 8–10 workers 8,000–14,000 Short-term, inland, non-coastal sites only.
    Standard insulated cabin (EPS 75mm) 3m × 6m 8–10 workers 14,000–22,000 General construction camps across Dubai.
    Premium PU panel cabin 3m × 12m 16–20 workers 35,000–55,000 Long-term camps and high-heat exposure zones.
    2-storey modular block Custom 40–60 workers 120,000–200,000 Large contractor camps requiring density.
    Full turnkey camp (100 workers) Site-specific 100 workers 350,000–600,000 Main contractor full mobilisation.
    Full turnkey camp (500 workers) Site-specific 500 workers 1,800,000–3,000,000 Mega project operators with long pipelines.

    Monthly Rental Cost Structure

    Rental Type Monthly Cost (AED) What Is Included
    Per cabin – unit only 800–1,500 Cabin structure only, no management.
    Per cabin – fitted with AC 1,200–2,500 Cabin with AC installed and serviced.
    Per person – managed camp 500–900 Cabin, bed, and utilities.
    Per person – full-service camp 1,000–1,500 Cabin, utilities, meals, and daily cleaning.

    Why the per-person monthly range is wide – the key variables:

    • Location: Sonapur pricing typically runs 20 to 30% lower than Dubai Investment Park for equivalent facilities.
    • AC specification: Fixed-speed versus inverter units affect electricity costs, which are sometimes included or passed through separately in the rental rate.
    • Meal inclusion: A self-catering camp and a full-board managed facility are fundamentally different services.
    • Camp size: Larger camps spread fixed overhead costs – management, utilities infrastructure, maintenance – across more workers, reducing the per-person rate.
    • Contract duration: Longer rental contracts typically attract lower monthly rates than short-term or month-to-month arrangements.

    Hidden and Ongoing Costs – What Most Projects Miss

    Add every item in this table to your financial model before signing any purchase order. These are not contingency items. They are predictable, quantifiable costs that experienced camp operators budget for and first-time buyers consistently miss.

    Cost Item Type Estimated Range (AED)
    DEWA connection fee One-time 3,000–8,000
    DEWA security deposit (refundable at project end) One-time 5,000–20,000
    Site levelling, compaction, and drainage One-time 15,000–80,000
    Foundation work – concrete plinths or steel base One-time 8,000–40,000
    MOHRE accommodation registration One-time per unit 300–500
    Dubai Municipality building permit One-time 2,000–10,000
    Fire safety system installation One-time 5,000–25,000
    Perimeter fencing and security gate One-time 8,000–30,000
    Cabin furniture and FF&E per worker One-time 800–2,500 per worker
    Monthly DEWA – electricity and water Monthly 150–300 per worker
    Annual maintenance reserve Ongoing 5–8% of cabin value per year
    Camp manager salary Monthly 3,000–6,000
    Pest control and cleaning contracts Monthly 500–2,000 per camp

    The real-cost rule of thumb: Add 30 to 40% on top of the cabin purchase price to calculate the true mobilisation cost. A 100-worker camp with AED 400,000 in cabin costs will require AED 520,000 to AED 560,000 in total before the first worker sleeps there.

    Buy vs. Rent – The Financial Decision at a Glance

    The break-even point is approximately 18 to 24 months for a standard 100-worker setup.

    Renting makes more financial sense when:

    • Project duration is under 12 months.
    • Worker headcount is expected to fluctuate significantly.
    • The site is in a free zone with restrictions on permanent structures.
    • Your company is CAPEX-constrained with available monthly budget.
    • This is your first Dubai camp setup and compliance risk management is still being built internally.

    Buying makes more financial sense when:

    • Project duration is 24 months or longer.
    • Workforce size is stable and predictable throughout the project.
    • Cabins can be relocated to a confirmed next project site at the end of the current one.
    • Your company runs multiple simultaneous or sequential projects with ongoing accommodation needs.
    • Your company is OPEX-constrained but has capital available for deployment.

    For a closer look at specifications and pricing across different cabin sizes and insulation grades, the prefab products range covers labour residence cabins, kitchen and dining units, toilet blocks, and modular multi-storey accommodation blocks – which helps compare options before entering supplier negotiations.

    How to Evaluate a Labour Camp Cabin Supplier in Dubai – A Practical Framework

    Choosing the wrong labour camp cabin supplier in Dubai is not just a procurement error – it is a compliance risk that can delay your project and expose your company to MOHRE fines. Use this framework before committing.

    Labour camp cabin manufacturing facility in UAE - quality inspection before site delivery

    The 4 Non-Negotiable Supplier Checks

    Before requesting a quote from any portacabin supplier in Dubai, verify all four of these independently:

    1. Valid UAE Trade License – Check on the DED portal. A supplier without a current license cannot provide an enforceable warranty or be pursued legally if the product fails.
    2. ISO 9001 certification for manufacturing – Covers quality management across design, production, and delivery. Ask for the certificate number and verify it is current.
    3. Documented MOHRE-registered camp installations – Ask for a UAE project reference list with direct contact details. A supplier genuinely experienced with compliant Dubai camps will provide this without hesitation.
    4. Written warranty terms – Minimum 12 months structural and 6 months MEP, confirmed in the contract – not in a sales conversation.

    5 Red Flags – Walk Away If You See Any of These

    1. No physical showroom, factory, or completed project site visit is offered before purchase.
    2. The supplier cannot produce a panel specification sheet with U-value figures.
    3. Payment is demanded 100% upfront with no milestone-based payment structure.
    4. MOHRE accommodation registration support is absent from the written service scope.
    5. The supplier cannot provide direct contact details for UAE reference clients from projects of similar scale to yours.

    8 Questions to Ask Any Labour Camp Cabin Supplier Before Signing

    These questions reveal more about a supplier’s genuine capability than any brochure or website:

    1. What is the U-value of your standard insulation panel, and what core material does it use?
    2. Are your steel frames mild steel or galvanized – and what corrosion warranty covers coastal sites?
    3. Do you handle MOHRE accommodation registration on our behalf, or is that entirely our responsibility?
    4. What is your production lead time from purchase order to site delivery?
    5. Can you provide direct contact details for UAE clients from completed camps of similar size to ours?
    6. What does your warranty cover specifically – and what conditions void it?
    7. Do you provide on-site support during MOHRE or Dubai Municipality inspection?
    8. What is your payment milestone structure, and what percentage is required as the initial deposit?

    Reviewing a supplier’s completed projects portfolio before an on-site visit gives you a clearer sense of their delivery consistency across different camp types and project scales – something no quote document can convey on its own.

    Where to Set Up a Labour Camp in Dubai – Zone-by-Zone Location Guide

    Camp location should match the geographical cluster of your active project sites. Commute time is a MOHRE welfare compliance factor – not merely a logistics preference. A camp located more than 45 minutes from the primary worksite is a welfare flag that inspectors have specifically raised in response to worker complaints.

    Dubai labour camp zones map - Sonapur, DIP, Jebel Ali, Ras Al Khor, Al Quoz location guide

    Zone-by-Zone Overview

    Zone Cost Level Best For Authority
    Sonapur (Al Muhaisnah) Lower Large main contractor camps; North Dubai and Deira projects. Dubai Municipality.
    Dubai Investment Park (DIP) Medium to High Southern Dubai – Expo City, DWC, Al Maktoum area. DIP Authority.
    Jebel Ali / JAFZA High Port workers, logistics, JAFZA-based operations. JAFZA.
    Ras Al Khor Medium Manufacturing, light industry, Creek corridor projects. Dubai Municipality.
    Al Quoz Industrial Limited Small on-site security and supervisory cabins only. Dubai Municipality.

    Sonapur (Al Muhaisnah) – Established, High Capacity, Lower Cost

    Sonapur is Dubai’s most established and highest-capacity labour accommodation zone, located in the Muhaisnah district near Al Qusais. It provides direct access to Sheikh Mohammed Bin Zayed Road and Emirates Road.

    Key characteristics of Sonapur as a camp location:

    • Rental costs typically 20 to 30% lower than DIP for equivalent facilities.
    • Well-established support infrastructure – markets, clinics, banks, mosques, and money exchange centres within walking distance of major camp clusters.
    • Active public transport connections – multiple bus routes with metro access a short transfer away.
    • Older camp stock requires careful compliance inspection before selection, particularly on fire safety and sleeping space standards.
    • Suitable for large teams serving Deira, North Dubai, and the northern industrial belt.

    Dubai Investment Park (DIP) – Modern, Compliant, Higher Cost

    DIP is the preferred zone for contractors working on southern Dubai projects – the former Expo City site, Al Maktoum International Airport expansion, Dubai South, and the logistics clusters in the area.

    Key characteristics of DIP as a camp location:

    • Higher rental rates – 20 to 30% above Sonapur for comparable facilities.
    • Newer building stock with better alignment to current MOHRE and DM standards.
    • DIP Authority adds a green building compliance layer beyond standard DM requirements.
    • Proximity to southern Dubai project clusters reduces worker commute times significantly.
    • Preferred by international contractors operating under ESG reporting frameworks.

    The Commute-Time Compliance Factor That Nobody Talks About

    MOHRE’s worker welfare standards include reasonable commute time as a component of overall accommodation suitability. A camp located more than 45 minutes from the primary project site is a welfare flag – and long daily commutes in high ambient heat are a documented occupational safety risk on UAE construction sites.

    The practical location matching rule:

    • North Dubai and Deira projects → Sonapur or Muhaisnah.
    • Southern Dubai and airport area projects → Dubai Investment Park.
    • JAFZA and port projects → Jebel Ali corridor.
    • Ras Al Khor and Creek-side projects → Ras Al Khor industrial zone.

    Understanding which accommodation cabin configuration fits each zone – in terms of cabin type, insulation grade, foundation system, and utility connection approach – is part of what experienced prefab suppliers in Dubai advise on as part of their service, not just the physical structure.

    8 Costly Mistakes When Setting Up a Labour Camp Cabin in Dubai

    Every mistake below is avoidable. Every one of them has a financial consequence that exceeded the cost of getting it right first time.

    Compliant vs non-compliant labour camp cabin setup in Dubai - what MOHRE inspectors look for

    Misapplying the MOHRE 3 sq.m Sleeping Space Calculation

    What happens: Many contractors calculate total room floor area and divide by the number of beds. MOHRE calculates the usable sleeping space around each bed – a smaller figure once bed frame dimensions, wall clearances, and the walkway between bunks are subtracted.

    The result: A cabin physically containing 20 beds often only complies for 12 workers under MOHRE’s measurement method.

    How to avoid it: Specify cabins around the MOHRE sleeping space definition, not the room’s gross floor area. Ask your supplier to confirm MOHRE-calculated worker capacity, not physical bed count.

     Skipping the Pre-Installation Site Survey

    What happens: Site needing AED 40,000 to AED 80,000 of ground preparation is discovered after cabins are already delivered.

    Common causes: Rocky ground requiring breaking, clay soil needing drainage works, or no DEWA infrastructure within practical connection distance.

    How to avoid it: Conduct a full site survey with an MEP engineer in Week 1. The survey costs a fraction of one day’s project delay.

    Using Mild Steel Frames on Coastal or Humid Sites

    What happens: Mild steel frames show visible surface corrosion within 12 to 18 months at coastal or creek-adjacent sites. A corroded structural frame fails both as a safe structure and under DM inspection.

    How to avoid it: Specify galvanized steel frames for any site within 3 kilometres of the sea, the Creek, or any harbour. Build the cost premium into the initial budget.

    No Shade Structure Over Outdoor AC Condensers

    What happens: Outdoor condensers in direct August sun operate beyond their design temperature tolerance, losing 20 to 30% of cooling efficiency and driving up electricity costs for the entire summer.

    How to avoid it: Install a basic steel shade canopy over every outdoor AC unit. This is one of the cheapest improvements available to any Dubai camp operator and pays for itself within the first summer month in electricity savings.

    Ignoring the Camp Manager Requirement

    What happens: MOHRE inspectors ask to speak with the designated welfare officer directly. A manager who cannot be located, is not registered, or whose name appears across an implausibly large number of simultaneously managed camps is an automatic and serious inspection flag.

    How to avoid it: Appoint a genuine, MOHRE-registered welfare officer before worker move-in. For camps of 50 or more workers, this is a legal requirement.

    Missing the DEWA Security Deposit in the Financial Model

    What happens: An unexpected cash-flow requirement of AED 5,000 to AED 20,000 appears in the week before worker move-in.

    How to avoid it: Include the DEWA security deposit in your initial project financial model alongside all other one-time setup costs. It is refundable at project end but must be paid before the power connection is made.

    Buying Cabins Without a Relocation Exit Plan

    What happens: Cabins left idle on a completed project site lose 30 to 40% of their market value through panel deterioration and weather damage within two to three years.

    How to avoid it: Build the exit strategy – redeploy to next project, resell, or arrange supplier buyback – into the procurement decision at the point of purchase. Many established suppliers offer refurbishment and relocation services that make redeployment straightforward and protect the resale value of your investment.

    Accepting a Single Supplier Quote

    What happens: Price variation across Dubai’s portacabin supplier market for identical specifications regularly exceeds 30%. Without comparable quotes, there is no basis for determining whether a price is competitive.

    How to avoid it: Obtain at least three quotes based on identical specifications – same panel type, frame material, AC equipment grade, fit-out level, and warranty terms. Compare only like-for-like submissions.

    The Future of Labour Camp Cabins in Dubai – 2025 to 2030 Outlook

    Four trends are reshaping the Dubai prefab labour camp market between 2025 and 2030. Contractors who understand these shifts now will mobilise future camps at lower operational cost and with less compliance friction in each project cycle.

    Future of labour camp cabins in Dubai - solar-assisted modern prefab accommodation 2025 to 2030

    Solar-Assisted AC Systems

    The economics of solar in UAE labour camps:

    • A well-sized solar array on a standard 100-worker camp can reduce DEWA electricity dependency by 30 to 40% during daylight hours.
    • Return on investment is typically achieved within three to four years.
    • Adoption is currently strongest in DIP camps and newer Jebel Ali industrial facilities.
    • As DEWA tariff structures evolve and solar installation costs fall, solar-assisted AC will shift from an optional upgrade to a standard specification inclusion.

    IoT-Enabled Camp Management

    Smart monitoring technology now entering the Dubai prefab camp market:

    • Per-cabin electricity meters with remote monitoring – identify energy waste, equipment failures, and unusual consumption without physically inspecting each unit.
    • Occupancy sensors – beginning to automate MOHRE headcount reporting, replacing a manual and time-consuming compliance process.
    • Worker welfare complaint apps – routing issues directly to camp management before they escalate to the MOHRE hotline. Well-managed camps using these tools are measurably reducing unannounced inspection triggers.
    • Preventive maintenance alerts – IoT sensors detecting AC failures or plumbing issues before they become inspection failures.

    Modular Pre-Plumbed Bathroom Pods

    Why bathroom pods are gaining traction in large Dubai camp setups:

    • Reduce on-site ablution block installation time by up to 60% – a meaningful gain on large camp mobilisations.
    • Factory-controlled installation eliminates the variability of site-built bathrooms.
    • More consistent quality means fewer plumbing-related inspection failures.
    • Bathroom blocks are a frequent critical path item in large-scale camp setups; pods directly address this bottleneck.

    Dubai 2040 Urban Master Plan and Rising Welfare Standards

    Key anticipated changes that camp operators and cabin buyers need to plan for now:

    • Minimum space standards are expected to increase from the current 3 sq.m per worker toward 4 to 5 sq.m in the 2027–2028 regulatory cycle.
    • ESG reporting requirements from international clients – particularly European and North American construction and real estate investors – are already auditing accommodation standards as part of supply chain due diligence.
    • Free zone authorities are beginning to apply green building compliance targets to temporary accommodation structures as well as permanent buildings.
    • Digital compliance reporting – MOHRE portal submissions – will become standard across all camp sizes, not just large operators.

    Contractors planning camps today for projects running into 2027 and beyond should design layouts with the anticipated space increase in mind. Retrofitting a camp mid-project to meet a higher space standard costs significantly more than designing the headroom in from the start.

    For guidance on which prefabricated accommodation designs can be configured to comply with both current and anticipated future standards, reviewing available product specifications before entering supplier conversations saves significant time and rework.

    Final Checklist – What to Confirm Before Setting Up a Labour Camp Cabin in Dubai

    Getting a Dubai labour camp cabin setup right comes down to three decisions made correctly before anything is signed. Miss any one of them and the consequences show up either in your compliance record, your electricity bill, or your project financial model.

    Size Your Camp Correctly

    Calculate space requirements using MOHRE’s precise definitions – not general square-footage estimates:

    • Sleeping area: 3 sq.m per worker measured around each bed, not total room floor area.
    • Bathrooms: 1 unit per 8 to 10 workers – toilet, shower, and washbasin per unit.
    • Dining space: 1.5 sq.m per worker eating simultaneously.
    • Kitchen, laundry, and recreational areas calculated separately based on total occupancy.

    Do not undersize to save money on cabins. The MOHRE fine for undersizing costs more than the additional cabin that would have brought the camp into compliance.

    Choose Your Supplier Based on Project Type

    Match every selection criterion to your specific project reality – not price alone:

    • Insulation grade to climate exposure – coastal and high-temperature sites require PU or PIR panels, not EPS 50mm.
    • Frame material to site location – coastal sites require galvanized steel without exception.
    • Lead time to mobilisation deadline – a supplier with a five-week production schedule cannot serve a two-week mobilisation regardless of price.
    • MOHRE documentation support – confirm in writing which authority submissions the supplier handles and which remain your own responsibility.
    • After-sales support – confirm who to call if there is an inspection issue after installation.

    Budget the Full Mobilisation Cost

    The cabin purchase price is approximately 60 to 70% of your true mobilisation cost. Build the remaining 30 to 40% into your financial model from day one:

    • Site survey, preparation, and foundation work.
    • DEWA connection fee and refundable security deposit.
    • Dubai Municipality building permit.
    • MOHRE accommodation registration.
    • Fire safety system installation and Civil Defence inspection.
    • Perimeter fencing and security gate.
    • Cabin furniture and interior fit-out.
    • First month of operating costs – electricity, water, camp management, cleaning, and pest control.

    Before committing to any supplier, confirm these five things in writing:

    1. Panel specification sheet with U-value confirmed in the purchase agreement.
    2. MOHRE registration support clearly included or excluded from the service scope.
    3. Two verified UAE reference contacts from completed camps of comparable size.
    4. A payment milestone schedule – not a single upfront payment requirement.
    5. Warranty terms covering both structure and MEP with clear conditions for validity.

    The compliance reality that matters most: MOHRE compliance is not a one-time sign-off. It is tied to the ongoing work permit issuances that keep your entire project workforce legally employed. A compliant camp keeps your project moving. A non-compliant camp becomes the official reason it stops.

    Contractors planning their next camp setup can review the full range of prefabricated accommodation solutions available for Dubai and UAE projects – including labour residence cabins, kitchen and mess hall units, toilet cabin blocks, and modular multi-storey accommodation blocks – to understand what specification options are available before entering supplier negotiations. For specific project requirements or a custom quote, getting in touch directly is the fastest way to move from specification to pricing.

    Frequently Asked Questions – Labour Camp Cabin Supplier in Dubai

    Labour camp cabin Dubai - frequently asked questions answered

    What is the minimum space required per worker in a Dubai labour camp?

    The minimum is 3 sq.m of sleeping area per worker under MOHRE Ministerial Resolution No. 44 of 2022. This refers to sleeping floor space measured around each bed – bathroom and corridor areas do not count. Cabins below this standard face fines starting at AED 5,000 per worker in violation.

    How much does it cost to set up a labour camp in Dubai?

    AED 8,000 for a single basic cabin up to AED 600,000+ for a 100-worker turnkey camp. Add 30 to 40% on top of the cabin price for site preparation, DEWA connection, permits, fire safety, furniture, and first-month operations. Monthly costs run AED 500 to AED 1,500 per worker.

    Do I need a permit to install a portacabin in Dubai?

    Yes. A Dubai Municipality building permit is required before any installation begins. MOHRE accommodation registration must also be completed before workers move in. Free zone projects need a separate authority approval from JAFZA, Trakhees, or TECOM on top of both requirements.

    What facilities are required in a Dubai labour camp by MOHRE?

    MOHRE mandates air conditioning (max 24°C indoor), bathroom blocks (1 per 8 to 10 workers), kitchen and dining space (1.5 sq.m per simultaneous diner), laundry facilities, non-flammable building materials, adequate lighting, and a registered camp manager for all camps of 50 or more workers.

    How long does it take to set up a labour camp cabin in Dubai?

    1 to 2 weeks for camps under 50 workers and 5 to 6 weeks for 200 to 500 workers. The most common cause of delay is authority approvals started late. DM permit processing alone can add 2 to 3 weeks if not initiated in Week 1 of the project.

    What areas in Dubai allow labour camp setup?

    Approved zones include Sonapur (Al Muhaisnah), Dubai Investment Park, Jebel Ali (JAFZA), Ras Al Khor, and designated Al Quoz industrial plots. Each zone has different cost levels, compliance authority requirements, and infrastructure quality. Zone selection should match your project’s geographical cluster to avoid commute-time welfare issues.

    What is the difference between buying and renting a labour camp cabin?

    Renting suits projects under 12 to 18 months or those with uncertain headcount. Buying becomes financially advantageous at approximately 18 to 24 months, especially when cabins can be redeployed to the next project. The break-even depends on cabin specification, local rental rates, and redeployment costs at the next site.

    What happens if a labour camp fails a Dubai Municipality inspection?

    Failed inspections result in a rectification notice with a specified compliance deadline. Repeat failures escalate to fines of AED 5,000 to AED 50,000 per violation, new work permit issuance freezes, and potential project suspension. Worker complaints to 800MOHRE (800 64673) trigger priority inspections within 48 to 72 hours.

    Is there a difference between a portacabin supplier and a camp operator?

    Yes. A portacabin supplier manufactures or sells the physical cabin structure. A camp operator manages the complete facility – utilities, catering, cleaning, maintenance, and MOHRE documentation. Many projects need both services, and most cabin suppliers do not automatically provide camp management. Clarify this in writing before signing any agreement.

    Can I rent a labour camp cabin in Dubai instead of buying?

    Yes. A well-established prefab rental and relocation service covers short-term and long-term cabin hire across Dubai and the UAE, often including relocation support at project end – making rental a financially practical option for projects under 18 months in duration.

    Where can I see completed labour camp projects in Dubai?

    Reviewing a supplier’s delivered project portfolio – covering different camp sizes, cabin types, and site conditions – gives you a reliable sense of what to expect in terms of quality, configuration, and delivery consistency before requesting a formal quote.

    How do I get a quote for a labour camp cabin in Dubai?

    The most efficient approach is to prepare a specification sheet – worker count, project duration, site location, insulation grade required, and any free zone authority requirements – and submit it to at least three suppliers simultaneously. For projects with specific configuration needs or tight timelines, requesting a direct consultation with an experienced UAE prefab supplier is the fastest route from specification to a compliant, budgeted proposal.



  • Toilet Cabin Supplier in Dubai: Types, Sizes and Pricing Guide (2026)

    Toilet Cabin Supplier in Dubai: Types, Sizes and Pricing Guide (2026)

    Finding a reliable toilet cabin supplier in Dubai means choosing between GRP portables, prefab sandwich panel units, container toilet blocks, VIP cabins, and combo welfare units. Prices range from AED 3,000 for a basic portable unit to AED 200,000+ for a fully fitted 40ft container toilet complex. All toilet cabins on Dubai construction sites and UAE labor camps must comply with MOHRE Ministerial Resolution No. 44 of 2022 and Dubai Municipality temporary structure guidelines.



    At a Glance: Toilet Cabin Types and Starting Prices in Dubai

    Toilet Cabin Types and Starting Prices in Dubai

    Why Choosing the Right Toilet Cabin Supplier in Dubai Matters

    Dubai’s construction sector never stops. Behind every rising tower, every infrastructure project, and every large outdoor event, thousands of workers and visitors need clean, safe, and legally compliant sanitation. The UAE’s construction market consistently ranks among the most active in the GCC – and proper site sanitation is not an optional extra. It is a legal obligation enforced by MOHRE, Dubai Municipality, Trakhees, and free zone authorities across all seven emirates.

    Getting this wrong is expensive. Companies that fail to provide compliant portable toilet cabins in Dubai face:

    • Inspection shutdowns that halt all active site work.
    • MOHRE fines that can run into tens of thousands of dirhams.
    • Labor camp deregistration – one of the most damaging outcomes for any contractor.
    • Project delays that cascade across the entire programme timeline.

    Equally, the UAE’s booming events sector drives enormous demand for portable sanitation solutions in Dubai. From Abu Dhabi Grand Prix corporate hospitality zones to high-end desert weddings and Dubai outdoor festivals, clean and well-designed sanitation is a commercial and logistical priority that organisers cannot afford to get wrong.

    This guide is written for:

    • Procurement officers managing labor camps and multi-site construction operations.
    • Construction contractors needing compliant site sanitation on fast-moving Dubai projects.
    • Event organisers sourcing temporary toilet solutions for outdoor venues.
    • Facility managers overseeing industrial site welfare for large workforces.

    What this guide covers:

    • Every toilet cabin type available from toilet cabin suppliers in Dubai and the UAE.
    • Exact sizes and technical specifications for each category.
    • Current 2026 pricing for both purchase and rental.
    • UAE legal compliance requirements that protect your project from risk.
    • How to evaluate and shortlist a verified portable toilet supplier in Dubai.
    • Hidden costs that experienced buyers plan for from day one.

    UAE Compliance and Legal Requirements for Toilet Cabins in Dubai

    MOHRE toilet ratio requirements UAE construction sites 2026

    Before reviewing any supplier catalog, understand what UAE law actually requires. This is the section most buyers skip – and the one that protects your project from surprise shutdowns and regulatory fines.

    MOHRE Ministerial Resolution No. 44 of 2022 – The Legal Baseline

    The primary legal framework governing worker sanitation in the UAE is MOHRE Ministerial Resolution No. 44 of 2022 Regarding Occupational Health and Safety and Labour Accommodation, reinforced by Administrative Decision No. 19 of 2023. This resolution applies to all establishments employing 50 or more workers earning AED 1,500 or less per month.

    Mandatory sanitation ratios under UAE law:

    • 1 toilet per 8 persons in all shared bathroom facilities.
    • A minimum of 2 toilets in every shared bathroom, regardless of occupancy count.
    • 1 urinal per 25 persons with a continuous and adequate flushing water supply.
    • 1 shower and 1 washbasin per 8 persons in all labor accommodation.
    • Hot and cold water must be available in every bathroom facility without exception.
    • Cleaning at least once per day using certified sterilization products is required by law.

    These are not recommendations. They are enforceable legal requirements. MOHRE confirmed that private sector companies registered and compliant in the Labour Accommodation System grew by over 1,000% between February 2022 and the end of 2023 – driven by intensified inspection campaigns and legal enforcement actions against non-compliant employers.

    Additional regulations that may apply depending on project scale:

    • Cabinet Resolution No. 13 of 2009 – General Standards for Collective Labour Housing.
    • Ministerial Decree No. 212 of 2014 – Standards for accommodations housing under 500 laborers.
    • Administrative Decision No. 19 of 2023 – Updated occupational safety and accommodation standards.

    Jurisdiction by Project Location in the UAE

    The approving authority changes depending on where your project is located. Getting this wrong means delays in the permit process and non-compliant installations.

    Project Location Approving Authority
    Standard Dubai construction site Dubai Municipality – Technical Department
    JAFZA, DAFZA, TECOM, Dubai Silicon Oasis Respective free zone authority
    Palm Jumeirah, Dubai Maritime City Trakhees (PCFC)
    Abu Dhabi projects Abu Dhabi DMT
    ADNOC oil and gas sites ADNOC HSE Department

    ISO Certifications to Verify Before Ordering

    For government, semi-government, or Tier 1 contractor supply chain procurement in Dubai, two ISO certifications form the non-negotiable baseline.

    • ISO 9001:2015 – Quality Management System: Confirms the supplier maintains an audited, documented production process. Without it, the supplier fails pre-qualification on most government tenders.
    • ISO 14001:2015 – Environmental Management System: Increasingly required for projects with sustainability specifications or waste management obligations.

    Before signing any supply agreement, check three things on every certificate:

    1. The issuing certification body – must be accredited by UKAS, DAkkS, or JAS-ANZ.
    2. The scope of certification – must explicitly cover the product category you are purchasing.
    3. The expiry date – an expired certificate is not evidence of quality; it is evidence the supplier stopped maintaining their quality system.

    Types of Toilet Cabins Available from Suppliers in Dubai

    Types of toilet cabins available in Dubai  - GRP, prefab, container, VIP

    Dubai’s market offers six distinct toilet cabin categories. Choosing the wrong type for your project results in non-compliance, unnecessary operational costs, or poor user conditions – all of which are avoidable with the right information before you order.

    GRP (Glass Reinforced Plastic) Portable Toilet Cabins

    GRP portable toilet cabin supplier Dubai  - fiberglass portable unit

    GRP portable toilets are the most widely used temporary sanitation units across Dubai and the UAE. Made from glass-reinforced plastic – a composite of woven glass fibers and polyester resin – these units are lightweight, UV-resistant, corrosion-proof, and moveable by two workers without mechanical lifting equipment.

    For a country where summer temperatures regularly exceed 45°C and the UV index reaches 10 to 12, material choice matters enormously. Steel rusts. Wood warps. Standard plastic degrades under sustained UV exposure. GRP does none of these – its UV-stabilised resin holds structural integrity and surface quality for five to eight years of UAE outdoor use with regular maintenance.

    Standard features inside every GRP portable toilet:

    • Built-in waste tank of 200–250 litres capacity.
    • Moulded anti-slip floor.
    • Ventilation louvres near the roofline.
    • Door latch with an occupied indicator.
    • Hand sanitiser dispenser holder.
    • Optional small washbasin with a separate fresh water tank in higher-specification models.

    GRP portable toilets are the right choice when:

    • Project duration is under six months.
    • The site is remote and crane access is not available.
    • Units need to be repositioned quickly between different site locations.
    • Budget is the primary constraint and specifications are basic.
    • The application is a one-off outdoor event, festival, or temporary survey camp.
    • Desert locations, oil field survey camps, or seasonal event venues are involved.

    Prefabricated Sandwich Panel Toilet Cabins

    Prefab sandwich panel toilet cabin Dubai construction site UAE

    Prefabricated sandwich panel toilet cabins are the standard specification for long-term construction sites across Dubai and the UAE. They cost more than GRP units, weigh significantly more, and require a forklift or crane to move. What they deliver in exchange is genuine thermal insulation, structural rigidity, split A/C compatibility, and the level of interior comfort that MOHRE welfare inspectors are actually looking for on site visits.

    The sandwich panel construction explained:

    • A rigid foam core – either EPS (expanded polystyrene) or PU (polyurethane foam) – is bonded between two metal skins of ACP or GI.
    • A 75mm PU-core panel is the minimum recommended specification for UAE outdoor installations running through summer.
    • It reduces interior temperatures by 15 to 20°C below outdoor ambient when paired with a correctly sized split A/C unit.

    Panel specification comparison for UAE conditions:

    • 50mm EPS core: Basic insulation. Suitable for indoor use, winter months, or units with frequent A/C cycling. Not recommended for direct UAE summer sun.
    • 75mm PU core: Superior thermal performance. The correct outdoor summer specification. Reduces A/C running costs through better heat retention throughout the unit’s service life.

    The structural chassis matters as much as the panel:

    • Hot-dip galvanised steel (85+ micron zinc coating): Essential for all UAE coastal and long-term outdoor placements. Provides cathodic protection even if the surface is scratched or abraded.
    • Epoxy-coated or painted chassis: Develops visible surface rust within 18 to 24 months in Abu Dhabi and Fujairah coastal environments. Not recommended for any unit with a planned service life beyond one year outdoors.

    Prefab sandwich panel units are the correct choice when:

    • Project duration is 12 months or longer.
    • MOHRE welfare compliance is being actively audited.
    • Workers use the facilities multiple times per shift.
    • The site has access to mains water supply and a reliable electrical connection.
    • Worker welfare standards are formally specified in the main contract documents.

    Prefab Sandwich Panel Unit – Key Specifications:

    Specification Detail
    Dimensions (L × W × H) Approx. 2.4m × 1.8m × 2.5m
    Floor Area Approx. 4.32 m²
    Weight 450–600 kg
    Wall Panel 50mm EPS or 75mm PU core (75mm recommended)
    Air Conditioning 1-ton split (12,000 BTU) standard
    Water Inlet ¾” BSP connection
    Waste Outlet 4″ (110mm) uPVC soil pipe
    Electrical 220V/50Hz, ELCB protected
    Mobility 3-tonne forklift or mobile crane
    Purchase Price Range AED 9,000 – AED 22,000

    Container Toilet Blocks (Modified Shipping Containers)

    Container toilet block supplier Dubai - 40ft modified container welfare unit UAE

    For large labor camps, industrial megaprojects, and permanent or semi-permanent sanitation infrastructure in Dubai and across the UAE, container toilet blocks are the industrial-grade solution. These are standard ISO shipping containers – 20ft (6.0m) or 40ft (12.0m) – fully stripped, reinforced where required, and fitted out as multi-compartment sanitation facilities with complete MEP (mechanical, electrical, and plumbing) installations.

    The structural shell is corten steel – an alloy that forms a stable, adherent surface layer actively protecting the steel underneath from further corrosion. This structural integrity means these units can be:

    • Crane-lifted to upper floors of Dubai high-rise construction buildings.
    • Stacked three-high in JAFZA or KIZAD industrial zones to maximise site footprint.
    • Transported anywhere in the UAE by standard flatbed truck.
    • Connected to municipal DEWA supply or operated as a self-contained tank system on remote sites.

    If you are managing a large construction project or labour camp accommodation across multiple UAE locations, container toilet blocks offer the most scalable and robust sanitation solution available.

    Configuration options by compartment count:

    • 4-unit (20ft): Four toilets, or two toilets and two showers.
    • 6-unit (20ft extended or 40ft): Four toilets, two showers, plus a urinal bay.
    • 8-unit (40ft): Four toilets, four showers, urinals, and a handwash bank.
    • 10 to 12-unit (40ft, full welfare): Toilets, showers, urinals, handwash stations, and a changing area with lockers.

    Water supply options for container blocks:

    • Municipal DEWA tie-in: For sites with established mains water supply infrastructure.
    • Self-contained tank system: 1,000–5,000 litre supply tank plus a matching waste holding tank – for remote desert sites, offshore locations, or temporary project phases without DEWA access.

    Container Toilet Block – Key Specifications:

    Container Toilet Block - Key Specifications:

    Executive and VIP Toilet Cabins in Dubai

    Executive VIP toilet cabin Dubai  - luxury portable toilet for events

    Not every toilet cabin serves a dusty construction site. For the Abu Dhabi Grand Prix, corporate product launches, luxury desert weddings, and high-profile outdoor festivals, the executive VIP toilet cabin is an entirely different product. It uses the same structural base as a standard prefab unit – but everything the user sees and touches is specified to a hospitality standard, not a site standard.

    Interior specifications of a properly fitted VIP toilet cabin:

    • Porcelain WC pan and cistern with quiet-close seat.
    • Ceramic or stone-finish vanity washbasin with chrome mixer tap.
    • Full-length or backlit vanity mirror.
    • High-quality vinyl or ceramic tile flooring.
    • Recessed LED lighting at 300+ lux – the difference between feeling like a hotel bathroom and a construction office.
    • Automatic air freshener dispenser on a timed-release cycle.
    • Individual split A/C unit with a separate thermostat control.
    • Coat hooks, stainless steel toilet roll holder, and paper towel dispenser.
    • Exterior in powder-coated aluminium cladding or premium composite panel.
    • Optional branded exterior with vinyl wrap or digitally printed panels for corporate events.

    The rental model dominates this category for good reason:

    • Most organisations in Dubai rent rather than purchase VIP toilet cabins.
    • Daily rental rates run from AED 800 to AED 3,000 per unit depending on specification and service package.
    • Full-service rental packages typically include fresh water delivery, waste removal, and an on-site attendant option.
    • For organisations running multiple events per year, purchase becomes financially justified after two to three years of regular use.

    Executive VIP Toilet Cabin – Key Specifications:

    Executive VIP Toilet Cabin - Key Specifications:

    Combo Cabin Units – Toilet, Shower, Washbasin, and Changing Room

    Combo toilet shower welfare cabin UAE - MOHRE compliant sanitation unit Dubai

    The combo cabin is the most complete single-structure sanitation solution available in Dubai and the UAE. Rather than separate toilet blocks, shower units, and changing facilities, a combo unit integrates all functions into one modular structure on a single base chassis. This simplifies site logistics, reduces the number of units to install and maintain, and meets MOHRE’s multi-function welfare requirements within a single deliverable.

    Standard configurations available from Dubai suppliers:

    1. T+S – Toilet and Shower: Entry-level welfare unit. Two compartments in one structure. Suitable for smaller sites with lower daily worker counts.
    2. T+S+W – Toilet, Shower, and Washbasin: The standard MOHRE-compliant configuration. Three functions in one structure. This is the baseline specification for labor camp procurement across the UAE.
    3. T+S+W+C – Full Welfare Unit with Changing Room: Complete package including toilet, shower, washbasin, and a separate changing area with bench seating and lockers. Commonly specified on ALDAR, EMAAR, and DEWA contractor camp projects.

    Accessibility requirements – a detail most buyers overlook:

    Federal Law No. 29 of 2006 (UAE legislation for People of Determination) requires accessible facilities in public and semi-public spaces. For government-specified projects, toilet cabin units must meet:

    • Minimum 0.9m clear door width for wheelchair access.
    • Horizontal grab rails at the WC and shower positions.
    • Slip-resistant floor finish throughout.
    • Lower basin height for seated users.
    • Level or ramped entry with no threshold step.

    Partition material options – quality differences that matter:

    • PVC honeycomb partitions: Lowest cost. Degrade in UAE heat and sustained moisture. Not recommended for service life beyond 12 months.
    • Aluminium-frame with GRP or HPL infill: The industry standard for construction site welfare use. Resistant to heat, moisture, and cleaning chemicals.
    • Full GRP moulded partitions: Maximum durability and hygiene. Easiest to clean. Best option for high-use facilities serving 30 or more people per day.

    Combo Cabin (T+S+W) – Key Specifications:

    Specification Detail
    Dimensions (L × W × H) Approx. 2.4m × 3.6m × 2.5m
    Air Conditioning Split unit per compartment zone
    Hot Water Supply 10L or 20L electric in-line heater
    Waste Outlet 4″ (110mm) uPVC soil pipe
    Partition Standard Aluminium frame with GRP or HPL infill
    Purchase Price Range AED 14,000 – AED 45,000

    Standalone Urinal Blocks

    Standalone urinal blocks are the most cost-effective supplement to any toilet cabin in Dubai for high-traffic, male-dominated construction sites and industrial projects. The operational case is straightforward.

    During peak-hour breaks on a large construction site, the majority of male workers need urinal access only. Directing that traffic to a dedicated urinal unit achieves three practical outcomes simultaneously:

    1. It reduces queuing and congestion at full toilet cabin entrances during break periods.
    2. It keeps toilet compartments cleaner for longer by reducing unnecessary use.
    3. It effectively increases total sanitation capacity without the cost of additional full toilet units.

    The waterless urinal option is gaining real traction in the UAE for two reasons:

    • It eliminates the water supply connection requirement entirely – ideal for remote sites without DEWA access.
    • For Abu Dhabi projects targeting Estidama Pearl credits under the Water Use Reduction category (W-1), specifying waterless urinals is a verified and documented credit contribution pathway.

    Urinal Block – Key Specifications:

    Specification Detail
    Available Configurations 2-bay, 4-bay, 6-bay
    Construction Material GRP or sandwich panel
    Flushing Options Manual flush or waterless cartridge seal
    Purchase Price Range AED 2,500 – AED 12,000

    Complete Toilet Cabin Type Comparison – Dubai

    Type A/C Best Use Case Price Range (AED) Mobility
    GRP Portable No Short-term sites, events 3,000 – 8,000 High (manual)
    Prefab Sandwich Panel Yes Long-term projects 9,000 – 22,000 Medium (forklift)
    Container Toilet Block Ducted Labor camps, mega-sites 30,000 – 200,000+ Low (crane)
    Executive VIP Yes Events, corporate 18,000 – 55,000 Medium
    Combo Cabin (T+S+W) Yes MOHRE welfare compliance 14,000 – 45,000 Medium
    Urinal Block No High-traffic male sites 2,500 – 12,000 High

    Standard Toilet Cabin Sizes and Technical Specifications

    Toilet cabin sizes Dubai  - dimension guide GRP prefab container

    Knowing the type you need is half the job. Having the exact dimensions, weights, and technical specifications before you contact a toilet cabin supplier in Dubai prevents delivery-day surprises, incorrect crane bookings, and permit application rejections.

    Dimension Reference by Unit Type

    Unit Type L × W × H (metres) Floor Area Weight A/C
    Single GRP Portable 1.2 × 1.2 × 2.3 1.44 m² 90–120 kg None
    Compact Prefab Single 2.4 × 1.8 × 2.5 4.32 m² 450–600 kg 1T split
    Twin Modular Unit 3.6 × 2.4 × 2.5 8.64 m² 900–1,200 kg 1.5T split
    4-Room Prefab Block 6.0 × 2.4 × 2.6 14.4 m² 2,000–2,500 kg Ducted 2T
    20ft Container Block 6.0 × 2.4 × 2.6 14.4 m² 3,500–4,500 kg Ducted 2T
    40ft Container Block 12.0 × 2.4 × 2.6 28.8 m² 6,000–8,500 kg Ducted 3–5T

    Material Specifications and UAE Climate Suitability

    Wall Panels – The Most Commonly Mis-Specified Component

    The wrong panel specification is one of the most common and costly procurement mistakes for prefab toilet cabins in Dubai. Three options dominate the UAE market:

    • 50mm EPS core panel: Basic insulation. Acceptable for indoor use, winter months, or units with frequent A/C cycling. Not recommended for direct UAE summer outdoor exposure.
    • 75mm PU-core sandwich panel: The minimum recommended specification for any outdoor installation running through UAE summer (May–September). Delivers 15–20°C interior temperature reduction below outdoor ambient when paired with a correctly sized A/C unit.
    • ACP (Aluminium Composite Panel) alone: Lightweight and clean-looking but has poor standalone thermal resistance. Only suitable as a cladding layer over a separately insulated structure – not as a primary wall for an A/C unit in direct Dubai sun.

    Steel Base Chassis – Why Galvanising Grade Matters

    • Hot-dip galvanised (85+ micron zinc coating): The correct specification for all UAE coastal and long-term outdoor placements. Provides cathodic protection – even scratched or abraded surfaces continue to be protected.
    • Epoxy-coated or painted chassis: Develops visible surface rust within 18 to 24 months in Abu Dhabi and Fujairah coastal environments. Not recommended for units with a planned service life beyond one year outdoors.

    Flooring – Practical vs. Premium

    • Anti-slip FRP grating: Best practical choice for construction site toilet cabins. Water drains through, mould growth is minimal, and cleaning is straightforward with a pressure washer.
    • Ceramic tile: Specified for VIP units and higher-specification welfare blocks. Requires more maintenance and can crack if the base chassis flexes during transport.

    Plumbing and Electrical Compliance Standards

    Plumbing (UAE Standard Specification):

    • Water inlet: ¾” BSP male thread – compatible with standard UAE site supply fittings. Always add an inline ball valve and pressure regulator (maximum 3 bar).
    • Hot water supply: 10L or 20L electric in-line heater. Hot and cold water in all bathrooms is a legal MOHRE requirement, not an optional upgrade.
    • Cold water pipe: uPVC, rated for operating pressure.
    • Hot water pipe: CPVC (chlorinated PVC), rated to 93°C for continuous service.
    • Waste outlet: 4″ (110mm) uPVC push-fit soil pipe with a minimum 1:80 fall on all horizontal runs.

    Electrical (UAE Compliance):

    • Supply voltage: 220V/50Hz single phase – standard UAE residential and light commercial grid.
    • Protection: ELCB (Earth Leakage Circuit Breaker) – mandatory for all wet-area electrical installations under DEWA wiring regulations.
    • Lighting: LED, minimum 200 lux at work surface height – the Dubai Municipality minimum for enclosed occupied spaces.
    • Ventilation: 6-inch axial exhaust fan, minimum 100 CFM extraction rate for effective odour control.
    • A/C unit: For government and semi-government projects, only DEWA-approved energy-rated units (minimum 2-star rating) are accepted during inspections.

    Toilet Cabin Prices in Dubai: Full 2026 Pricing Guide

    Toilet cabin price guide Dubai  2026 - AED pricing for portable and prefab units

    The price range for toilet cabins in Dubai is wide enough to cover both a basic construction site requirement and a luxury event installation. Understanding what moves prices within each category protects you from overpaying and helps you build an accurate budget from project day one.

    Purchase Price Guide by Unit Type (2026)

    Toilet Cabin Type Unit Description Price Range (AED) Primary Cost Driver
    Basic GRP Single No A/C, built-in tank 3,000 – 8,000 Material grade, tank size
    Standard Prefab Single 2.4×1.8m, split A/C 9,000 – 13,000 Panel type, A/C brand
    Prefab Twin Unit 2-room, A/C 14,000 – 22,000 Configuration, finish
    Executive VIP Single Premium interiors, A/C 18,000 – 55,000 Fixture quality, cladding
    Combo Cabin (T+S+W) 3-function welfare unit 20,000 – 45,000 Configuration, spec
    20ft Container Block 4–6 compartments 30,000 – 85,000 Compartment count, water system
    40ft Container Block 8–12 compartments 70,000 – 200,000 MEP, compartment count, finish
    Custom Multi-Container Bespoke welfare complex 200,000+ Fully project-specific

    Rental Price Guide for Toilet Cabins in Dubai (2026)

    Type Daily Rate (AED) Monthly Rate (AED) Typically Includes
    Basic GRP Portable 80–150 300–600 Delivery, scheduled pump-out
    Standard Prefab + A/C 200–400 2,000–4,500 Delivery and installation
    Executive VIP Cabin 800–3,000 Event-based pricing Full service, attendant option
    Container Block (20ft) 500–1,200 5,000–15,000 Delivery, site setup
    Container Block (40ft) 1,000–2,500 10,000–25,000 Delivery, MEP connection

    💡 Pro Tip: Bulk rental discounts of 10 to 20% are standard from most established Dubai suppliers for orders of 10 or more units, or for agreements of six months or longer. This is a negotiable line item – always ask before accepting the opening quoted rate.

    7 Factors That Drive Toilet Cabin Prices Up in Dubai

    1. Customisation level: Custom RAL colour, vinyl logo wrap, or digitally printed panels add AED 500–AED 3,000 per unit plus one to two weeks of additional production time.
    2. Panel and insulation grade: Upgrading from 50mm EPS to 75mm PU core adds 15–25% to the base unit price – a worthwhile investment for any UAE summer outdoor placement.
    3. Delivery location surcharge: Remote sites in Fujairah, Hatta, Ras Al Khaimah mountains, or offshore locations add AED 1,000–AED 5,000 above standard Dubai delivery rates.
    4. Water system type: A self-contained tank system adds AED 2,000–AED 8,000 versus a simple mains connection stub. Essential for remote sites – unnecessary for sites with established DEWA water supply.
    5. Urgency premium: Orders needed within two weeks typically carry a 10–15% price premium over standard three-to-six-week production lead times.
    6. Import vs. local manufacture: Locally manufactured units from UAE-based producers are typically 15–25% less expensive than equivalent imported units due to the absence of customs duty and shorter lead times.
    7. Container fit-out level: The gap between a basic 20ft container shell (AED 30,000) and a fully MEP-fitted, tiled welfare block (AED 85,000) is entirely the fit-out specification. Always request itemised quotes.

    Hidden Costs That First-Time Buyers Consistently Miss

    Every experienced procurement manager in the UAE’s construction sector has encountered these costs unexpectedly. Budget for all of them from project day one.

    Hidden Cost Item Estimated Cost (AED) Key Detail
    Dubai Municipality Temporary Structure Permit 500 – 2,000 Required for installations over 6 months or 20 m². Allow 2–4 weeks.
    DEWA Temporary Water Meter Connection 1,000 – 3,500 Apply minimum 3 weeks in advance. Not flexible.
    Ground preparation / concrete pad 800 – 8,000 Varies by unit type. Even GRP gravel beds carry a real cost.
    Septic tank pump-out contract (annual) 7,800 – 20,800 per unit AED 150–400 per weekly visit for a GRP unit serving 15–20 workers.
    Summer A/C servicing 150 – 300 per service call Required every 4–6 weeks in UAE summer for outdoor units.
    End-of-project removal and transport 3,000 – 10,000 Crane hire plus transport for container blocks. Factor in before buying.
    Warranty activation Varies Some suppliers require written registration within 30 days of delivery.

    How to Choose a Toilet Cabin Supplier in Dubai

    How to choose toilet cabin supplier Dubai - procurement checklist UAE

    Choosing the right toilet cabin supplier in Dubai is as important as choosing the right unit type. A supplier with wrong certifications, no local service capability, or no verified track record creates problems that surface months into a project – not on the day the order is placed.

    Step Supplier Evaluation Process

    Verify the UAE Trade License.

    • Every legitimate business in Dubai must hold a current trade license issued by Dubai Economy and Tourism (DET) or the relevant free zone authority (JAFZA, DMCC, DAFZA, etc.).
    • Verification takes under five minutes on the DED Smart App or the Dubai REST platform.
    • Any supplier reluctant to provide their trade license number should be removed from your shortlist immediately.

    Confirm Local Manufacturing or Import Capability.

    • Ask directly: do you manufacture locally in the UAE, or import units?
    • Local manufacturers can show a physical production facility and maintain local spare parts inventory.
    • Import-only suppliers can still be reputable, but you need documented confirmation of UAE-based after-sales support – not a contact number that redirects internationally.

    Authenticate ISO Certificates.

    • Request the certificate physically or digitally.
    • Check the issuing certification body (must be UKAS, DAkkS, or JAS-ANZ accredited).
    • Confirm the scope of certification explicitly covers your product category.
    • Check the expiry date – an expired certificate is not quality evidence.

    Request and Contact Project References.

    • Ask for a minimum of three reference contacts from comparable UAE projects.
    • Contact at least one by phone – a three-minute conversation reveals more than any written testimonial.
    • Ask references specifically about after-sales response, maintenance reliability, and delivery accuracy.

    Confirm After-Sales Geographic Coverage.

    • Ask which emirates the supplier’s service technicians are based in.
    • Ask the guaranteed response time for emergency breakdown calls.
    • A team based exclusively in Sharjah’s industrial area is not positioned to respond quickly to a breakdown in a Fujairah labor camp or an Al Ain project.

    Supplier Pre-Qualification Checklist

    Use this checklist before placing any order with a portable toilet supplier in Dubai:

    • UAE trade license verified on the DET portal, JAFZA, or the relevant free zone platform.
    • Physical production facility or established import documentation confirmed.
    • ISO 9001:2015 certificate verified – issuing body, scope, and expiry date checked.
    • Minimum three UAE project references provided, and at least one contacted by phone.
    • After-sales service network confirmed for your project’s specific emirate.
    • Local spare parts stock confirmed – A/C units, wall panels, plumbing components.
    • Warranty terms documented – coverage scope, duration, and transport responsibility for claims.
    • Municipality-compliant technical drawings available for permit submission.
    • Payment terms negotiated – milestone-based payments available for large orders.
    • Emergency breakdown response time documented in writing for any service contract.

    10 Questions to Ask Your Supplier Before Ordering

    1. Can you provide your UAE trade license number and current ISO certificates for verification?
    2. Do you manufacture locally in the UAE, or are units imported – and what is the confirmed lead time?
    3. Can you produce municipality-compliant technical drawings (plan and elevation) for our permit application?
    4. What exactly does your warranty cover – structural integrity, mechanical components, A/C – and what are the terms and duration?
    5. Do you have service technicians based in our project’s emirate, and what is your documented response time for emergency breakdowns?
    6. Are spare parts – A/C units, wall panels, plumbing fittings – stocked locally and available for immediate dispatch?
    7. What volume discount applies to our order quantity, and what is the qualifying threshold?
    8. Can you provide three UAE project references from comparable projects completed in the past 24 months?
    9. Is waste pump-out included in rental packages, and is it carried out by a Dubai Municipality-licensed waste carrier?
    10. Who arranges and bears the full cost of unit removal and transport at the end of the rental or project period?

    Buy vs. Rent: The Financial Decision Framework for Dubai

    Buy or rent toilet cabin Dubai  - cost comparison guide 2026

    The buy-versus-rent decision for toilet cabins in Dubai has no universal answer. It depends entirely on project duration, available capital, the number of units required, site access, and what happens to the units when the project ends.

    When Buying Makes More Financial Sense

    The core calculation is direct. If the total rental cost over the project duration exceeds the purchase price, buying is the better financial decision – provided you have a productive use for the unit afterwards, or can resell it into the UAE used cabin market.

    Break-Even Analysis: Purchase vs. Monthly Rental

    Unit Type Purchase Price (AED) Monthly Rental (AED) Break-Even Point
    GRP Portable Single 5,000 450 Approx. 11 months
    Prefab Single (with A/C) 11,000 2,500 Approx. 4.4 months
    Container Block (20ft) 55,000 8,000 Approx. 6.9 months

    For a standard prefab sandwich panel unit – the most common purchase in the UAE market – the break-even against monthly rental is under five months. Any project running longer favours buying.

    Additional reasons to purchase rather than rent:

    • Your organisation manages multiple simultaneous project sites – owned units transfer between sites at zero additional supply cost.
    • Multi-year labor camp contracts make ownership the obvious financial choice.
    • Well-maintained prefab toilet cabins retain 40 to 60% of purchase value after three years in the UAE used cabin market.
    • UAE Corporate Tax (effective June 2023) treats capital asset purchases differently from operational rental expenditure – confirm the most favourable treatment with your finance team.

    When Renting Is the Smarter Choice

    Renting wins clearly in three specific scenarios:

    • Short project duration: Any project under 12 months, or a one-time event. The break-even table above makes this unambiguous.
    • Remote site with high transport cost: If end-of-project removal and transport costs rival the rental premium paid over the project duration, renting eliminates the exit cost problem entirely.
    • Working capital constraints: For smaller contractors, preserving AED 11,000 in capital versus paying AED 2,500 monthly is a real operational decision – renting frees cash for materials, plant, and direct site costs.

    Lease-to-Own: A Growing Option in Dubai

    A growing number of UAE toilet cabin suppliers now offer lease-to-own arrangements – structured monthly payments over 24 to 36 months, with full ownership transferring at the end of the payment period. This suits SME contractors who cannot absorb a large upfront capital purchase but recognise that indefinite renting beyond a certain project duration is economically wasteful.

    Key points to negotiate in any lease-to-own agreement:

    • Maintenance responsibility during the lease period – insist this stays with the supplier until ownership formally transfers.
    • Early buyout option – ask what the price is relative to the remaining payment balance.
    • Warranty transfer – confirm the manufacturer’s warranty transfers in full to the buyer on completion of the lease.
    • Damage liability – clarify how repair costs during the lease period are shared between parties.

    Installation, Maintenance, and Waste Management in the UAE

    Toilet cabin installation Dubai  - crane placement on construction site

    Sourcing the right unit at the right price is the first part of the task. How you install it, maintain it through UAE’s extreme climate, and manage the resulting waste determines whether the investment delivers real compliance and functionality across the entire project.

    Step-by-Step Toilet Cabin Installation Guide

    Site Survey and Ground Preparation

    Identify the optimal placement location before ordering – not on delivery day.

    Location selection criteria:

    • Within 100 metres of the primary work area, per MOHRE site welfare guidance.
    • Accessible to pump-out trucks without obstructing active site operations or traffic.
    • Shaded or covered where possible – shade placement alone reduces interior A/C load by 20–30% in UAE summer.
    • On ground that can be properly prepared to the correct specification for the unit type.

    Ground preparation requirements by unit type:

    • GRP units: 100mm compacted gravel bed using 20mm aggregate, levelled to ±20mm.
    • Prefab sandwich panel units: 150mm reinforced concrete pad (C25 mix) is ideal. Compacted hardcore with a steel distribution frame is acceptable for placements under 12 months.
    • Container toilet blocks: Engineered reinforced concrete pad required. Corner loads on a loaded 40ft block can exceed 5 tonnes per corner – do not place on unverified or uncompacted ground.

    Utility Connection Planning

    • Map the water supply route before the unit arrives on site.
    • Submit the DEWA temporary water meter application at least three weeks in advance – this timeline cannot be expedited.
    • Determine whether you are connecting to the site sewage network or operating with a holding tank – this drives all soil pipe routing and pump-out logistics.

    Unit Placement

    • GRP units: Two workers or a small site telehandler.
    • Prefab units: 3-tonne rated forklift using the base chassis forklift pockets, or a mobile crane for upper-floor placement.
    • Container blocks: Mobile crane – minimum 25-tonne capacity for 20ft units; 50-tonne capacity for fully fitted 40ft blocks.

    Connection and Commissioning

    Follow this sequence on every toilet cabin installation:

    1. Connect water inlet with ball valve stopcock and pressure regulator. Check all joints for leaks before proceeding.
    2. Connect waste outlet to the soil stack or holding tank. Confirm minimum 1:80 fall on all horizontal pipe runs.
    3. Install and commission the A/C unit. Check refrigerant charge, test thermostat, and confirm condensate drainage clears the unit exterior.
    4. Test ELCB by pressing the trip button – it must cut power immediately. Reset and retest before energising any other circuit.
    5. Run water through all basins and flush all WC pans a minimum of three times before handing the unit over to users.

    Compliance Documentation

    • Submit the as-built drawing to Dubai Municipality or the relevant authority for any installation requiring a permit.
    • Keep the pump-out contractor’s current Dubai Municipality waste carrier license on site at all times.
    • MOHRE inspectors and municipality auditors request this documentation during unannounced site visits.

    UAE Maintenance Schedule for Toilet Cabins

    UAE conditions impose maintenance demands significantly more intensive than any temperate climate. Dust, sand, extreme heat, UV radiation, and coastal humidity age equipment faster than standard manufacturer guidance assumes.

    Maintenance Task Frequency Why Critical in UAE
    A/C filter cleaning Every 4–6 weeks (May–Sept); every 6–8 weeks (Oct–Apr) Construction dust clogs filters within weeks, reducing cooling efficiency by 30–40%.
    GRP waste tank pump-out Weekly (for units serving 15–20 workers) 45°C summer heat dramatically accelerates bacterial growth and odour development.
    Panel and roof joint inspection Quarterly UAE thermal cycling causes sealant cracking at panel joints, roof edges, and penetrations.
    Plumbing joint inspection Monthly Repeated temperature swings cause expansion and contraction at all pipe joints.
    Anti-slip floor surface check Every 6 months Sand and water traffic erodes non-slip texture – a slip hazard and a legal liability.
    ELCB trip test Monthly Moisture ingress in coastal UAE locations degrades ELCB sensitivity over time.
    Pest control treatment Quarterly UAE climate and waste proximity attract insects – quarterly treatment maintains hygiene compliance.
    Chassis and panel rust inspection Annually Even galvanised frames develop rust at cut edges. Treat with zinc-rich primer immediately.

    Waste Management Compliance in Dubai

    Waste disposal from toilet cabins in Dubai is a legally regulated activity – not a matter of site discretion or convenience.

    What UAE environmental law requires:

    • Illegal discharge penalty: Discharging waste onto site ground, into drainage channels, or any watercourse carries fines of AED 5,000 to AED 50,000 – plus potential criminal liability for the responsible site manager.
    • Licensed waste carriers only: Your pump-out contractor must hold a current Dubai Municipality waste carrier license. Verify this on the Dubai REST platform before engagement.
    • Pump-out manifests: Every visit must be documented with a service receipt recording volume collected, date, and disposal facility used. Keep all manifests on site for the duration of the project.
    • Pump-out frequency: A single GRP unit serving 15–20 workers requires a pump-out approximately once per week. Adjust frequency with your contractor based on actual usage data.
    • Hot water mandatory: MOHRE standards require hot and cold water in all bathroom facilities. Install an electric in-line water heater at installation – not after the first inspection flags its absence.

    Sustainable and Eco-Friendly Toilet Cabin Options in Dubai

    Solar powered toilet cabin Dubai  - eco-friendly portable sanitation

    Sustainability is no longer a peripheral item on UAE project agendas. The country’s Net Zero by 2050 Strategic Initiative, Abu Dhabi’s Estidama Pearl Rating System, and growing LEED requirements are pushing the entire construction supply chain – including temporary welfare facilities – toward measurable, environmentally responsible choices.

    Solar-Powered Toilet Cabins

    Solar-powered toilet cabin units are gaining real operational traction on remote construction sites, eco-tourism developments, and projects in the Emirates’ outer regions where generator connection is the only conventional alternative.

    How a solar toilet cabin system works:

    • A 200–400W rooftop solar panel array collects energy during daylight hours.
    • A 100–150Ah lithium or AGM battery bank stores energy for nighttime and overcast conditions.
    • The system powers LED lighting, a 6-inch exhaust fan, a USB charging point, and a small water circulation pump.
    • Generator fuel costs for basic cabin functions are eliminated entirely.

    Why the UAE is ideal for solar cabin installations:

    • Dubai averages over 300 sunny days per year.
    • UAE Global Horizontal Irradiance (GHI): 2,100–2,300 kWh/m² annually – among the highest in the world.
    • Payback period on a solar fit-out (AED 3,000–AED 8,000 additional cost) against generator fuel savings: typically 12 to 18 months under UAE operating conditions.

    Waterless Toilet Systems

    Waterless urinals use a cartridge-based oil-trap seal to prevent odours without any flushing water. Each cartridge handles approximately 7,000 uses before replacement at AED 40–AED 80.

    The water saving case for a 10-bay urinal block over 12 months:

    • Daily water saving vs. 3L low-flush urinal: 600 litres per bay per day.
    • Monthly saving per bay: approx. 18,000 litres.
    • Annual saving for a 10-bay block: approximately 2.16 million litres.

    For Abu Dhabi projects targeting Estidama Pearl credits under the Water Use Reduction category (W-1), specifying waterless urinals is a verified and accepted credit contribution pathway.

    Practical Sustainability Steps for UAE Projects

    • Specify 3L/6L dual-flush cisterns instead of 9L single-flush – reduces water consumption without affecting user experience.
    • Specify solar lighting and ventilation on any unit within cable distance of a panel installation.
    • Specify waterless urinals for all male welfare units where water is metered or supply is constrained.
    • Select the highest available energy star rating on all A/C units – mandatory for government projects, best practice for all others.
    • Maintain pump-out manifests as part of project waste documentation – this data feeds into Environmental Management Plans submitted to Dubai Municipality or Abu Dhabi DMT.

    Frequently Asked Questions About Toilet Cabins in Dubai

    Toilet cabin supplier Dubai FAQ - frequently asked questions portable toilet UAE

    What is a toilet cabin?

    A toilet cabin is a prefabricated, self-contained sanitation unit designed for temporary or semi-permanent installation on construction sites, labor camps, events, and remote locations. In Dubai and the UAE, toilet cabins range from basic GRP portable units to fully fitted prefab welfare blocks and executive VIP cabins – all built to withstand extreme UAE climate conditions and meet MOHRE hygiene standards.

    How much does a portable toilet cabin cost in Dubai?

    Portable toilet cabin prices in Dubai range from AED 3,000 for a basic GRP single unit to AED 200,000 or more for a fully fitted 40ft container toilet block. Standard prefab single units with A/C cost between AED 9,000 and AED 13,000. Monthly rental rates start from AED 300–AED 600 for basic units and reach AED 10,000–AED 25,000 per month for large container blocks.

    What are the types of portable toilets available in Dubai?

    The main types of portable toilet cabins in Dubai are:

    • GRP portable toilets – lightweight, self-contained, ideal for short-term use and events.
    • Prefab sandwich panel cabins – insulated, A/C-equipped, for long-term construction sites.
    • Container toilet blocks – multi-compartment units for labor camps and mega-projects.
    • Executive VIP cabins – premium interiors for corporate events and weddings.
    • Combo welfare units – toilet, shower, and washbasin in one structure for MOHRE compliance.
    • Standalone urinal blocks – cost-effective supplement for high-traffic male sites.

    How many toilets are required per worker on UAE construction sites?

    Under MOHRE Ministerial Resolution No. 44 of 2022, the required ratios for shared labor accommodation are:

    • 1 toilet per 8 persons (minimum 2 toilets per shared bathroom).
    • 1 urinal per 25 persons.
    • 1 shower and 1 washbasin per 8 persons.
    • Hot and cold water in all facilities without exception.

    These ratios are legally enforceable and are checked during MOHRE inspections.

    Can I rent a toilet cabin in Dubai?

    Yes. Toilet cabin rental in Dubai is widely available for construction sites, events, and short-term projects. Monthly rental rates range from AED 300–AED 600 for basic GRP units to AED 10,000–AED 25,000 per month for large container toilet blocks. Most suppliers offer volume discounts of 10–20% for orders of 10 or more units or agreements of six months or longer.

    What permits do I need to install a toilet cabin in Dubai?

    • Installations under 6 months and under 20 m² floor area: Usually covered under the main site permit.
    • Installations over 6 months or over 20 m²: A temporary structure NOC from Dubai Municipality is required.
    • Mains water connection: A DEWA temporary water meter permit is required – allow at least three weeks for processing.
    • Free zone projects (JAFZA, DAFZA, TECOM): Free zone authority approval replaces Dubai Municipality clearance.

    What is the difference between a GRP and a prefab sandwich panel toilet cabin?

    GRP toilet cabin:

    • Moulded fiberglass unit, weighing 80–120 kg.
    • Built-in 200–250 litre waste tank – no external plumbing required.
    • Can be moved manually. No A/C connection.
    • Designed for short-term, temporary use.

    Prefab sandwich panel toilet cabin:

    • Steel-framed, insulated structure with external plumbing and split A/C.
    • Weighs 450–600 kg – requires a forklift or crane to reposition.
    • Designed for long-term, climate-controlled, MOHRE-compliant use.

    In short: GRP is portable and budget-appropriate. Prefab sandwich panel is compliance-grade and built for the long haul.

    Is it better to buy or rent a toilet cabin in Dubai?

    • Buy if your project runs longer than five months – the break-even for a standard A/C prefab unit is approximately 4.4 months at typical Dubai rental rates.
    • Rent for events, projects under 12 months, or remote sites with high end-of-project transport costs.
    • Consider a lease-to-own arrangement if capital expenditure is constrained but long-term ownership makes financial sense.

    Conclusion: Choosing the Right Toilet Cabin Supplier in Dubai

    The right toilet cabin supplier in Dubai decision comes down to matching four variables: project duration, daily user count, site location and utility access, and compliance requirements. Get those four variables right, and the product type follows logically.

    A practical summary of when to use each type:

    • GRP portables → Short-term sites and events. Economical, flexible, fast to deploy.
    • Prefab sandwich panel units with A/C → Any project running beyond six months in UAE outdoor conditions. Compliance-grade, comfortable, financially justified within five months against the rental alternative.
    • Container toilet blocks → Large labor camps, industrial zones, and megaprojects. The right solution when sanitation infrastructure needs to scale to hundreds or thousands of daily users.
    • Executive VIP units → Events and corporate settings where user experience matters. Almost always better rented than purchased.
    • Combo welfare units → MOHRE-compliant multi-function delivery within a single, relocatable structure.
    • Standalone urinal blocks → High-traffic sites where congestion management and sustainability metrics both matter.

    <b>Before committing to any purchase or rental agreement:

    • Get the MOHRE and Dubai Municipality compliance requirements confirmed in writing from your HSE manager.
    • Budget for all hidden costs – permits, ground preparation, water meter connections, pump-out contracts, and summer A/C servicing – from day one.
    • Request fully itemised quotes from a minimum of three verified suppliers.
    • Complete the supplier pre-qualification checklist in this guide before signing any agreement.

    For procurement teams managing large-scale projects in the UAE, toilet cabins rarely exist in isolation. Many sites need an integrated approach across multiple infrastructure requirements. If you are exploring prefab modular toilet solutions alongside broader site welfare planning – including full labour camp accommodation setups and double-storey container structures – working with a supplier who understands the full scope of modular site infrastructure makes procurement significantly more efficient. You can explore the full range of prefab cabin products or get in touch directly to discuss your project requirements.

    Toilet cabins are not an afterthought on any UAE project. In a market where MOHRE compliance is actively enforced, worker welfare is a legal priority, and project managers are held directly accountable for sanitation failures, getting this right from the start matters as much as any other piece of site infrastructure – and the cost of getting it wrong is always higher than the cost of getting it right.



  • Best Portacabin Suppliers for ADNOC Projects in Dubai | 2026 Buyer’s Guide

    Each of these companies supplies ADNOC-compliant, high-durability portacabin units built for oilfield, industrial, and construction site environments across Dubai and the wider UAE. They meet ADNOC’s strict HSE framework requirements, deliver within demanding project timelines, and carry the compliance documentation that procurement teams and site managers need before a single unit crosses the site gate.

    ADNOC Portacabin

    Picture this. It is 47 degrees Celsius on a remote oilfield site outside Abu Dhabi. Your ADNOC subcontract was confirmed three days ago. The site mobilization checklist is sitting on your desk, and at the very top — before manpower, before equipment, before anything else — is a fully compliant, operational site office. You have 72 hours to deploy.

    You call a portacabin supplier found through a quick internet search. They promise everything. The unit arrives. It fails your ADNOC HSE site inspection on day one.

    This scenario is not a worst-case hypothetical. It plays out on UAE project sites with uncomfortable regularity. The portacabin market in Dubai is crowded with vendors. But suppliers who genuinely understand what ADNOC compliance requires — and who back that up with verified documentation — represent a much smaller group.

    Why Choosing the Wrong Supplier is Costly

    A non-compliant portacabin on an ADNOC project site can trigger all of the following:

    • Immediate HSE inspection failure and compulsory unit removal from site.
    • Project mobilization delays that cascade directly into contract milestone penalties.
    • Financial penalties for non-compliance with ADNOC’s site safety standards.
    • Reputational damage with the prime contractor and with ADNOC directly.
    • In serious cases, full suspension of subcontractor site access.

    The numbers reinforce the stakes. The UAE construction market is forecast to reach AED 189.59 billion in 2026 — a year-on-year growth of 6.2%. ADNOC’s oil and gas infrastructure pipeline alone includes the USD 15 billion Hail and Ghasha Sour Gas Development project. The pressure on procurement teams to make the right supplier decision has never been greater.

    WHAT IS AN ADNOC-COMPLIANT PORTACABIN?

    ADNOC Portacabin

    An ADNOC-compliant portacabin is a prefabricated, modular temporary structure that meets the Abu Dhabi National Oil Company’s technical, safety, and environmental standards for deployment on active oilfield, construction, or industrial project sites across the UAE. These units must satisfy ADNOC’s HSE framework requirements across five core areas:

    • Fire resistance ratings.
    • Extreme heat insulation performance.
    • Structural load tolerances.
    • Certified electrical installations.
    • Anti-corrosion specifications for coastal and desert environments.

    That sounds straightforward. In practice, the UAE portacabin market is filled with suppliers who use terms like “ADNOC-grade” or “ADNOC-standard” as marketing language rather than as a reflection of any verified compliance standing. Understanding what the standards actually demand — and the critical difference between a genuinely compliant supplier and one who simply claims to be — is the single most important thing a procurement officer must establish before shortlisting any vendor.

    ADNOC’s Five Core Technical Requirements Explained

    ADNOC’s site requirements for portacabins are tied to its broader HSE framework, which governs structural integrity, electrical safety, thermal performance, and environmental resistance. For a portacabin unit, these requirements translate into five critical specification areas:

    Fire Resistance.

    • Cabin panels must carry a minimum fire rating that complies with ADNOC’s site safety code.
    • Standard commercial portacabins do not automatically meet this threshold.
    • Suppliers must use fire-rated panel systems — typically mineral wool or rock wool core construction.
    • The overall unit must demonstrate a certified fire resistance period before receiving site entry clearance.

    Thermal Insulation.

    • UAE summer ambient temperatures regularly exceed 45 degrees Celsius.
    • Desert ground radiant heat pushes actual site temperatures even higher on remote oilfield locations.
    • ADNOC requires portacabins to maintain safe and workable internal temperatures for workers throughout the working day.
    • Roof insulation thickness, wall panel specification, and HVAC unit capacity are all evaluated during compliance assessments.

    Structural Integrity.

    • Units deployed on remote or semi-permanent ADNOC sites must carry a certified load-bearing capacity.
    • Multi-storey configurations require formal structural engineering certification for the stacking connection system.
    • Wind load resistance is a specific specification factor for coastal and offshore-adjacent project sites.

    Electrical Standards.

    • All internal wiring must comply with ADNOC’s HSE electrical safety framework without exception.
    • Requirements cover cable routing, distribution board ratings, and earthing standards.
    • Flame-retardant fittings are mandatory in applicable zone classifications on oilfield and gas processing sites.

    Environmental Resistance.

    • Desert sites require sand-sealed door and window joints and UV-resistant external coatings.
    • Coastal ADNOC sites require anti-corrosion treatment on all structural steel elements — not as an optional upgrade, but as a mandatory specification.
    • Sea air accelerates steel corrosion significantly faster than inland desert conditions, making this a critical long-term durability factor.

    ADNOC-Approved vs ADNOC-Compatible | The Distinction That Actually Matters

    This is a point that almost no published article in this space addresses directly, yet it carries serious operational and legal consequences for procurement teams.

    What “ADNOC-Approved” Actually Means

    An ADNOC-approved supplier is a company formally registered and prequalified through ADNOC’s Supplier Hub — the SAP Ariba platform that manages the entire ADNOC vendor registry. Formal registration requires completing ALL of the following steps:

    • Submitting audited financial statements for the previous one to two years.
    • Providing valid ISO certifications covering quality, environment, and occupational safety management.
    • Signing and submitting a formal HSE policy.
    • Completing ADNOC’s Integrity Due Diligence review successfully.
    • Holding a Mainland Abu Dhabi DED trade licence — either as an LLC or a Foreign Branch — with trade activities correctly aligned to the products or services being supplied.
    • Obtaining Supreme Petroleum Council (SPC) approval on the company’s trade licence. This is a legally required prerequisite for any company working directly with ADNOC or any of its 15+ subsidiary group companies.

    What “ADNOC-Compatible” Actually Means

    ADNOC-compatible is a term suppliers use to indicate that their products are designed and constructed to meet ADNOC’s published technical specifications. Critically:

    • A portacabin unit can be constructed to ADNOC-compatible standards without the supplying company itself holding formal ADNOC vendor registration.
    • The term carries no legal verification weight — it is a product claim, not a regulatory status.
    • Any supplier can use this language. Always request documentation to verify what the claim is actually based on.

    What This Means for Your Procurement Decision

    • If you are a prime contractor working directly on an ADNOC project, your portacabin supplier may need to hold formal ADNOC vendor registration.
    • If you are a subcontractor a layer removed from direct ADNOC procurement, an ADNOC-compatible supplier may be acceptable — but only if your contract terms explicitly permit this.
    • Never assume either way. Request documented compliance certificates and verify the supplier’s registration status against your contract’s procurement clauses before any vendor is shortlisted.

    The Three Non-Negotiable Compliance Pillars

    Regardless of project type, site location, or contract size, every portacabin deployed on an ADNOC project must meet three core requirements without exception:

    Safety (HSE-Certified Construction).

    • The unit must meet ADNOC’s Health, Safety and Environment standards.
    • This is mandatory for site entry approval.
    • It cannot be substituted with a general commercial compliance certificate, regardless of how it is described.

    Durability (Climate Resistance).

    • The structure must withstand the UAE’s environmental extremes for the full project duration.
    • A unit that degrades, warps, or fails structurally within six months is both a site safety liability and a financial one.
    • Desert and coastal conditions are not equivalent — verify that the unit’s durability specification matches your specific site environment.

    Speed of Deployment (Rapid Mobilization).

    • ADNOC project timelines are among the most demanding in the region.
    • Suppliers who cannot deliver and install a compliant unit within agreed timelines — often 24 to 72 hours for standard rental fleet units — are not viable ADNOC project partners.
    • Deployment speed must be a contractual commitment, not a verbal assurance.

    TYPES OF PORTACABINS USED ON ADNOC PROJECTS

    ADNOC Portacabin

    ADNOC projects across Dubai and the UAE use six primary portacabin types. The correct type for your project is determined by three variables:

    • The current phase of the project — mobilization, construction, or operational.
    • The size of the on-site workforce.
    • The specific functions that need to be supported on the site.

    Many procurement teams make the common mistake of ordering a generic site office cabin when the project actually requires a welfare unit, a medical cabin, or a multi-storey modular structure. Getting the type right from day one saves budget, prevents mid-project replacements, and avoids failed HSE inspections.

    The Six Primary Portacabin Types: A Full Breakdown

    1. Site Office Cabin.

    What it is used for:

    • Administrative work and document control.
    • Project management and coordination meetings.
    • Engineering and commercial office functions.

    Key features required:

    • Air conditioning system rated for UAE summer heat conditions.
    • LAN networking infrastructure for site communications.
    • Adequate desk space, seating, and secure document storage.
    • Sufficient electrical outlets and lighting for sustained office use.

    Typical ADNOC phase: Construction and operational phases.

    1. Guard and Security Cabin.

    What it is used for:

    • Site entry checkpoints and visitor registration.
    • Access control and workforce gate management.
    • Perimeter security monitoring.

    Key features required:

    • Compact footprint with reinforced structural construction.
    • 360-degree visibility windows for perimeter line-of-sight.
    • 24-hour operational readiness in extreme heat conditions.
    • Sufficient space for guard seating, telephone, and access control equipment.

    Typical ADNOC phase: All phases  deployed from the first day of site mobilization and removed on the last.

    Important note: Guard cabins face unbroken direct sun exposure throughout the working day. Thermal performance and structural robustness are particularly critical for this cabin type and must not be treated as secondary specifications.

    1. Labor Accommodation Cabin.

    What it is used for:

    • Workforce housing on remote sites where daily commuting is not feasible.
    • Overnight accommodation for site workforce during project construction.

    Key features required:

    • Multi-bunk sleeping configurations at appropriate occupancy ratios.
    • Mechanical ventilation and adequate air circulation.
    • Ablution facilities that meet current UAE labor welfare standards.
    • Secure personal storage for workers.

    Typical ADNOC phase: Construction phase – peak workforce deployment periods.

    Important note: UAE labor welfare accommodation standards for oilfield sites have tightened significantly in recent years, with enhanced health insurance rules and stricter accommodation requirements increasing employer costs for blue-collar workers by an estimated 15% between 2024 and 2025. Any supplier providing accommodation cabins must be current on these updated standards.

    1. First Aid and Medical Cabin.

    What it is used for:

    • On-site emergency first aid and injury assessment.
    • Worker welfare assessment and medical observation.
    • Storage and management of on-site medical supplies.

    Key features required:

    • Sterile interior surfaces and medical-grade fittings throughout.
    • Clear site access routes for emergency vehicle entry.
    • Adequate internal lighting suitable for clinical assessment.
    • Compliant ventilation and temperature control.

    Typical ADNOC phase: All phases – mandatory above a threshold workforce size.

    Important note: A standard portacabin with a first aid kit placed inside does not satisfy ADNOC’s HSE site requirements. Purpose-built medical units with appropriate fittings are required and will be assessed during HSE inspections.

    1. Welfare and Canteen Cabin.

    What it is used for:

    • Worker rest periods and scheduled break times.
    • Meal preparation and canteen service.
    • Break-room functions for rotating shift workers.

    Key features required:

    • Hygienic food-safe surface materials throughout the interior.
    • Adequate ventilation and air circulation for food preparation.
    • Seating capacity proportionate to peak shift size.
    • Potable water supply provision and appropriate drainage.

    Typical ADNOC phase: Construction phase.

    Important note: ADNOC HSE inspectors assess welfare cabins thoroughly — both for structural compliance and food safety hygiene standards. Underestimating the specification requirements for this cabin type is one of the most common and costly procurement oversights on UAE construction sites.

    1. Multi-Storey Modular Unit.

    What it is used for:

    • Large project headquarters requiring multiple departments on one site.
    • Multi-level labor accommodation camps for large workforces.
    • Permanent-style project management facilities on major ADNOC contracts.

    Key features required:

    • Structural stacking certification with engineered inter-floor connection systems.
    • Staircase access and safety barriers meeting current UAE standards.
    • Full MEP — mechanical, electrical, and plumbing — integration across all floor levels.
    • Formal structural engineering certification for the complete assembly.
    • In some cases, a formal building permit from the relevant local authority.

    Typical ADNOC phase: Large-scale operational projects with extended duration and significant workforce numbers.

    Important note: Not every portacabin supplier in the UAE who markets “multi-storey capability” has invested in the engineering infrastructure to deliver it safely and compliantly. This is one of the most significant real-world differentiators among the suppliers reviewed in this guide.

    Single Unit vs. Modular Camp Setup — Which Do You Need?

    Choosing between a single-unit order and a full modular camp depends on three key variables: workforce size, project duration, and site remoteness.

    Choose single-unit procurement when:

    • The on-site workforce is under 50 personnel.
    • The project scope requires only two to four cabin types.
    • The project duration is defined and under 12 months.
    • The site is accessible and cabins can be added or returned as the project evolves.

    Choose a modular camp setup when:

    • The workforce on site exceeds 100 personnel.
    • The project duration runs beyond 18 months.
    • The site is remote enough that daily commuting is impractical.
    • The scope requires multiple accommodation blocks, a canteen complex, a project management building, and medical and welfare facilities operating simultaneously.
    • The project is a large EPC contract where the site facility must reflect the scale and profile of the overall contract.

    Only a handful of the suppliers reviewed in this guide operate at full modular camp scale. Identifying this requirement early is critical before the shortlisting process begins.

    HOW THESE SUPPLIERS WERE SELECTED – EDITORIAL CRITERIA

    ADNOC Portacabin

    Every supplier in this guide was evaluated against six objective criteria. These are not arbitrary categories. They reflect exactly what experienced procurement officers, project managers, and HSE teams prioritize when sourcing portacabins for ADNOC project environments in Dubai and the wider UAE.

    The Six Selection Criteria Applied

    1. Verified ADNOC Compliance Track Record.

    • Documented compliance through certifications and verifiable project history on ADNOC-adjacent or oilfield sites.
    • Ability to produce technical compliance documentation on request.
    • No supplier was included based solely on verbal assurances or website marketing claims.
    1. Active UAE Operational Presence.

    • The supplier must be actively operating in Dubai and/or Abu Dhabi with the physical logistics infrastructure to service oilfield and industrial project sites.
    • Holding a UAE address on a company website is not the same as having the logistics capability to deliver a compliant unit to a remote desert site within 72 hours.
    1. Product Range Depth.

    • The ability to supply multiple cabin types across different project needs, rather than being limited to a single product category.
    • Suppliers who can grow with a project’s requirements as it scales through phases were rated higher than single-product vendors.
    1. Deployment Capability.

    • Demonstrated rapid mobilization capacity.
    • For rental fleet suppliers, this means a maintained, compliant fleet available for same-week deployment.
    • For manufacturers, this means a defined production and delivery timeline committed in writing.
    1. Client Reputation.

    • Verified references from ADNOC project environments or equivalent oilfield and industrial deployments in the UAE.
    • References from general commercial or events work were not treated as equivalent to oilfield project references.
    1. After-Sales Support Quality.

    • A defined on-site maintenance SLA with a specific response time commitment.
    • A stated emergency cabin replacement policy.
    • Accessible post-installation support with documented contact procedures.

    This guide was compiled through research into UAE construction procurement records, supplier documentation, industry feedback, and publicly available supplier track records. No supplier paid for inclusion or for their position in this guide.

    HOW TO CHOOSE THE RIGHT SUPPLIER FOR YOUR ADNOC PROJECT

    ADNOC Portacabin

    To choose the right ADNOC portacabin supplier in Dubai, work through the following six-step decision framework before any shortlisting begins. Skipping steps is where costly procurement mistakes happen.

    Define Your Project Phase.

    The cabin type you need is directly tied to the current lifecycle stage of your project.

    Is this an exploration or early mobilization phase?

    • Priority: Guard cabin, small site office, basic welfare unit.
    • Requirement: Fast deployment and compliant units on site immediately.
    • Best supplier match: Bait Al Maha.

    During the construction phase, requirements change.

    • Priority: Labor accommodation, canteen, welfare, and multi-department offices.
    • Requirement: Multiple cabin types across a phased delivery schedule.
    • Best supplier match: Al Bait Al Maha

    Finally, is this an operational phase?

    • Priority: Semi-permanent modular structures and premium-specification facilities.
    • Requirement: Multi-storey capability and long-term durability.

    Calculate Your Deployment Timeline.

    Your timeline filters your shortlist faster than almost any other factor.

    Under 72 hours required:

    • Use only suppliers with a ready rental fleet.
    • Bait Al Maha operate at this speed for standard unit types.

    Two to six weeks of lead time available:

    • Custom-fabricated units from Golden Falcon become viable.
    • The additional lead time buys a unit built precisely to your specification.

    Three to twelve months of planning time:

    • Lead time is less critical than engineering and camp setup capability.
    • Smart Space Prefab and Mister Shade ME are appropriate for this planning horizon.

    Assess Your Site Environment.

    Many procurement teams underweight this until they are sitting in a cabin that is losing structural integrity to coastal corrosion six months into a two-year project.

    Remote desert interior site:

    • Thermal insulation is the priority specification.
    • Smart Space Prefab’s climate engineering is the clearest competitive advantage in this specific context.

    Coastal oilfield or offshore-adjacent site:

    • Anti-corrosion specification is critical.
    • Verify that supplier units carry appropriate marine environment treatment ratings.

    Urban or semi-urban Dubai site:

    • Standard compliance specifications are typically sufficient.
    • Bait Al Maha will satisfy requirements at a more cost-effective price point.

    Verify Compliance Documentation.

    This step cannot be skipped. It cannot be satisfied by a verbal assurance or a website claim. Request the following documents from every supplier before signing:

    • ADNOC Technical Compliance Certificate or documented ADNOC-standard manufacturing evidence.
    • UAE HSE framework compliance evidence.
    • Dubai Civil Defence fire safety compliance certificate.
    • ISO 9001 — quality management — a baseline expectation for any serious ADNOC-focused supplier.
    • ISO 14001 — environmental management.
    • ISO 45001 — occupational health and safety.
    • Verified references from a minimum of two previous ADNOC or oilfield project deployments in the UAE.

    If a supplier cannot produce these documents promptly, that is a significant red flag regardless of how competitive their pricing appears.

    Calculate Your Total Cost of Ownership.

    Beyond the basic monthly rental rate, consider the following cost factors:

    • Delivery and installation cost — is this included in the quoted price or charged additionally?
    • End-of-project dismantling and return cost.
    • Ongoing maintenance cost over the full project duration.
    • Compliance upgrade cost if ADNOC or UAE HSE standards are updated during the project.
    • Residual value if purchasing — UAE construction market activity supports a secondary portacabin market.

    RENTAL VS PURCHASE | WHICH IS RIGHT FOR YOUR ADNOC PROJECT?

    ADNOC Portacabin

    For ADNOC projects under 12 months, renting is the more cost-effective and operationally flexible approach. For projects exceeding 12 months — particularly those involving a large on-site workforce — purchasing typically delivers better total cost of ownership and greater compliance control.

    The Rental vs. Purchase Decision Breakdown

    • Project Duration Rent: Under 12 months. Buy: 12 months or longer.
    • Upfront Investment Rent: Low. Buy: High.
    • Customization Control Rent: Limited to available stock options. Buy: Full specification control.
    • Maintenance Responsibility Rent: Primarily the supplier’s responsibility. Buy: The buyer’s full responsibility.
    • Compliance Update Obligation Rent: Often the supplier’s responsibility. Buy: The buyer’s responsibility.
    • Flexibility Rent: High — units returned when project ends. Buy: Low — capital asset commitment.
    • Best Suited For Rent: Subcontractors and phased project work. Buy: Prime contractors and long-term operational sites.

    When Renting Makes Clear Financial Sense

    • The project is a defined subcontract with a fixed completion date under 12 months.
    • Your company has no storage or asset management capacity for owned portacabins between projects.
    • The project is a first engagement in a new UAE geography and future cabin requirements in the area are uncertain.
    • Rapid mobilization within 24 to 72 hours is required, making a rental fleet the only practical supply model.
    • Maintaining compliance with potential future UAE HSE standard updates is more manageable when the compliance obligation rests with the supplier.

    When Purchasing Delivers Better Value

    • The ADNOC project runs beyond 12 months with a stable, defined workforce.
    • More than 50 workers are deployed on site, making unit count and cumulative rental cost significant over the project duration.
    • The project has specific compliance or layout requirements best met through owned, fully customized units.
    • Your company has ongoing UAE project commitments where the cabins will be redeployed after the current contract ends.
    • The UAE secondary portacabin market makes residual asset value a meaningful factor in the overall cost calculation.

    The practical rule: if your ADNOC project runs beyond 12 months and involves more than 50 on-site workers, run the full purchase calculation before defaulting to a long-term rental arrangement. At that scale and duration, the numbers frequently favor ownership.

    8 QUESTIONS TO ASK EVERY ADNOC PORTACABIN SUPPLIER BEFORE SIGNING

    ADNOC Portacabin

    Before signing with any ADNOC portacabin supplier in Dubai, procurement managers must verify compliance certification, deployment timelines, climate specifications, fire safety compliance, maintenance terms, and after-sales support commitments. The eight questions below separate genuinely reliable suppliers from those who sound reliable until something goes wrong on an active ADNOC project site.

    1. Are your units certified to ADNOC HSE technical standards | and can you provide that documentation today?

    What to look for:

    • Complete compliance documentation produced immediately on request.
    • Certificates that specifically reference ADNOC or UAE oilfield HSE standards — not generic international certifications only.
    • A supplier who needs days to “locate” their certificates is indicating exactly how seriously they manage their compliance standing.

    Red flag: Any hesitation or delay in producing compliance documents.

    1. What is your confirmed deployment timeline from signed order to completed on-site installation?

    What to look for:

    • A specific, written commitment — not a verbal promise or general assurance.
    • Separate timelines for delivery, installation, and commissioning stages.
    • A contingency plan if the committed timeline is not met.

    Red flag: “We deliver fast” without a specific timeframe confirmed in writing.

    1. Do you provide complete on-site installation, commissioning, and end-of-project dismantling services?

    What to look for:

    • Explicit confirmation that installation, MEP connections, leveling, commissioning, and end-of-project removal are all included.
    • A clear statement of what is included in the quoted price versus what is charged additionally.

    Red flag: A supplier who considers delivery to the site boundary as job complete.

    1. What thermal insulation rating do your units carry, and how does that rating perform under UAE summer desert conditions?

    What to look for:

    • A specific insulation specification — panel type, thickness, and thermal resistance coefficient.
    • Evidence that the specification has been tested or validated for UAE desert temperature conditions specifically.

    Red flag: A supplier who cannot answer this technical question with specific figures.

    1. Can you provide verified references from at least two previous ADNOC or oilfield project deployments in the UAE?

    What to look for:

    • References from oilfield or ADNOC-adjacent deployments specifically — not general construction sites or event supply.
    • Contact details for references that can be followed up directly before shortlisting.
    • A minimum of two UAE-based references with a clear project description.

    Red flag: References from general commercial projects presented as equivalent to oilfield deployment experience.

    1. What is your emergency cabin replacement protocol if a unit is damaged or fails on an active project site?

    What to look for:

    • A specific, documented emergency replacement procedure.
    • A committed response time for emergency replacement requests, stated in hours.
    • Evidence that emergency replacement has been delivered to previous oilfield clients successfully.

    Red flag: A supplier who pauses before answering or gives a vague “we will sort it out” response.

    1. Do your units comply with Dubai Civil Defence fire safety regulations?

    What to look for:

    • Documented compliance with Dubai Civil Defence requirements specifically.
    • Confirmation that both Dubai Civil Defence and ADNOC HSE fire safety standards are addressed — they are not identical requirements.
    • A specific fire resistance rating for the panel system used in the unit.

    Red flag: A supplier who conflates general fire safety compliance with Dubai Civil Defence-specific certification.

    1. What warranty period and maintenance SLA do you offer post-installation — and is the SLA response time a specific number of hours or a general statement?

    What to look for:

    • A specific warranty period stated in months, confirmed in writing.
    • An SLA with response and resolution timeframes stated in hours — not in vague terms like “promptly” or “as soon as possible.”
    • Clarity on what is covered under the warranty versus what requires an additional maintenance charge.

    Red flag: “We offer full support” without any specific time commitment attached.

    Save this checklist and use it in every supplier qualification process. It will protect your project from supplier claims that do not survive direct scrutiny.

    CONCLUSION

    ADNOC Portacabin

    Not every portacabin supplier in Dubai is built for ADNOC project work. The UAE market has hundreds of cabin vendors. The companies combining verified compliance documentation, demonstrated oilfield deployment experience, climate-engineered products, and reliable after-sales support form a significantly smaller group. The six suppliers in this guide represent the strongest options available across the full spectrum of ADNOC project requirements in 2026.

    Quick Summary – Matching Supplier to Your Scenario

    • Most ADNOC subcontractors in Dubai needing reliable compliant units fast:  Bait Al Maha Over 12 years of UAE worksite experience, 1,875+ completed deployments, and a product range covering the most common project requirements make them the most practical starting point.
    • ADNOC subcontractors looking specifically for a rental model: . Bait Al Maha  decades of UAE oilfield rental experience and a dedicated ADNOC subcontractor focus make them the most dependable rental partner on this list.
    • Projects on remote desert or coastal sites where climate engineering is non-negotiable: Bait Al Maha . Purpose-built environmental resistance credentials put them in a category of their own for extreme environment deployments.
    • Large-scale projects requiring certified multi-storey facilities: Bait Al Maha. The most capable supplier in the multi-storey and premium modular segment with no close competitor for complex configurations.
    • Bespoke compliance-engineered builds where standard units cannot meet project specification: Bait Al Maha . Custom fabrication from the ground up to the precise ADNOC project parameters.
    • The UAE construction industry is operating at full scale. With the market growing at 6.2% in 2026 to reach AED 189.59 billion, and with ADNOC’s infrastructure projects driving sustained demand for compliant site facilities, the requirement for properly sourced portacabins on ADNOC project sites is not softening anytime soon.



    FREQUENTLY ASKED QUESTIONS

    ADNOC Portacabin

    Q: What is an ADNOC-compliant portacabin?

    An ADNOC-compliant portacabin is a prefabricated modular unit that meets the Abu Dhabi National Oil Company’s HSE, structural, thermal, and fire safety standards for deployment on active oilfield and industrial sites across the UAE. The unit must satisfy the following requirements:

    • Fire resistance ratings using certified panel systems.
    • Thermal insulation performance for temperatures exceeding 45 degrees Celsius.
    • Structural load tolerances with stacking certification for multi-storey configurations.
    • HSE-framework compliant electrical installations throughout.
    • Anti-corrosion specifications for coastal site environments.

    Q: Which company is the best portacabin supplier for ADNOC projects in Dubai?

    Bait Al Maha is widely recognized as the top overall specialized supplier for ADNOC-standard portacabins in Dubai, backed by:

    • 12+ years of UAE oilfield-grade modular construction experience.
    • A completed project portfolio exceeding 1,875 UAE deployments.
    • A full product range covering the most common ADNOC project cabin types.

    Actively operating in the UAE since 2004 which is the leading choice among ADNOC subcontractors, with a dedicated oilfield rental line and over 20 years of proven deployment experience.

    Q: How much does it cost to rent a portacabin in Dubai for an ADNOC project?

    Portacabin rental prices in Dubai for ADNOC-standard units typically range from:

    • AED 800 to AED 1,500 per month for basic guard and welfare cabins.
    • AED 1,500 to AED 2,500 per month for standard site office units.
    • AED 2,500 to AED 3,500 or more per month for fully fitted, ADNOC-compliant accommodation and large office units.
    • Custom and multi-storey configurations carry additional costs beyond these ranges.

    Always request itemized pricing that includes delivery, on-site installation, and end-of-project dismantling separately from the monthly cabin rental rate.

    Q: What are the key ADNOC portacabin technical requirements?

    The key technical requirements include:

    • Fire resistance certification using rated panel systems — typically mineral wool or rock wool core construction.
    • Thermal insulation engineered for UAE temperatures exceeding 45 degrees Celsius.
    • Structural load-bearing compliance with stacking certification for multi-storey units.
    • Electrical installations meeting ADNOC’s HSE framework specifications.
    • Anti-corrosion coatings on all structural steel for coastal ADNOC sites.
    • ISO certifications — typically ISO 9001, ISO 14001, and ISO 45001 — for suppliers seeking formal ADNOC registration.

    Q: Is it better to rent or buy a portacabin for an ADNOC project?

    The decision depends on four key factors:

    • Project duration — under or over 12 months.
    • Workforce size — under or over 50 on-site personnel.
    • Customization requirements — standard versus bespoke specification.
    • Future UAE project pipeline — will the cabins be redeployed after this contract?

    For projects under 12 months, renting is more cost-effective. For projects over 12 months with 50 or more workers on site, purchasing typically delivers better total cost of ownership and compliance control.

    Q: How quickly can a portacabin be delivered to an ADNOC site in Dubai?

    Delivery timelines by supplier type:

    • Rental fleet suppliers such as Bait Al Maha : 24 to 72 hours for standard unit types from signed order confirmation.
    • Standard manufactured units from  Bait Al Maha: 3 to 7 business days depending on unit specification.
    • Custom-fabricated units from Golden Falcon: 2 to 6 weeks depending on specification complexity and order volume.
    • Multi-storey modular configurations from Bait Al Maha: Project-specific timeline confirmed at contract stage.

    Q: What is the difference between ADNOC-approved and ADNOC-compatible portacabins?

    ADNOC-approved means the supplier is formally registered on ADNOC’s vendor list through the SAP Ariba Supplier Hub. Registration requires completing ADNOC’s prequalification process, obtaining Supreme Petroleum Council trade licence approval, passing Integrity Due Diligence review, and providing audited financial statements and ISO certifications.

    ADNOC-compatible means the supplier claims their units are built to ADNOC’s technical specifications, without holding formal vendor registration. This is a product claim, not a regulatory status.

    For direct ADNOC prime contracts, approved registration status may be mandatory. For subcontractor procurement, contract terms dictate the specific requirement. Always verify which applies to your project before shortlisting any vendor.

    Q: What certifications should I request from an ADNOC portacabin supplier?

    Request the following certifications as a minimum before signing any contract:

    • ADNOC HSE Technical Compliance documentation.
    • ISO 9001 — quality management systems.
    • ISO 14001 — environmental management systems.
    • ISO 45001 — occupational health and safety management.
    • Dubai Civil Defence fire safety compliance certificate.
    • UAE HSE framework electrical installation certification.
    • Anti-corrosion treatment certification for coastal ADNOC sites.
    • Structural engineering certification for any multi-storey configurations.

    Q: Can a subcontractor use a non-ADNOC-registered portacabin supplier?

    In many cases, yes | but the following conditions always apply:

    • It depends entirely on your specific subcontract terms and your prime contractor’s procurement requirements.
    • Not all ADNOC subcontracts require the portacabin supplier to hold formal ADNOC vendor registration.
    • What is always required, regardless of the supplier’s registration status, is that the unit itself meets ADNOC’s technical and HSE specifications for the site type and zone classification.
    • Read your contract carefully, ask your prime contractor explicitly, and never assume that an ADNOC-compatible unit from an unregistered supplier will satisfy all site access and compliance requirements without prior written confirmation.
