Stacking porta cabins means placing prefabricated steel-framed units directly on top of one another, so that the weight of every upper floor is carried through reinforced corner posts and a bolted chassis rather than through the walls. The units are leveled on a reinforced foundation, connected with bolted corner castings or twist-lock connectors, cross-braced against wind, and accessed through external staircases, internal stairwells, or bridging walkways.
Here is the short version, broken down into the four facts that matter most:
- Standard site office cabins stack safely to two or three floors without special engineering.
- Weight travels through the four corner posts, not through the walls, floor, or roof panels.
- Taller stacked systems exist, usually built from modified shipping containers or engineered volumetric modules, but they need certified structural design and permanent foundations.
- Wind load, not gravity, is what actually limits stacking height on a standard steel-frame office cabin.
Everything below explains why each of these is true, what changes when stacking porta cabins in the UAE specifically, and how to decide whether a stacked, double-story, or single-story configuration is the right call for your site.
What Does Stacking Porta Cabins Actually Mean?
Before getting into the engineering, it helps to clear up a mix-up that trips up almost every first-time buyer. Stacking and joining are not the same thing.
- Joining means placing two or more cabins side by side on the same level and removing the shared wall so they read as one continuous space. This is horizontal expansion. It adds floor area but does not touch the roof line.
- Stacking means placing one cabin’s floor directly on top of another cabin’s roof. This is vertical expansion. It adds height, and it changes the entire structural conversation, because every unit below now has to carry the weight of everything above it.
Most real site office blocks combine both methods:
- Ground floor: joined side by side to create a wide reception or open-plan area.

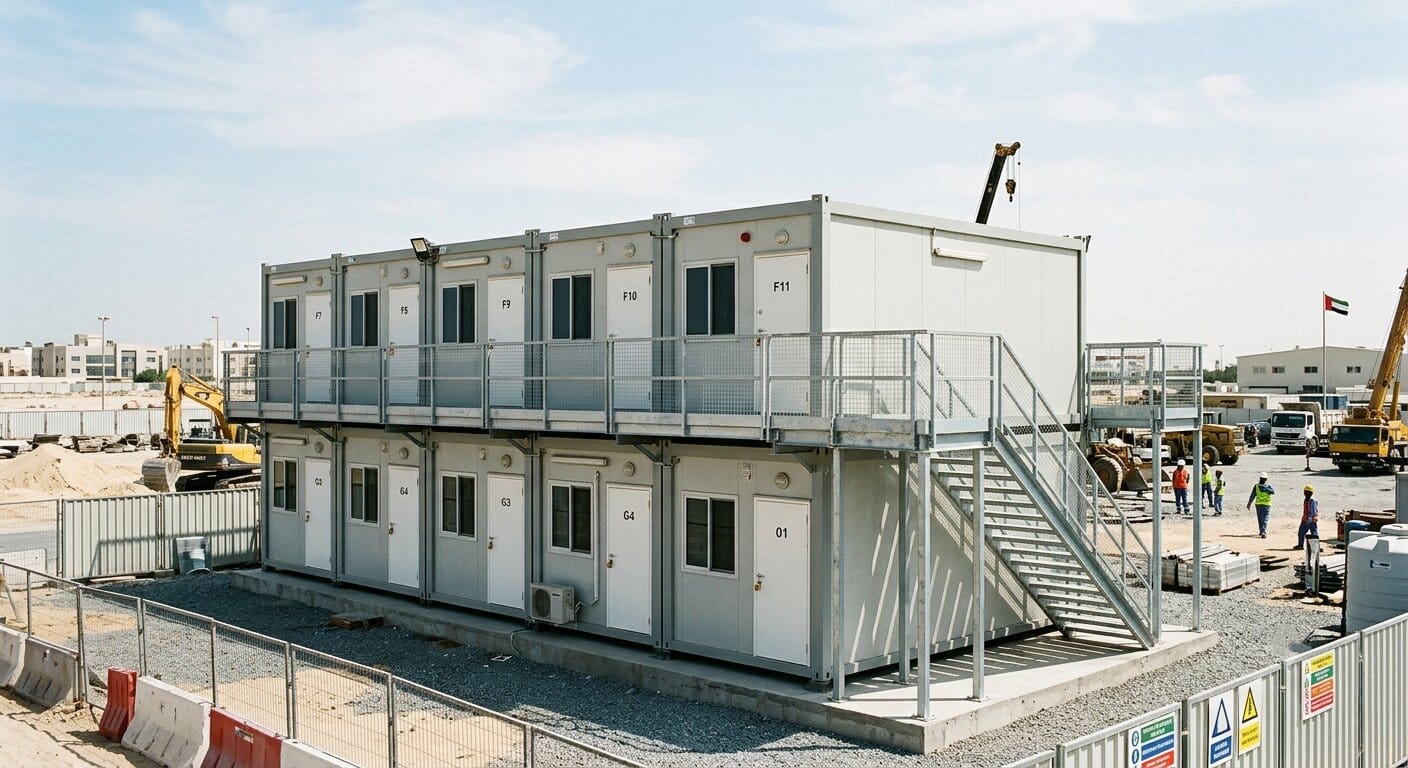

- Upper floors: stacked on top of part of that footprint to add a second or third level.
- The result: this is what people usually mean when they say “double story office” or “stacked site office block,” and it is the most common configuration requested by contractors mobilizing on constrained plots across Dubai, Sharjah, and Abu Dhabi. Real examples of this layout are on the projects page.
There are also two distinct families of stackable structures worth knowing apart:
- Modular steel-frame porta cabins – purpose-built office units with a welded steel chassis, corner posts, and insulated sandwich panel walls. This is the standard product used for most site offices in the UAE, including the range of site office and double-story office solutions built for construction and industrial projects.
- Container conversions – ISO shipping containers that have been cut, insulated, and fitted out as offices, stores, or accommodation. These share the same corner-casting logic as shipping containers, because structurally, that is exactly what they still are underneath the fit-out.
Both types stack. Both rely on the same basic physics. But they behave differently at height, in wind, and in cost, which is why the rest of this guide treats them separately wherever that difference actually matters.
Stacking Porta Cabins Safely: The Structural Mechanics Explained
This is the part most articles either skip or oversimplify. Here is the actual mechanism, explained the way a site engineer would explain it to a project manager standing next to a crane.
The Load Path Runs Through the Corners, Not the Walls
Picture a steel table. The tabletop can be glass, wood, or laminate – it does not matter, because it is not holding anything up. The legs do all the work. A porta cabin is built on the same logic.
- The four corner posts and the steel chassis beneath the floor form the “legs.”
- The walls, usually insulated sandwich panels with a polyurethane, EPS, or rockwool core, are cladding.
- The walls keep weather and noise out, but they carry none of the vertical load.
This has two practical consequences on site:
- Almost any internal layout can be specified, interior partitions can be removed, and oversized windows can be fitted without touching the structural integrity of the unit, as long as the corner posts and chassis frame stay untouched.
- A damaged wall panel is only a cosmetic repair, while a dented or corroded corner post is a structural issue that has to be assessed before that unit goes anywhere near a stack again.

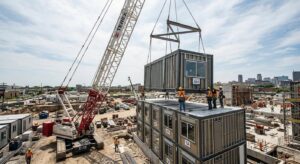

When a second cabin is placed on top of a first, its four corner posts sit directly above the first cabin’s four corner posts, and the weight travels straight down through that column of steel into the foundation. If those corner posts are even a few centimeters out of alignment, the load stops traveling cleanly through the frame and starts loading the floor or roof panel instead – components that were never designed to carry it. Corner-post misalignment is the single biggest cause of stacked cabin problems, more than any other factor, and it is a leveling issue long before it becomes a strength issue.
How the Units Actually Connect
Three connection systems dominate the market, and the choice between them says a lot about what the block is being used for.
- Bolted corner-plate connections. Steel plates are bolted through the aligned corner posts of the upper and lower units. This is the standard for office-grade porta cabins, because it creates a rigid, low-movement joint that matters when people are working at desks on the floor above and do not want to feel every gust of wind.
- Twist-lock connectors. The same cone-and-rotate fitting used to lock shipping containers together on a vessel or in a container yard. Corner castings on shipping containers are rated to carry very large loads, commonly quoted at 60 to 86 tonnes per corner casting depending on the container generation and standard, with a typical stacking test rating around 192 tonnes for the whole unit, according to container engineering references. Twist-locks are fast to install and disassemble, which is why they are common on container conversions and relocatable camps.
- Cross-bracing and diaphragm plates. Once a block goes above a single floor, diagonal steel bracing between corner posts and horizontal diaphragm plates at floor level stop the whole stack from racking sideways under wind load. This is the part that rarely gets mentioned in generic descriptions of stacking, but it is what actually keeps a two-story block rigid in a sustained crosswind rather than just resisting gravity.
How High Can Stacked Porta Cabins Actually Go?
A lot of marketing content quietly overstates this point, so it is worth being precise.
- Cargo vessels regularly carry containers stacked six to nine tiers high on deck, and up to ten or twelve tiers in the hold.
- Modular high-rise buildings using reinforced concrete cores have gone dramatically further than that. Broad Sustainable Building’s Mini Sky City in Changsha, China, reached 57 storeys using prefabricated modules.
- Residential modular towers in London and Singapore have topped 40 storeys, using a central concrete core that carries the horizontal loads while the modules themselves provide the rooms.
- Melbourne’s Collins House has been reported as reaching 60 storeys, reportedly the tallest volumetric modular building built to date.
None of this applies to a standard construction-site office cabin. Those tall modular buildings work because they are permanent structures with a reinforced concrete or steel core running the full height of the building – the modules hang off that core, and a stacked porta cabin block has no equivalent. Every floor’s weight, and every bit of wind load hitting every floor, has to pass down through the corner posts of the units below it into a foundation that is usually a concrete pad sitting on compacted ground, not a piled, engineered footing.
A stacked site office is built differently from a permanent modular tower:
- A permanent modular high-rise is engineered once, for a fixed final height, and built to that specification from day one.
- A stacked site office usually starts as a single unit that might later gain a second or third floor depending on how the project evolves.
- Because of this, the corner posts, chassis, and connection hardware on a genuinely stacking-rated cabin use noticeably heavier gauge steel than a cabin built purely for single-story use, even though the two units might look identical from the outside.
Wind is the variable that catches people off guard the most:
- A ground-floor cabin sits low to the ground, often partially shielded by fencing, other site cabins, or plant, so it sees only a fraction of the wind that a second-floor unit standing clear above the site perimeter experiences.
- A flat roof and lightweight steel frame can behave almost like a sail at height if the bracing is not sized correctly.
- Cross-bracing on a two-story block is not simply “the same bracing as one floor, doubled.” The bracing on the ground floor of a two-story stack typically needs to resist more lateral force than identical-looking bracing on a single-story unit, because it also resists the overturning force transmitted down from the floor above.
That is why the practical ceiling for a standard steel-frame office cabin, without a full structural redesign and permanent foundation, sits at two to three storeys. This is not an arbitrary manufacturer limit. It is the point at which lateral wind load on an unbraced, un-cored stack starts to exceed what bolted corner connections and a surface foundation can safely resist. Container-based systems can reasonably push toward six to eight tiers in controlled, engineered installations, but almost nobody does this for a temporary site office, since the added cost of bracing, crane access, and foundation work stops making financial sense compared with simply renting more ground.
Foundation and Leveling for Stacked Porta Cabins
A stacked block is only as good as the surface it stands on. Site-specific ground conditions matter more here than any spec sheet.
- Concrete strip foundations run under the load-bearing lines of the cabin, giving continuous support under the corner posts. This is the standard choice for a two-story block expected to stay in place for the length of a project.

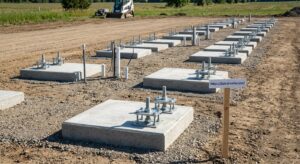

- Precast concrete pad footings sit under each corner point individually, and are faster to install than a poured strip foundation, making them a common choice when the project timeline is tight.
- Adjustable leveling jacks sit under the chassis and let installers fine-tune level after the pad is down, without repouring concrete if the ground settles slightly. These are useful, but they are a leveling tool, not a substitute for proper ground preparation.
One detail almost never makes it into a generic guide on this topic: soil condition changes this decision more than anything else.
- Coastal UAE sites, particularly reclaimed or low-lying land near Sharjah and parts of Dubai, can sit on sabkha, a soft, salt-affected soil with poor and sometimes unpredictable bearing capacity.
- A foundation design that works perfectly on compacted desert fill inland can settle unevenly on sabkha.
- Uneven settlement under a two-story stack does not just crack a slab – it throws the corner-post alignment out on the floor above.
This is why a proper civil works and foundation assessment before mobilization, rather than a generic foundation spec, is the part worth spending time on.
Five Mistakes That Actually Cause Problems On Site
Most stacking failures traced back to site visits follow a small handful of repeat causes, and none of them are exotic:
- Ordering a non-stacking-rated cabin and asking to stack it later. The chassis and corner posts either have the extra capacity built in from manufacture, or they do not. This is a decision made at the factory, not on-site.
- Skipping a proper foundation survey because the ground “looks level.” Visual level and engineered level are not the same thing, and the gap between them is exactly where settlement problems start six months into a project.
- Reusing a foundation pad from a previous single-story cabin for a new stacked configuration. The load the pad needs to carry has changed even if the footprint has not.
- Treating the second-floor air conditioning as an afterthought. Fitting the same roof-mounted unit used on the ground floor, rather than an end-wall split system, is a common source of both roof leaks and reduced cooling performance on upper levels.
- Underestimating the crane access needed. A block stacked on a tight urban plot needs a crane with the reach and clearance to lift a full cabin over existing site structures, and this is worth confirming before units arrive rather than after.
None of these require exotic engineering to avoid. They only require asking the right questions before the order is placed, rather than after the cabins are already on the truck.
Stacking Porta Cabins in the UAE: Wind, Heat, and Sand Factors
Most content on this topic is written for a UK or US audience and simply does not apply to a Gulf construction site. A handful of region-specific engineering factors change how stacking porta cabins should actually be approached in the UAE.
-
Wind bracing on upper floors.
Coastal sites in Sharjah, Dubai, and Abu Dhabi see stronger and more sustained wind loading than inland desert sites. A second-floor unit catches meaningfully more wind than a ground-floor one, simply because there is nothing around it breaking the airflow, and upper-level bracing is not the place to cut cost on a coastal project.
-
Sand and dust sealing at floor junctions.
Standard weatherproofing trims are designed with rain in mind. In the UAE, fine wind-blown sand is the bigger enemy, working into gaps at floor-to-roof junctions and around external staircases far more persistently than water does. Junctions on a stacked block need a sealing detail rated for dust ingress specifically, not just moisture.
-
HVAC placement, not roof-mounted units.
Summer surface and ambient temperatures in the region regularly climb past 45°C, so air conditioning load is heavier here than in almost any other market where porta cabins get used. Roof-mounted package units compromise the roof membrane at exactly the junction where the next floor’s foundation sits, and add dead weight at the worst possible point. Split-system units mounted on the exterior end-walls avoid both problems and are the standard specification for multi-story blocks for this reason.
-
Shading and airflow between levels.
A two- or three-story block changes how sun and wind move around the ground-floor unit compared with a standalone cabin. Covered walkways and shaded stair access are not just a comfort feature here; with the UV index regularly sitting in the 10 to 12 range through summer, exposed metal staircases become genuinely difficult to use by midday without them, and this is one of the small design details that separates a well-planned stacked block from one that just technically meets spec.
Layout Planning for a Stacked Site Office
Vertical Zoning That Actually Works On Site
Contractors who have mobilized more than one large site tend to land on a similar pattern:
- Ground floor: security, stores, labour welfare facilities, and anything that needs constant vehicle or foot access.
- First floor: site engineers, quantity surveyors, and the project management team – people who need quiet, desk-based space but do not need to be at ground level.
- Top floor: client representatives, consultants, and meeting rooms, kept furthest from site noise and dust.
This is not a hard rule, but it reflects how foot traffic, noise, and access actually behave on a live construction site, and it is a layout that comes up repeatedly across previous site office projects.
Creating Double-Height Spaces
Removing the ceiling panel of a ground-floor unit and the floor panel of the unit above it opens up a double-height reception, boardroom, or stairwell. Most guides mention this only as an afterthought, but it carries a real structural condition:
- The floor and ceiling panels are not load-bearing, so removing them does not touch the corner-post load path directly.
- It does, however, remove diaphragm support at that level, and diaphragm support is part of what keeps the stack rigid against lateral movement.
- Any double-height cutout directly above or below a run of corner posts needs a compensating beam or additional bracing worked into the design before fabrication, not added on-site after the fact.
Circulation and Fire Egress
- External staircases are the fastest and cheapest way to access an upper floor, and they are the default on most UAE site office blocks.
- Internal stairwells cost more floor area and installation time but keep occupants out of the sun and dust, and are increasingly specified for client-facing or long-duration site offices.
- Bridging walkways connect separate stacked blocks at first-floor level on larger camps.
- Fire egress distance and separation matter more on a stacked block than a single-story one, since anyone on an upper floor has only the staircase, or ideally two independent escape routes, between them and ground level. This is one of the first things reviewed during Dubai Civil Defence’s fire-safety sign-off.
A Typical Stacked Layout In Practice
A mid-size Dubai infrastructure project mobilizing a stacked office block for roughly 60 site staff usually ends up close to this layout:
- A joined ground-floor run housing security, document control, and a small stores counter near the site entrance.
- A first floor split between site engineers and the commercial team, reached by an external staircase positioned away from the main vehicle route.
- A smaller top-floor unit reserved for the client’s representative and a single meeting room, with a short bridging walkway back to the main stair rather than a second full staircase.
It is a modest footprint that would otherwise have needed close to double the ground area if built as separate single-story cabins side by side, which is usually the exact comparison a project manager is running in their head when they first ask about stacking porta cabins for their site.
Utilities in a Stacked Porta Cabin Block
Running services vertically through a stacked block takes more planning than a single-story cabin, mostly because there is no ground to trench into once you are above floor one. Getting this sequencing wrong is one of the more common reasons a stacked block needs rework shortly after handover, so it is worth planning each of the following at the design stage rather than the installation stage.

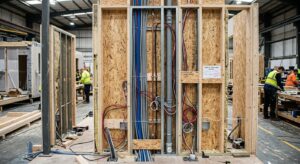

- Vertical utility chases. Channels built into the walls, floor, and ceiling at the factory stage, sized to route electrical cabling, data lines, and small-bore plumbing between floors without cutting into structural steel on-site.
- Plug-and-play manifolds. External junction points where an upper unit’s water, drainage, and electrical lines connect down to the ground-floor distribution system, designed for quick disconnect during relocation.
- Gravity drainage on upper floors. A second-floor toilet or pantry needs its waste line to fall continuously down through the chase to the ground-level connection point, without a flat or upward section anywhere along the run. On a two-story block this is manageable with careful chase design; on a three-story block, it becomes the single biggest constraint on where wet areas can actually be placed.
- HVAC. End-wall split systems rather than roof-mounted units, for both structural and thermal reasons specific to stacking.
- Electrical load distribution. A stacked block usually runs off a single incoming DEWA supply and a main distribution board on the ground floor, with sub-boards on each upper level.
- Data and networking. Structured cabling runs through the same vertical chases as the electrical lines, terminating at a small network cabinet on the ground floor near the main distribution board.
Approvals for Stacking Porta Cabins in the UAE
This is where a lot of project schedules quietly slip, because stacking porta cabins in the UAE is not a simple “buy and place” transaction. It sits inside a layered compliance structure.
Who approves what, and where:
| Project Location | Approving Authority |
| Standard Dubai construction site | Dubai Municipality – Technical Department |
| JAFZA, DAFZA, TECOM, Dubai Silicon Oasis | Respective free zone authority |
| Palm Jumeirah, Dubai Maritime City | Trakhees (PCFC) |
| Abu Dhabi projects | Abu Dhabi Department of Municipalities and Transport (DMT) |
| ADNOC oil and gas sites | ADNOC HSE Department |
On top of the location-specific authority, a temporary structure permit for a site office in Dubai typically needs additional sign-off:
- Dubai Civil Defence for fire safety.
- DEWA for the electrical and water connection, in addition to the Municipality’s structural and zoning review.
- Federal labour accommodation standards, including Cabinet Resolution No. 13 of 2009 on collective labour housing and Ministerial Decree No. 212 of 2014 for accommodation standards, layered on top of whichever emirate-level or free-zone authority governs the specific plot.
Cost of Stacking Porta Cabins: Is It Cheaper Than Adding More Ground Cabins?
This is the question that actually drives the decision, and the honest answer is that it depends on your plot, not on a fixed rule.
Stacking porta cabins tends to make financial sense when:
- The plot is small, or land value and rental cost are high relative to the cost of the additional structure.
- The project needs the extra space for its full duration, not just a few months.
- Site fencing, paving, and access roads would need to expand significantly to accommodate more ground-level cabins.
- The client or main contractor wants a single consolidated office presence rather than a scattered layout.
Spreading horizontally tends to make more sense when:
- The plot has spare open space and the project is short in duration.
- The extra crane mobilization, structural certification, and bracing cost for a second floor would outweigh the land savings.
- The site does not yet have a level, load-tested area suitable for a stacked foundation.
Where the Extra Cost Actually Goes
It helps to know which line items actually change when a project moves from a single-story order to a stacked one, rather than treating “stacking cost” as one lump figure.
- Foundation work shifts from basic leveling pads to a reinforced strip footing or precast pad system sized for the full stack weight. This is usually the first cost increase a quotation shows.
- Crane and rigging becomes a mandatory line item rather than an optional one, since upper-floor units cannot be manually positioned.
- Structural certification and drawings for the combined configuration are submitted as part of the permit package, adding both a direct fee and lead time that a single-unit purchase does not require.
- Staircases, bracing, and junction sealing hardware are physical components that simply do not exist on a ground-floor-only order.
- Ongoing maintenance runs slightly higher over the life of the project, mainly the bolt-torque and sealant checks covered further below.
None of this means stacking is expensive in absolute terms. For the right plot, it is still meaningfully cheaper than leasing additional adjacent land or moving to permanent construction. Getting an accurate like-for-like comparison for a specific plot is usually the fastest way to settle the question, and it is worth requesting a site-specific quote before finalizing a layout either way.
Stacking Porta Cabins vs. Building a Permanent Second Floor
For a project office that only needs to exist for the length of a contract, typically one to three years on most UAE developments, permanent construction rarely makes sense:
- It ties up capital in an asset that has to be demolished or sold off at project close.
- It takes considerably longer to get through design and permitting before anyone can move in.
- It cannot be relocated to the next project once this one finishes.
A stacked modular block, by contrast, is manufactured off-site in parallel with early site mobilization work, arrives largely fitted out, and can be unstacked and redeployed elsewhere once the project ends. Permanent construction only wins outright in one scenario: indefinite, decades-long occupancy, which is almost never what a construction-site office actually needs.
Maintenance and Lifecycle of a Stacked Porta Cabin Block
A stacked block is not a “set it up and forget it” asset the way a single cabin can sometimes be treated. A few inspection habits protect both the structure and the people using it:
- Corner-post inspection. Check for corrosion, dents, or deformation at each connection point, especially after the first heavy wind season, and annually as a standing rule after that.
- Bolt torque re-checks. Bolted connections can loosen slightly as steel expands and contracts through the UAE’s summer-to-winter temperature swing. A re-torque check after the first summer, then annually, catches this before it becomes a movement problem.
- Sealant reapplication at floor junctions. Given the sand and dust exposure covered earlier, junction sealant on a stacked block needs more frequent attention than on a single-story unit. Inspect at least twice a year rather than waiting for a visible leak.
- Relocation. Unstacking, transporting, and re-stacking at a new site is a real and fairly routine service, not a rebuild, and Bait Al Maha’s relocation service is built around exactly this process, including foundation blocks, air conditioning units, and site fencing.
- Refurbishment and re-certification. Ex-rental stacked units, when properly maintained, can usually be refurbished and re-certified for a new project rather than scrapped, which is both the more economical and the more sustainable route for contractors cycling through multiple sites over several years.
Single-Story vs. Stacked Porta Cabins vs. Container Stack
| Factor | Single-Story Cabin | Stacked 2–3 Story Block | Container Stack (Engineered) |
| Foundation | Basic pads | Reinforced strip or precast footing | Engineered permanent footing |
| Approval complexity | Low | Moderate | High |
| Typical achievable height | 1 floor | 2 to 3 floors | Up to 6 to 8 floors with full engineering |
| Structural core needed | No | No | Sometimes, for anything beyond a few floors |
| Best suited for | Small or short-duration sites | Constrained urban plots, mid-size projects | Long-term labour camps or dense accommodation needs |
| Typical UAE example | Guard rooms, small site offices | Site management HQ, consultant cabins | Large-scale labour accommodation |
Frequently Asked Questions
Can porta cabins be stacked on top of each other?
Yes. Cabins built with a reinforced steel chassis and corner posts can be stacked, usually up to two or three floors, using bolted or twist-lock connections.
How many floors can a stacked porta cabin have?
Most standard office cabins stack safely to two or three floors. Container-based systems can go higher with certified structural engineering.
Do stacked site offices need approval in the UAE?
Yes. A stacked configuration needs municipality or free zone approval, plus separate sign-off from Civil Defence for fire safety and DEWA for utilities.
Do stacked porta cabins need a special foundation?
Yes. A reinforced strip footing or precast pad system is needed to carry the added weight, sized to the site’s soil conditions.
Can a single-story cabin be converted into a double-story unit later?
Only if it was built with a stacking-rated chassis from the start. Retrofitting an unrated unit is rarely cost-effective.
Is a crane required to stack porta cabins?
Yes. Upper-floor units are too heavy to position by hand and need precise, controlled placement by a certified rigging crew.
Are stacked porta cabins safe in strong wind or sandstorms?
Yes, when properly braced and sealed for the region. Cross-bracing handles wind load, and dust-rated sealing protects floor junctions.
Can a stacked porta cabin block be relocated?
Yes. The same bolted or twist-lock connections that allow assembly also allow disassembly and reinstallation at a new site.
How long does it take to install a two-story site office?
Once the foundation is ready, physical stacking is usually completed within a few days. Permit approval typically takes longer than the installation itself.
The Bottom Line
Stacking porta cabins works because the engineering does almost everything a permanent building’s structure does, just through a bolted steel frame and reinforced corner posts instead of poured concrete and rebar.
- Get the corner alignment, the foundation, and the wind bracing right, and a two- or three-story site office block will perform reliably for the length of a project and beyond.
- Skip any one of those, particularly on a coastal UAE plot with soft soil or high wind exposure, and the same block becomes a maintenance problem within a year.
If you are weighing a stacked site office, double-story consultant block, or container-based configuration for a project in Sharjah, Dubai, or Abu Dhabi, Bait Al Maha’s team can walk through the foundation, layout, and approval requirements specific to your plot:
- Browse the full site office and prefab cabin range.
- See how past blocks were delivered on the projects page.
- Get in touch directly for a site-specific feasibility check, or message the team on WhatsApp for a fast quote.
